Developer: Object 1 Development · Jumeirah Village Circle

The Fifth Tower

The Fifth Tower is a residential project by Object 1 Development in Jumeirah Village Circle, Dubai, with planned handover Q3 2026, construction 50.3% complete per the DLD registry, 345 units, 389 DLD-registered sales since 2013.

Planned handoverQ3 2026Developer supplied
Construction50.3%DLD registry · checked 04.08.2026
Units345DLD registry
DLD sales389 since 2013DLD registry
Median sale priceAED 14 730/m²Our calculation

Every figure carries its origin: “DLD registry” is taken from the Dubai Land Department register, “Developer supplied” is stated by the developer, “Our calculation” is computed by us from the first two. Developer prices change without notice — confirm before you commit. Methodology

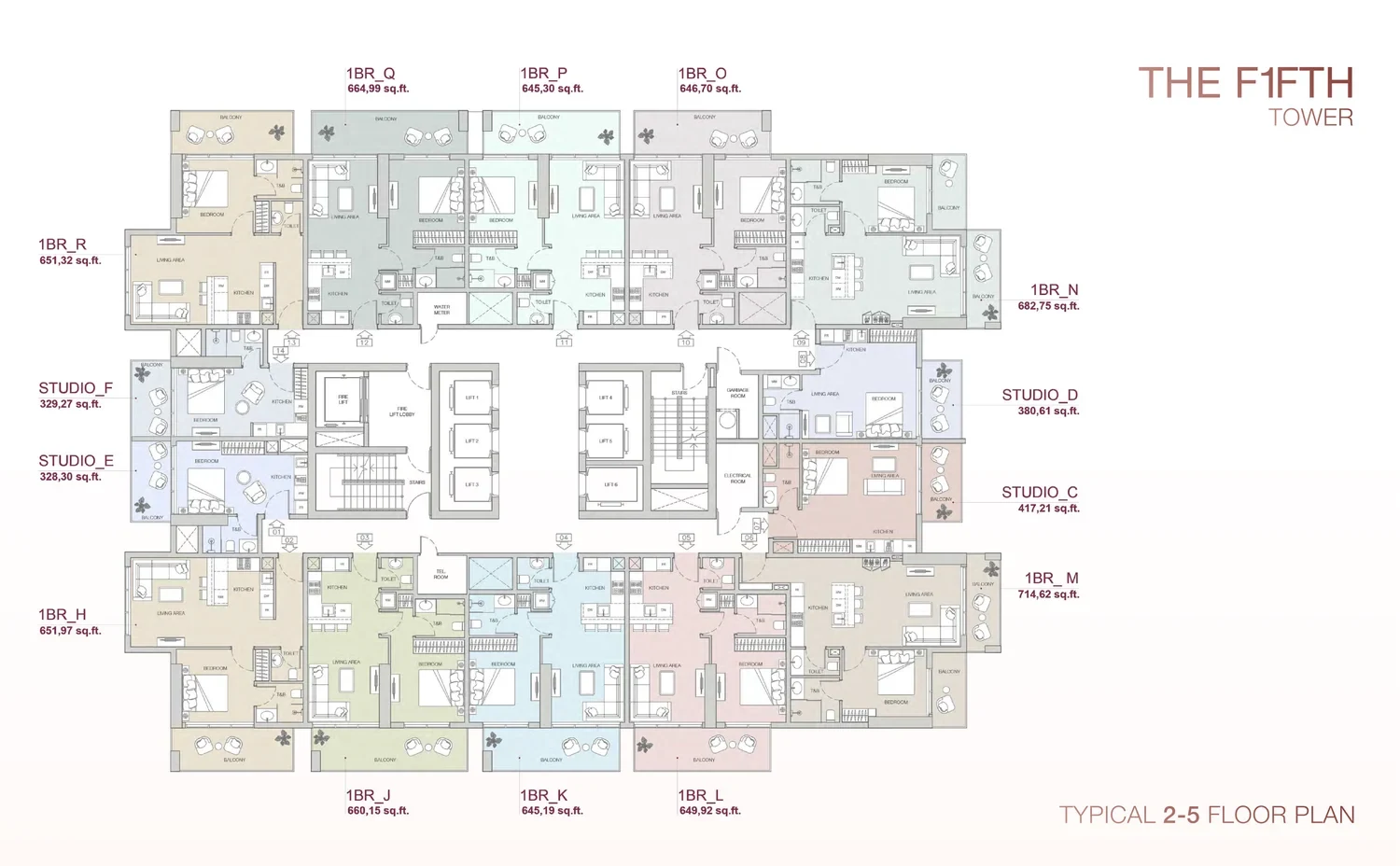

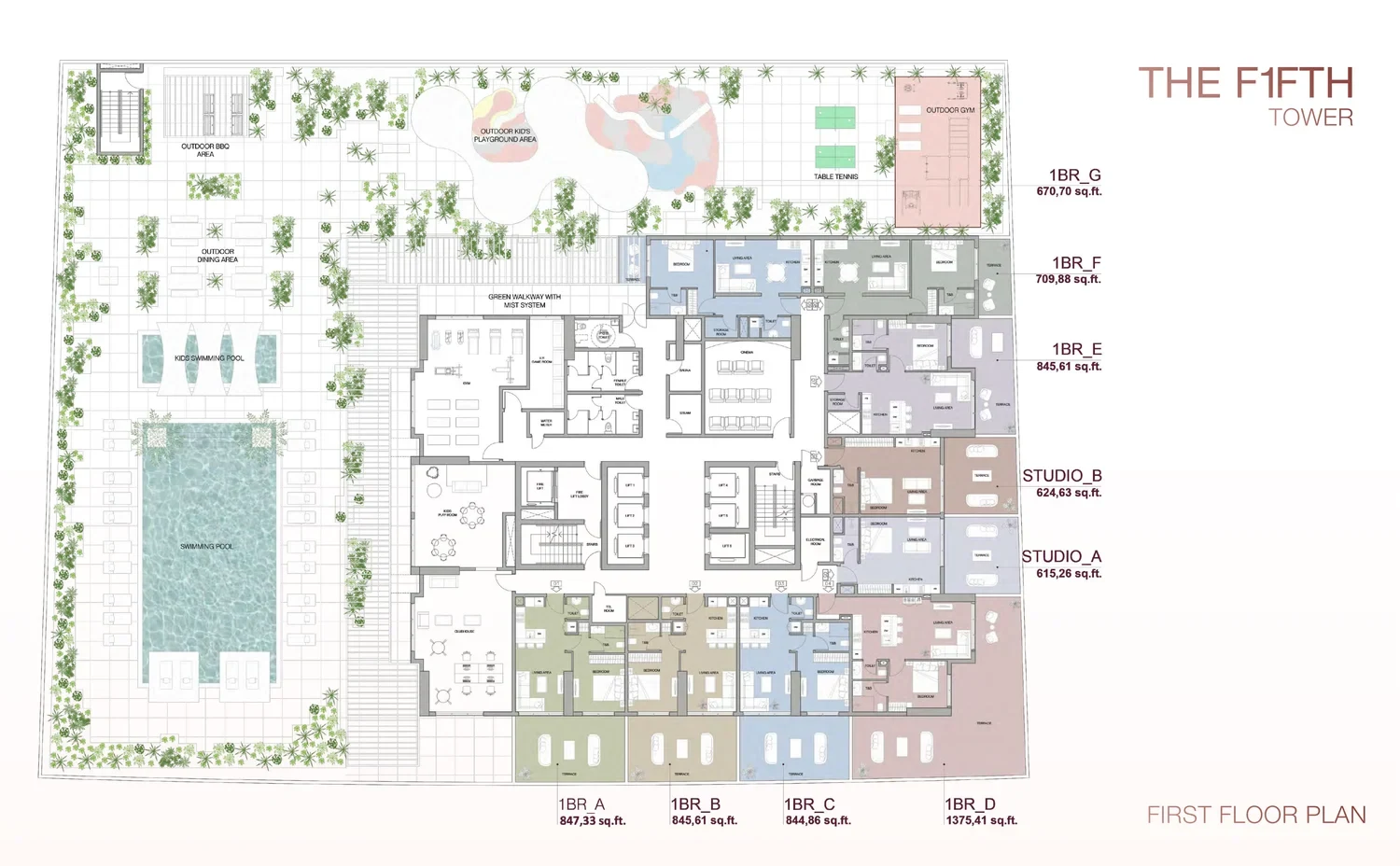

Layouts and sizes

TypeUnitsTypical size, sq.ft
Studio34326–485
1 Bedroom256646–682
2 Bedroom501 114–1 117
Other units5854–3 296

Size range excludes the smallest and largest 5% of units of each type.

All units are freehold. Data from the DLD registry.

Mortgage for this project

For UAE residents the down payment starts at 20% with terms up to 25 years. Estimate your payment and purchase costs for your budget.

Calculate mortgage

Estimates only; not a bank approval.

Handover date & construction progress

50.29%
  • Construction started20.03.2024
  • Planned handover (developer)Q3 2026
  • Status date04.08.2026
  • Progress between DLD inspections+5.02% (17.04.2026 → 04.08.2026)
  • Escrow bankADIB
  • DLD project number3048

Data from the Dubai Land Department project registry (updated 11.10.2026 09:55).

Inspection history 7
025507510002.07.202404.08.2026
Actual, per inspections

Pace: 1.43% per month. At this rate 100% falls on 28.06.2029.

The pace is calculated from the past year of inspections. It is an estimate, not a developer commitment. For reference: across 1,175 completed projects the median pace is 2.48% per month and the median build takes 40 months.

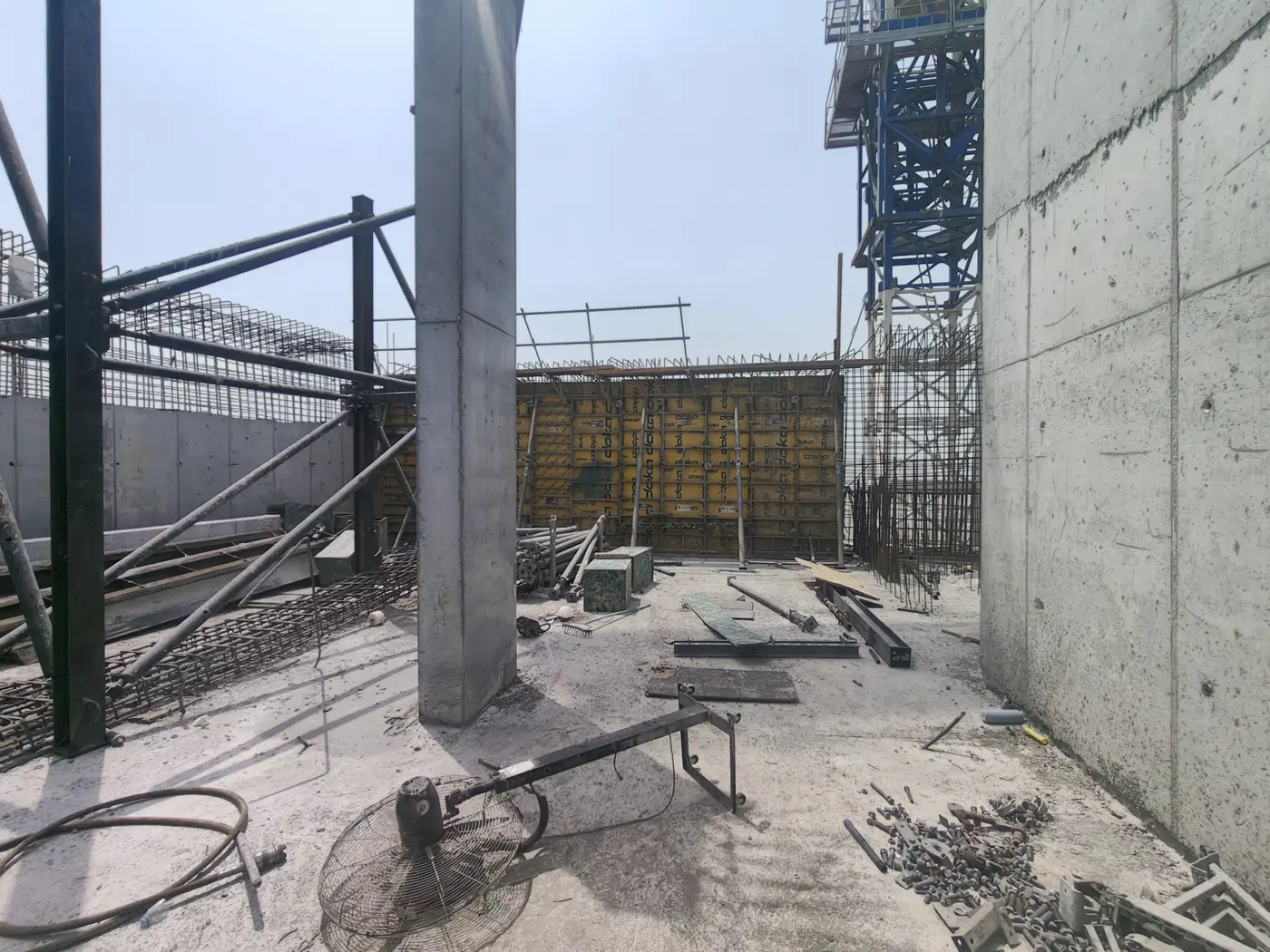

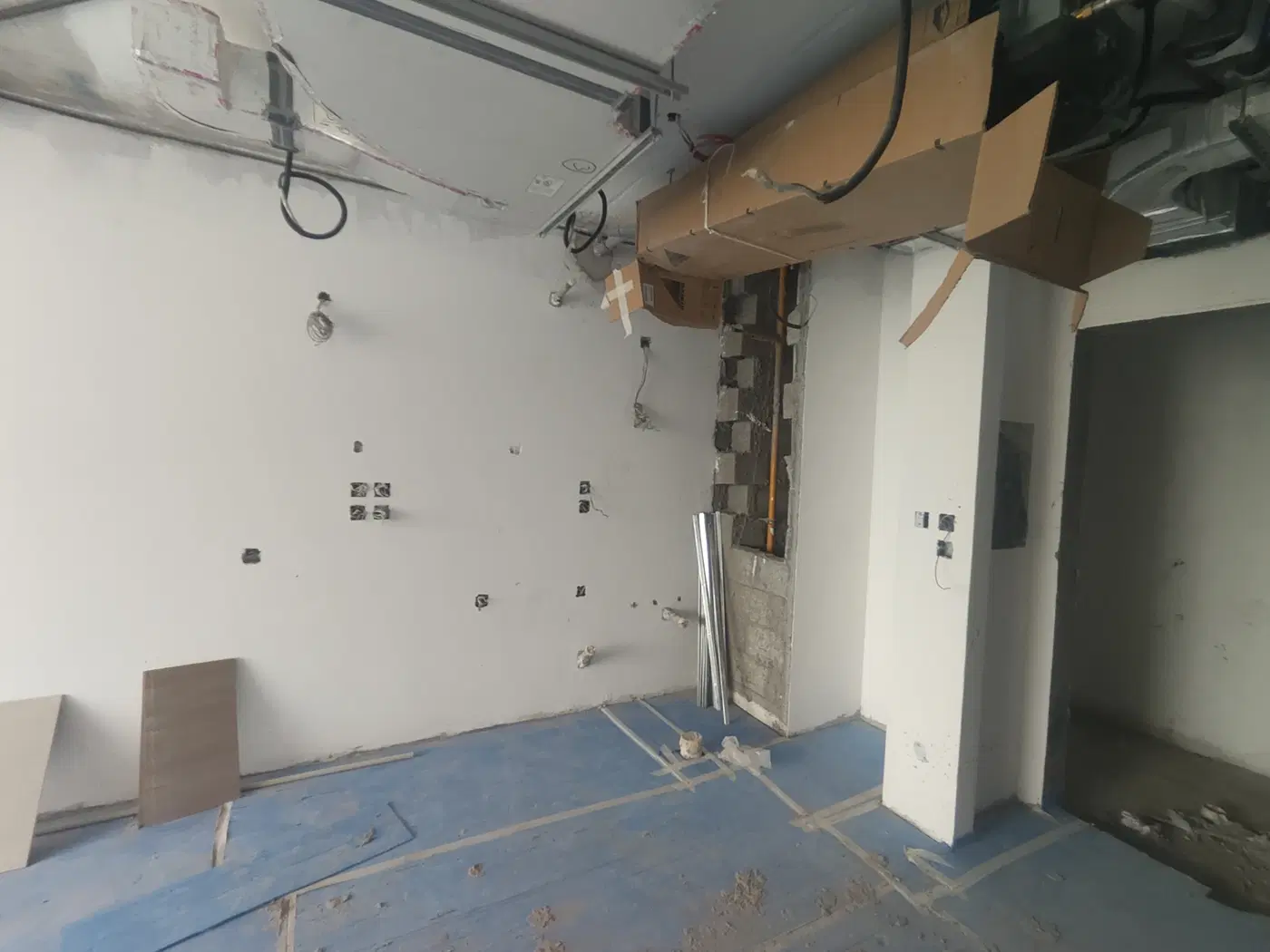

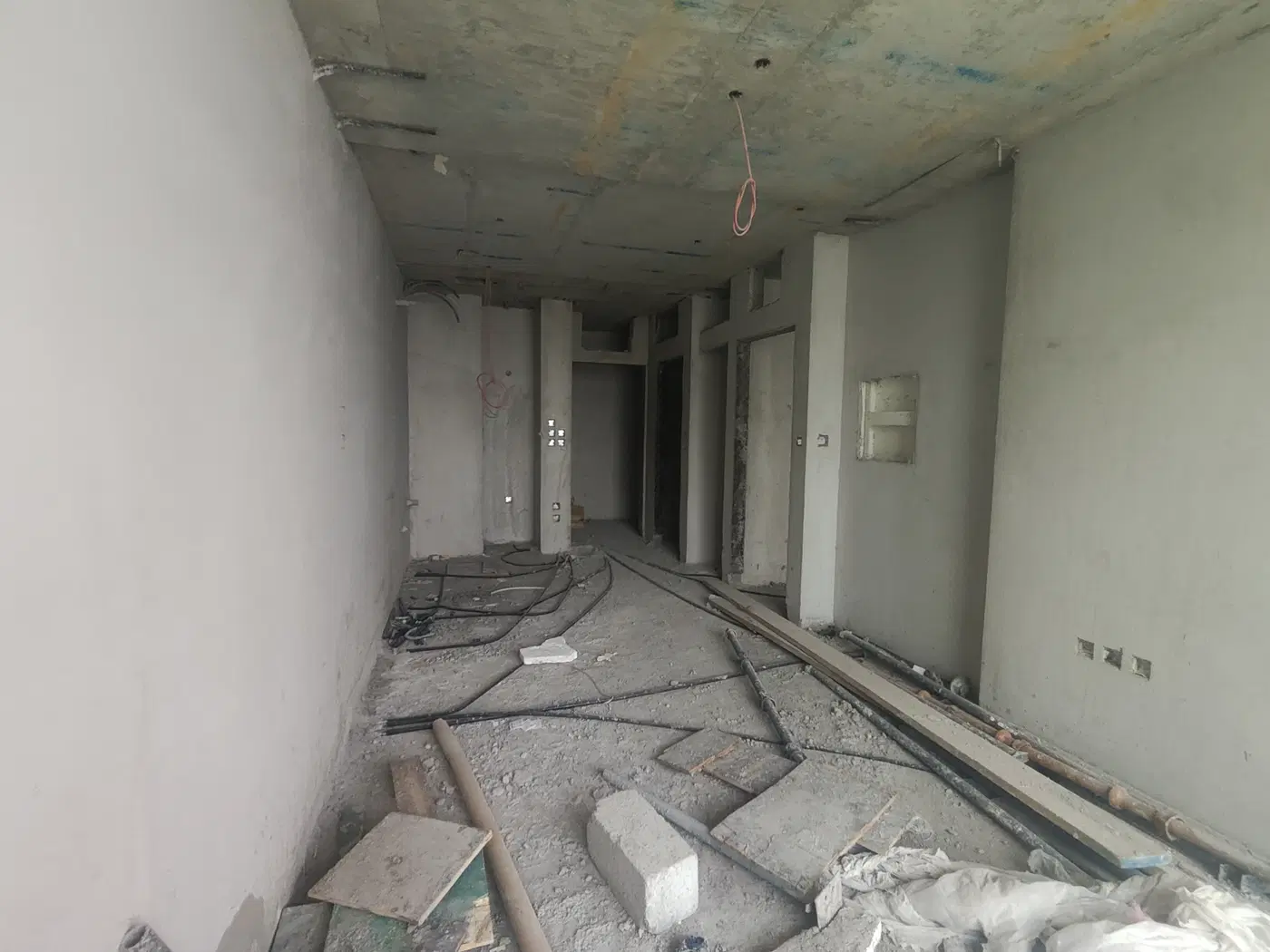

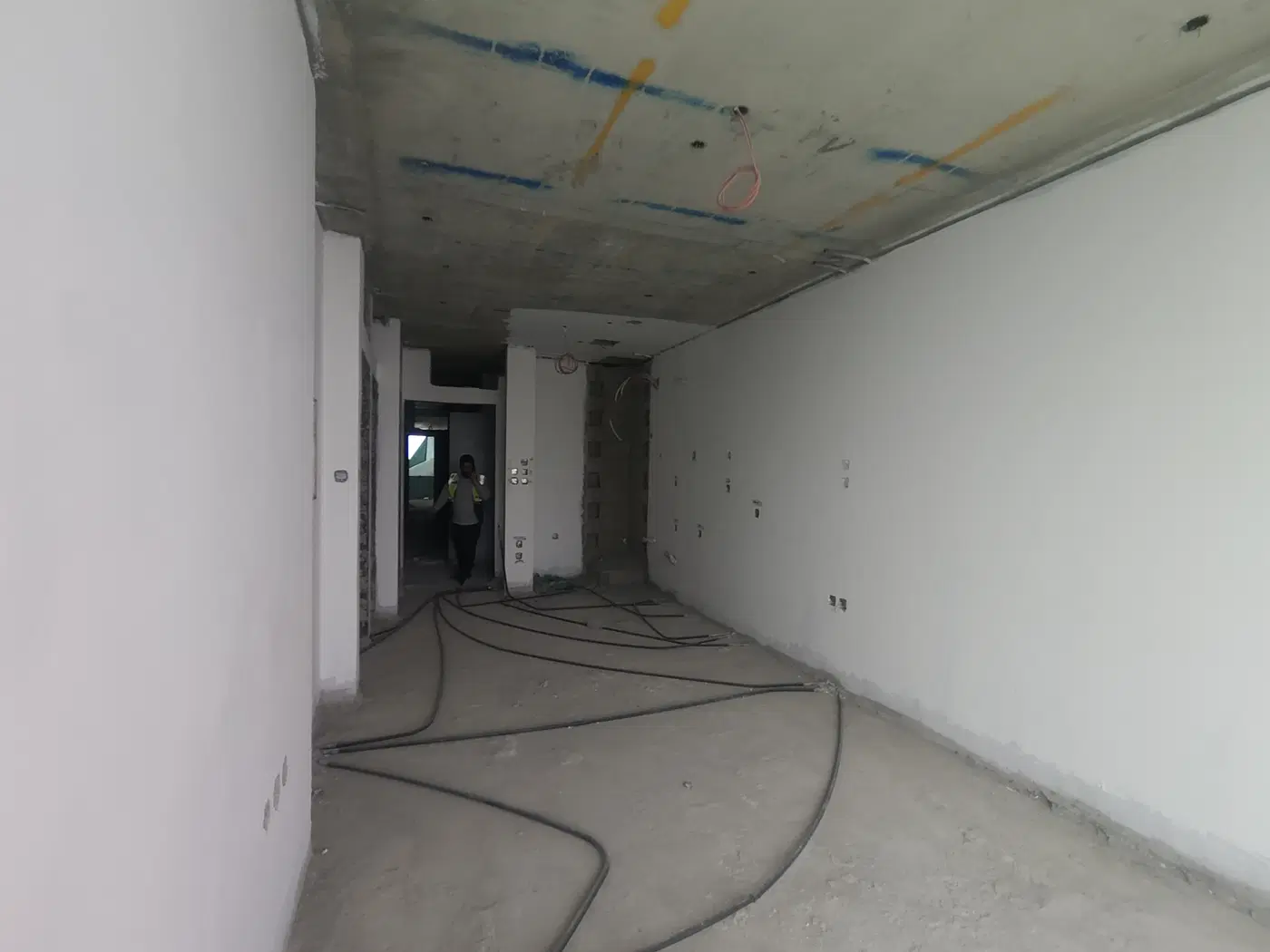

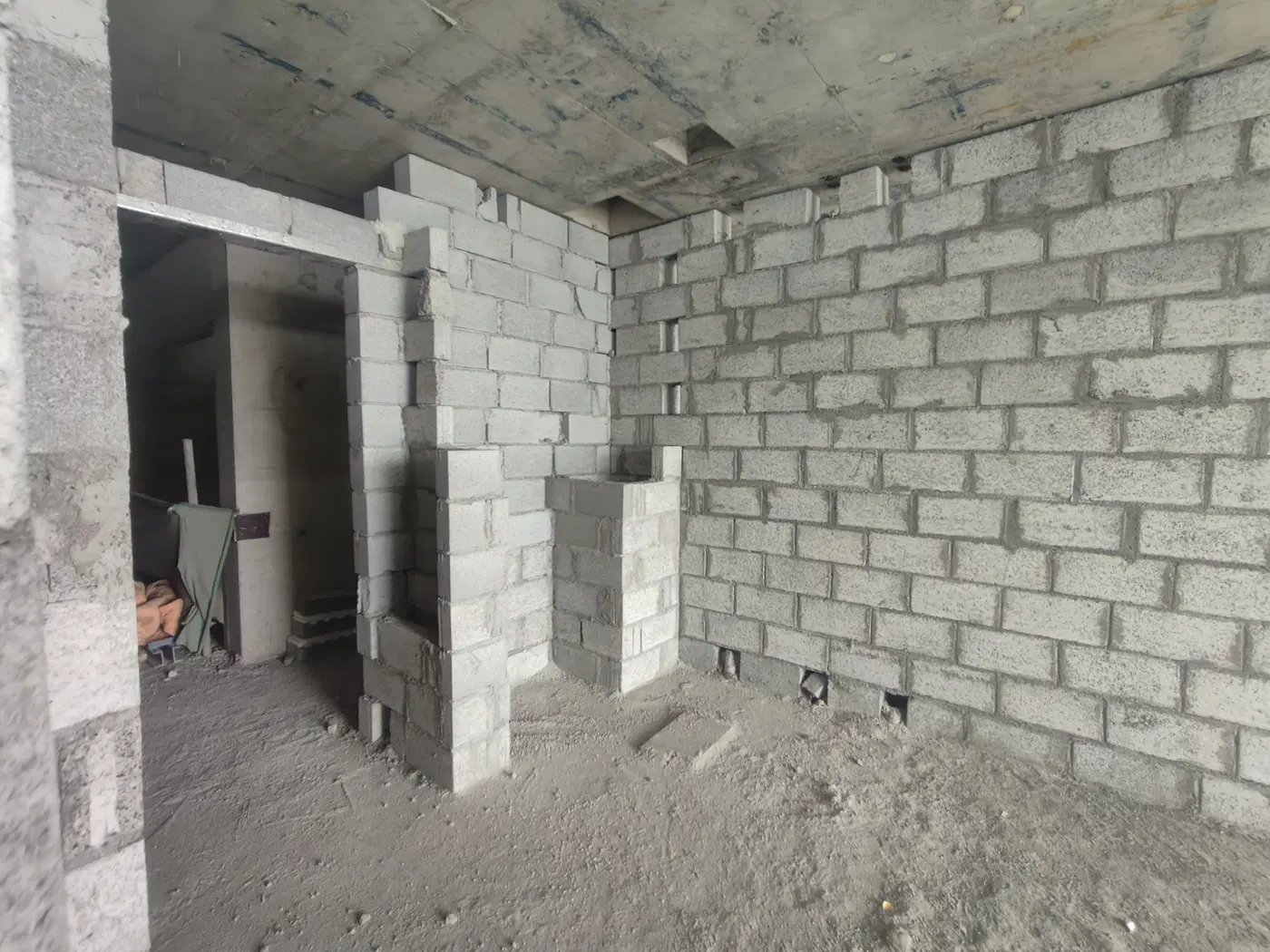

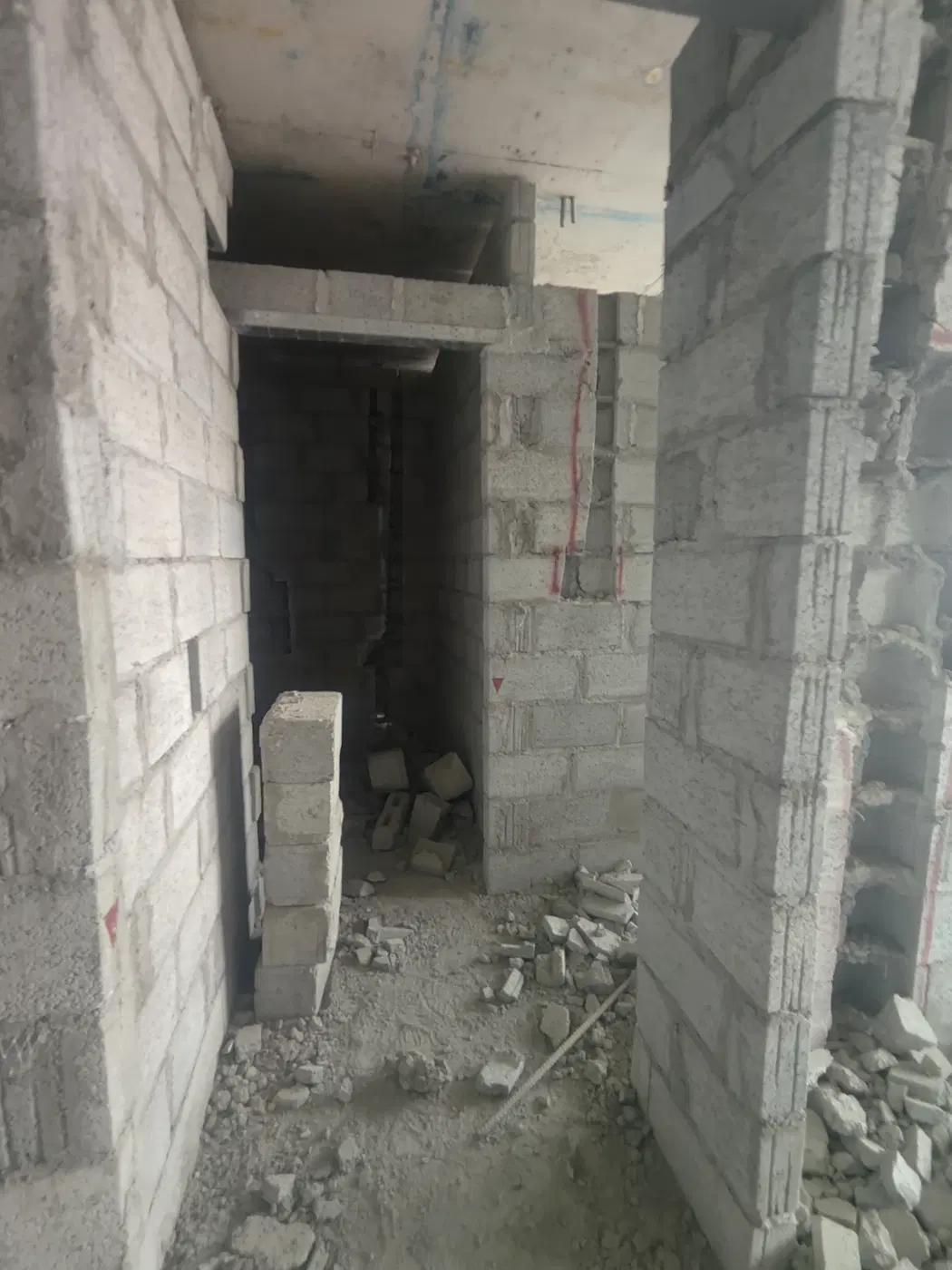

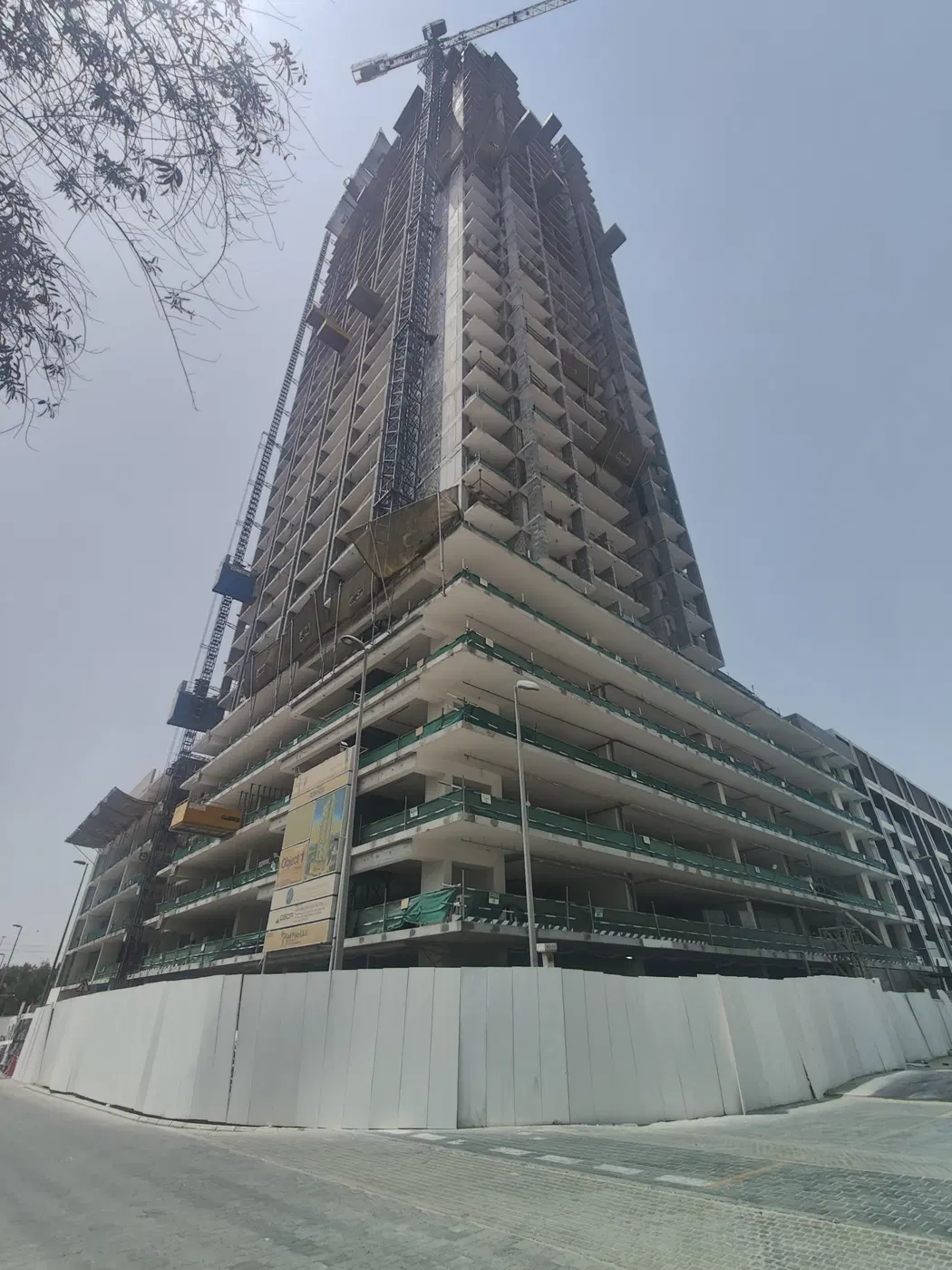

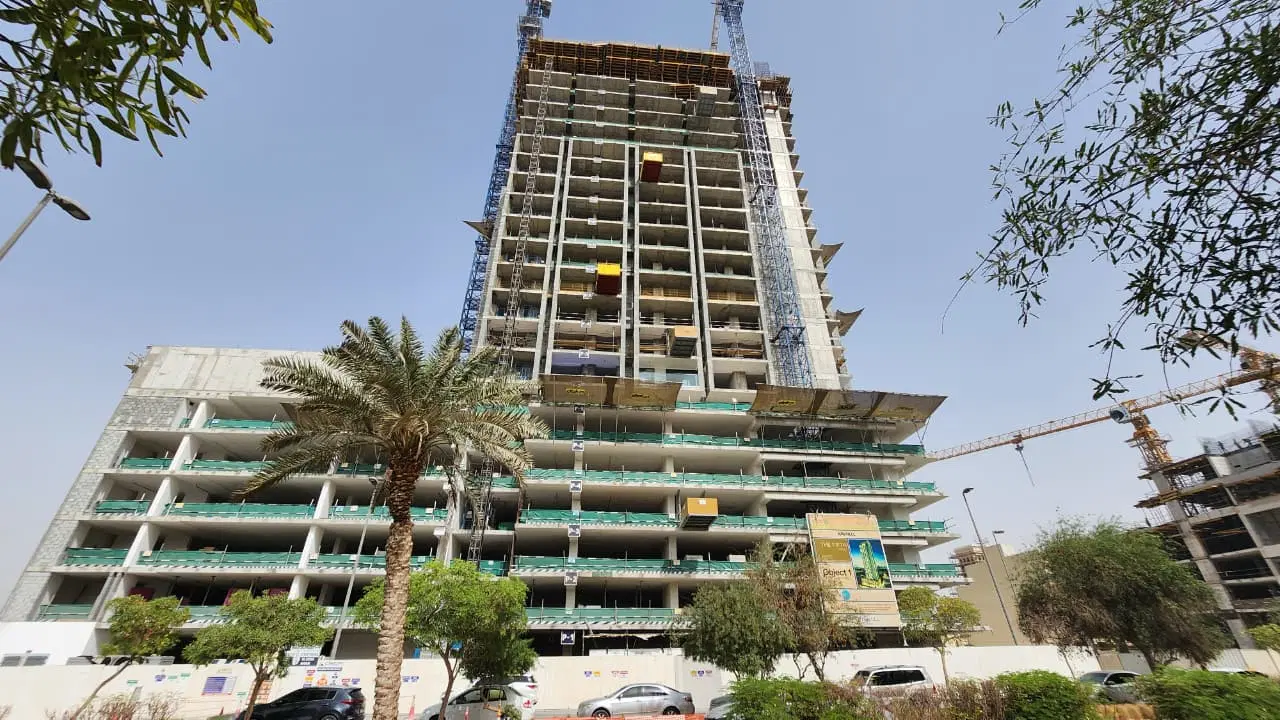

Construction progress 101

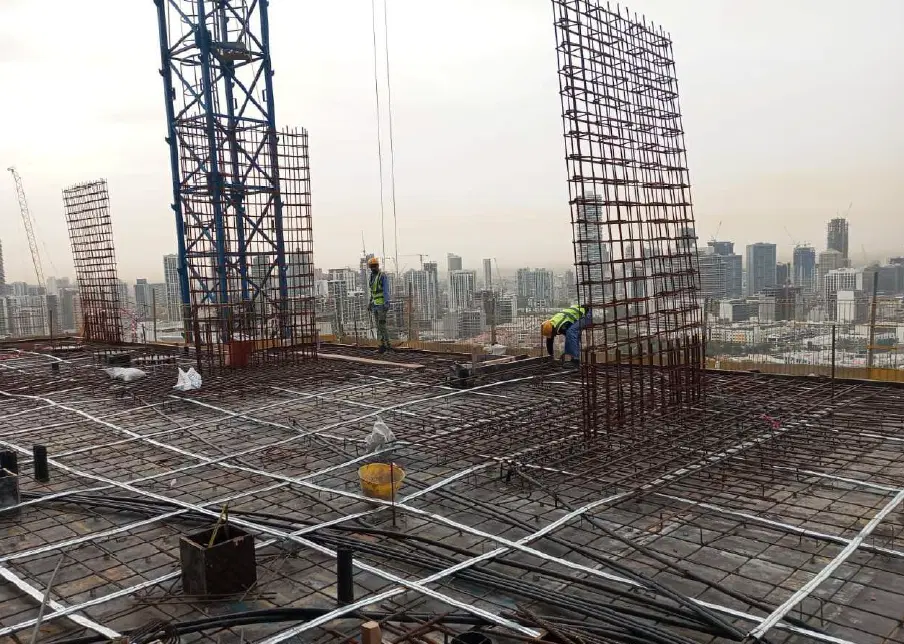

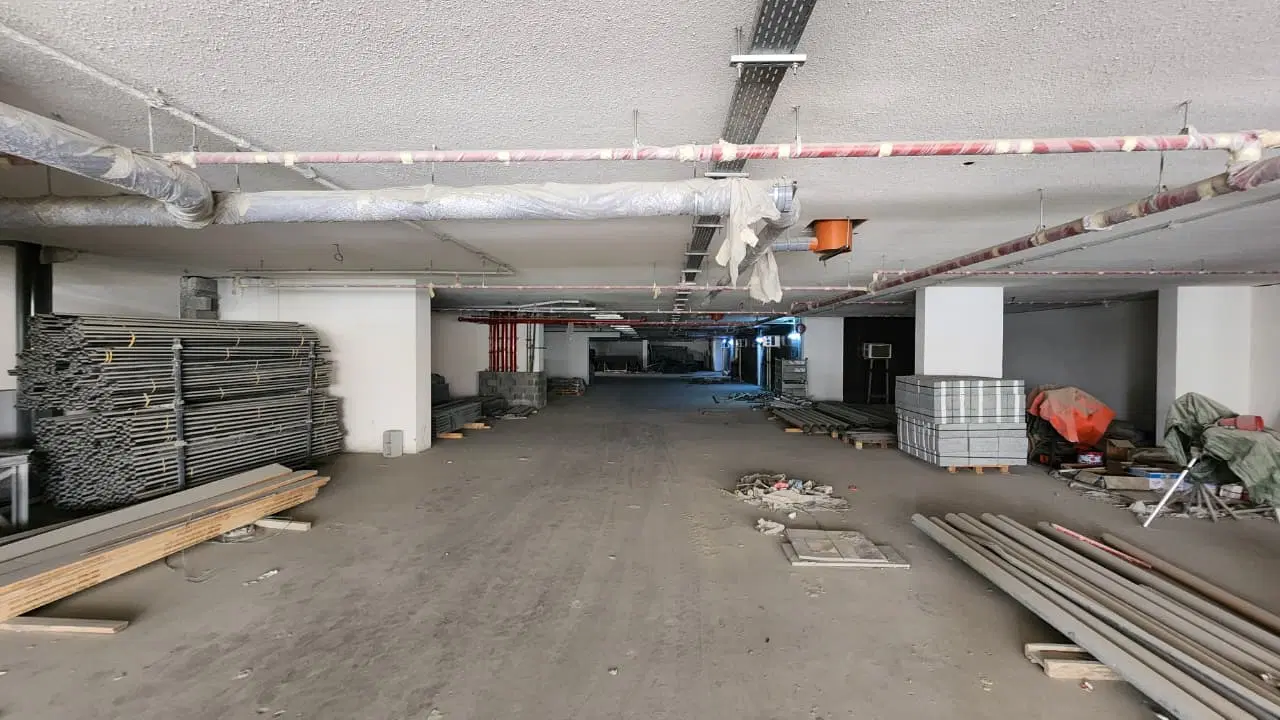

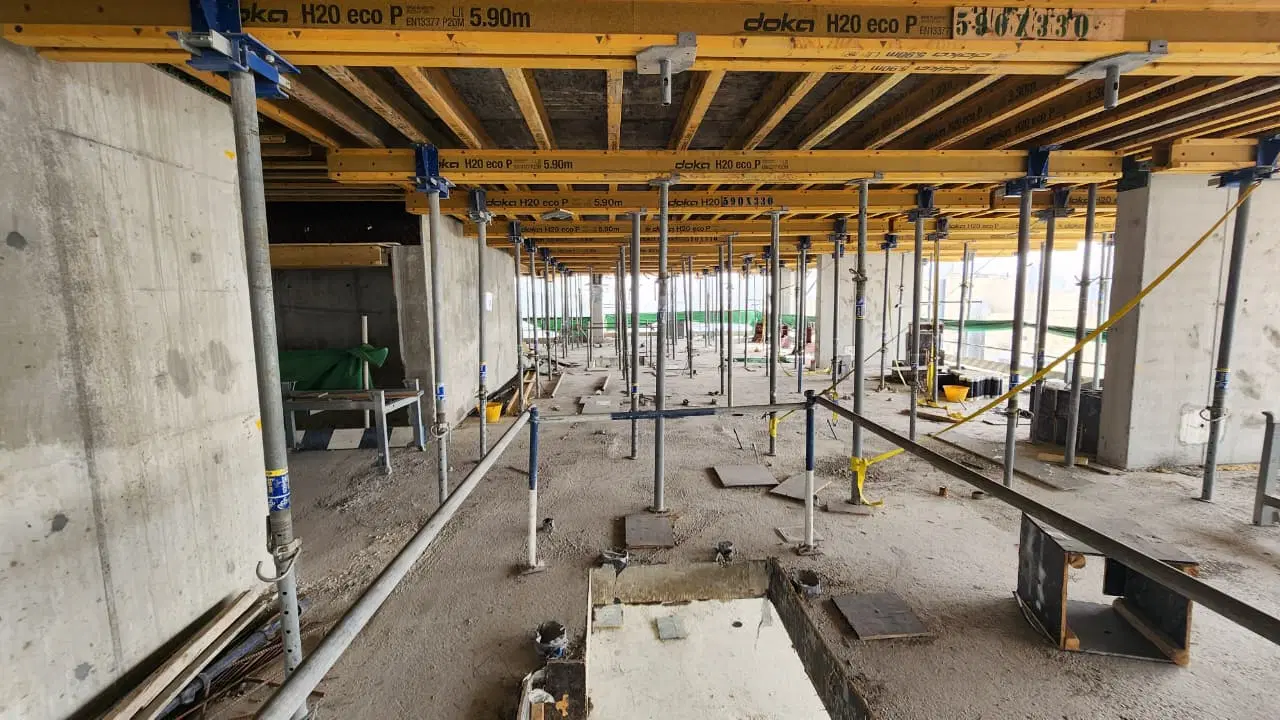

04.08.2026 50.29%

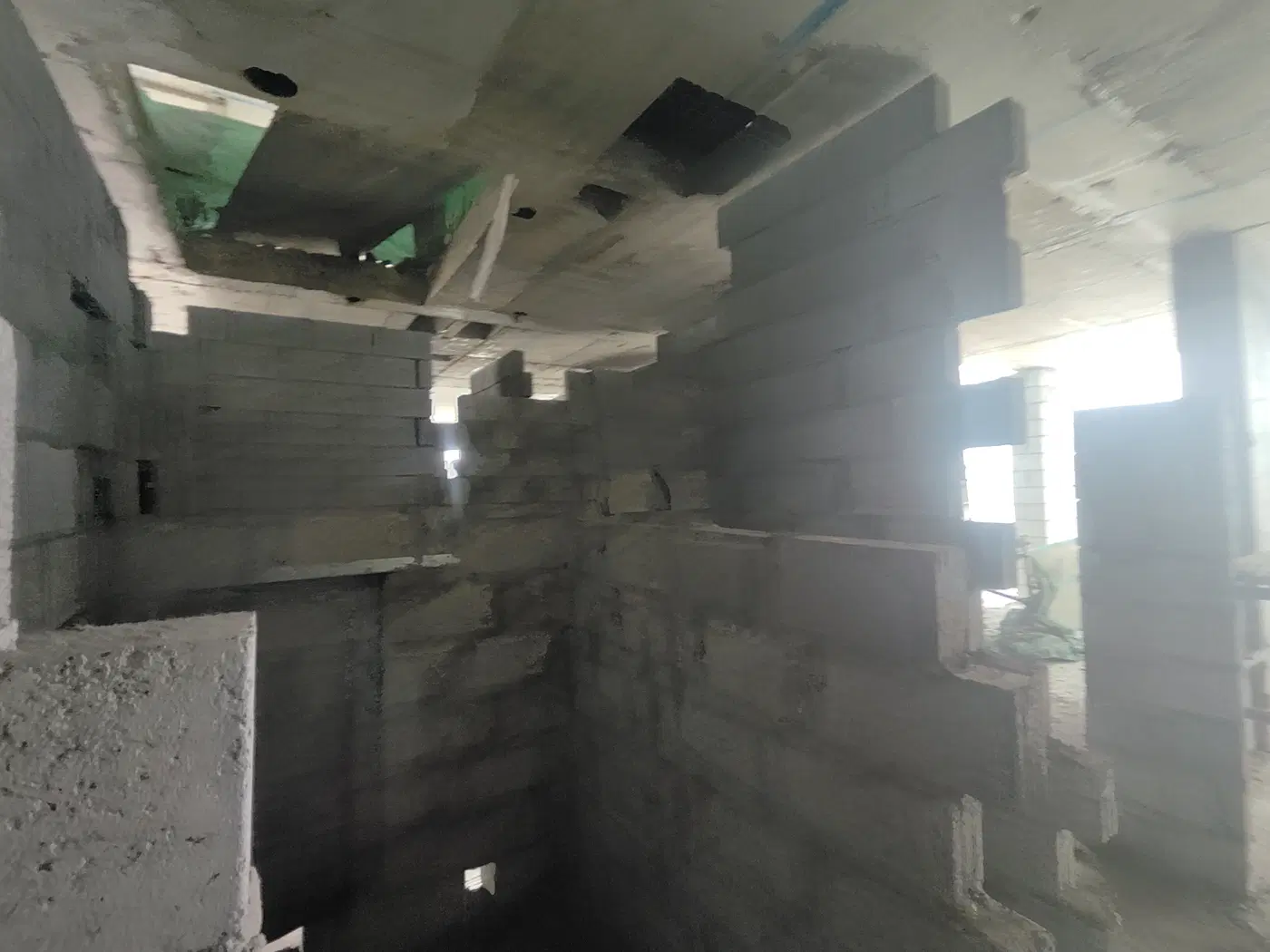

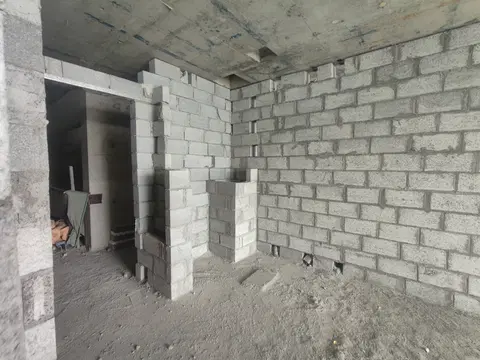

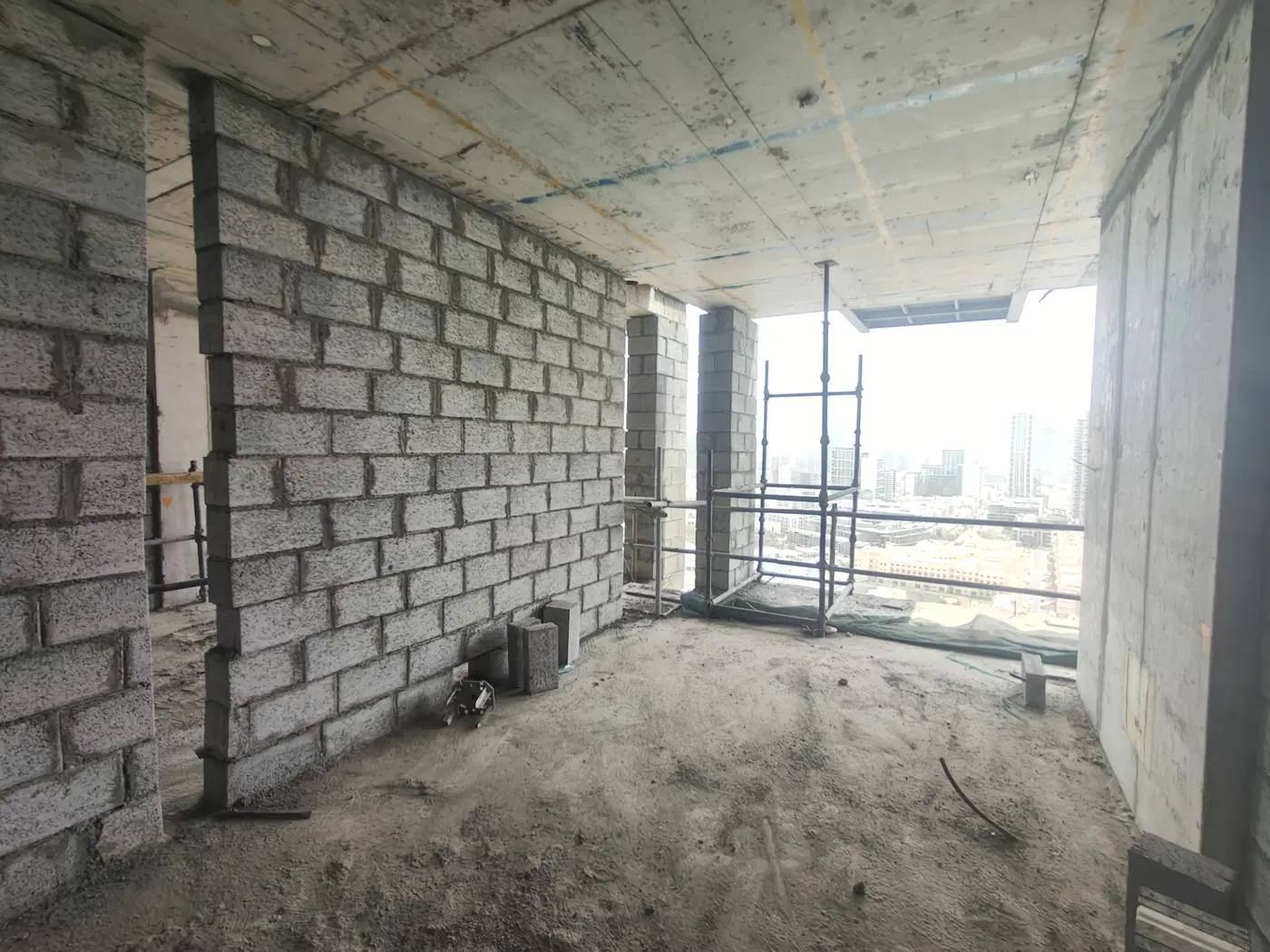

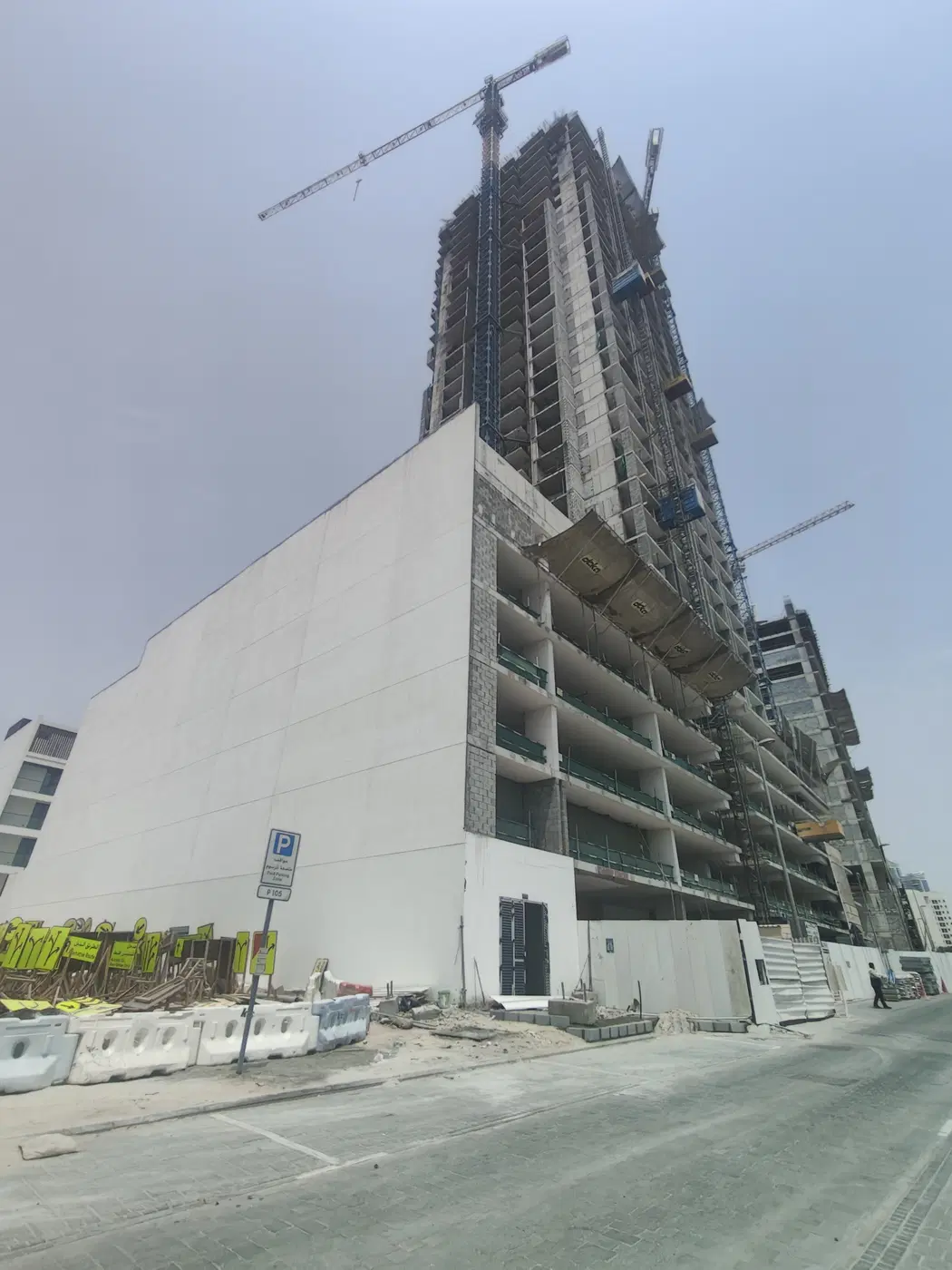

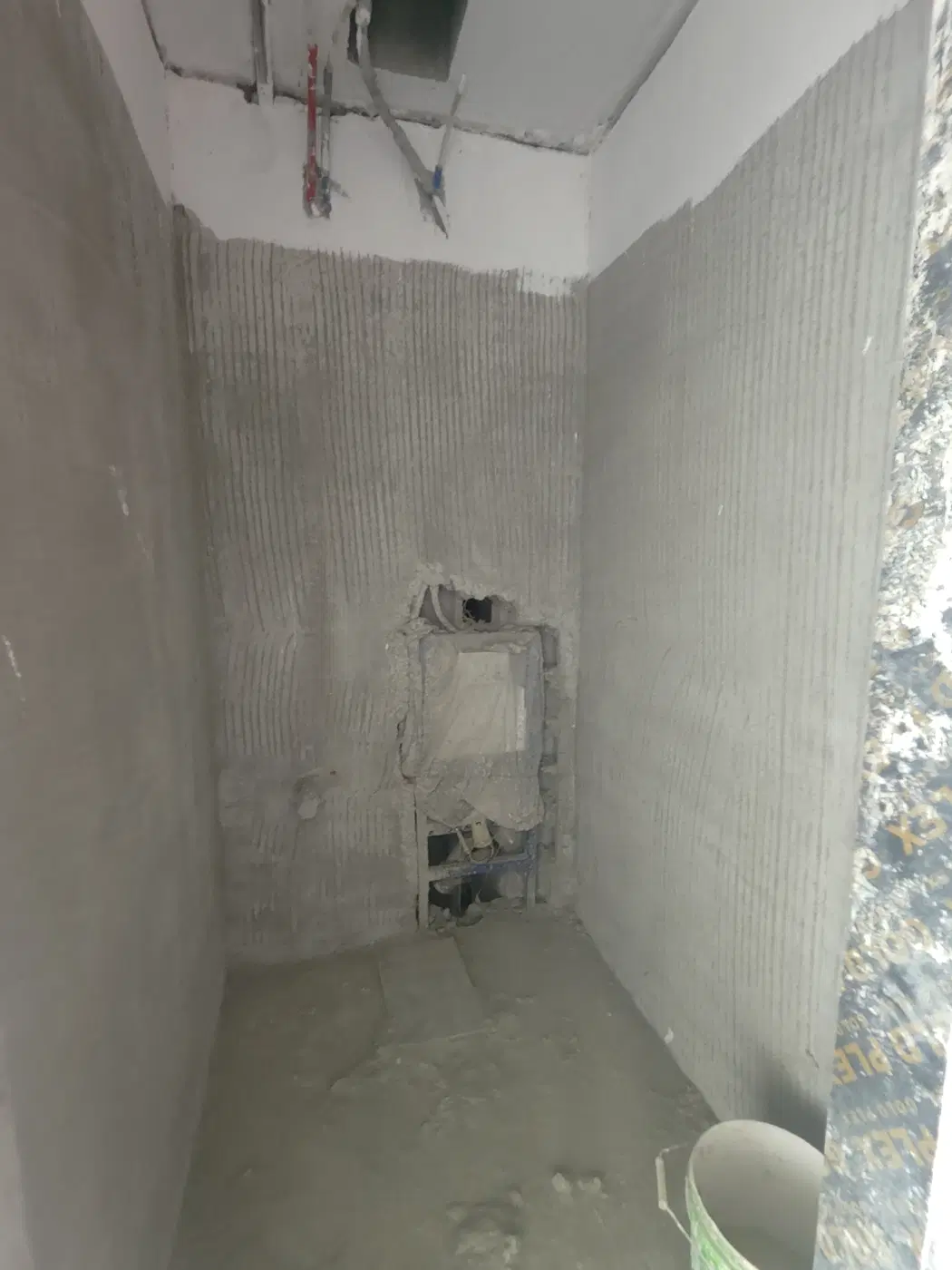

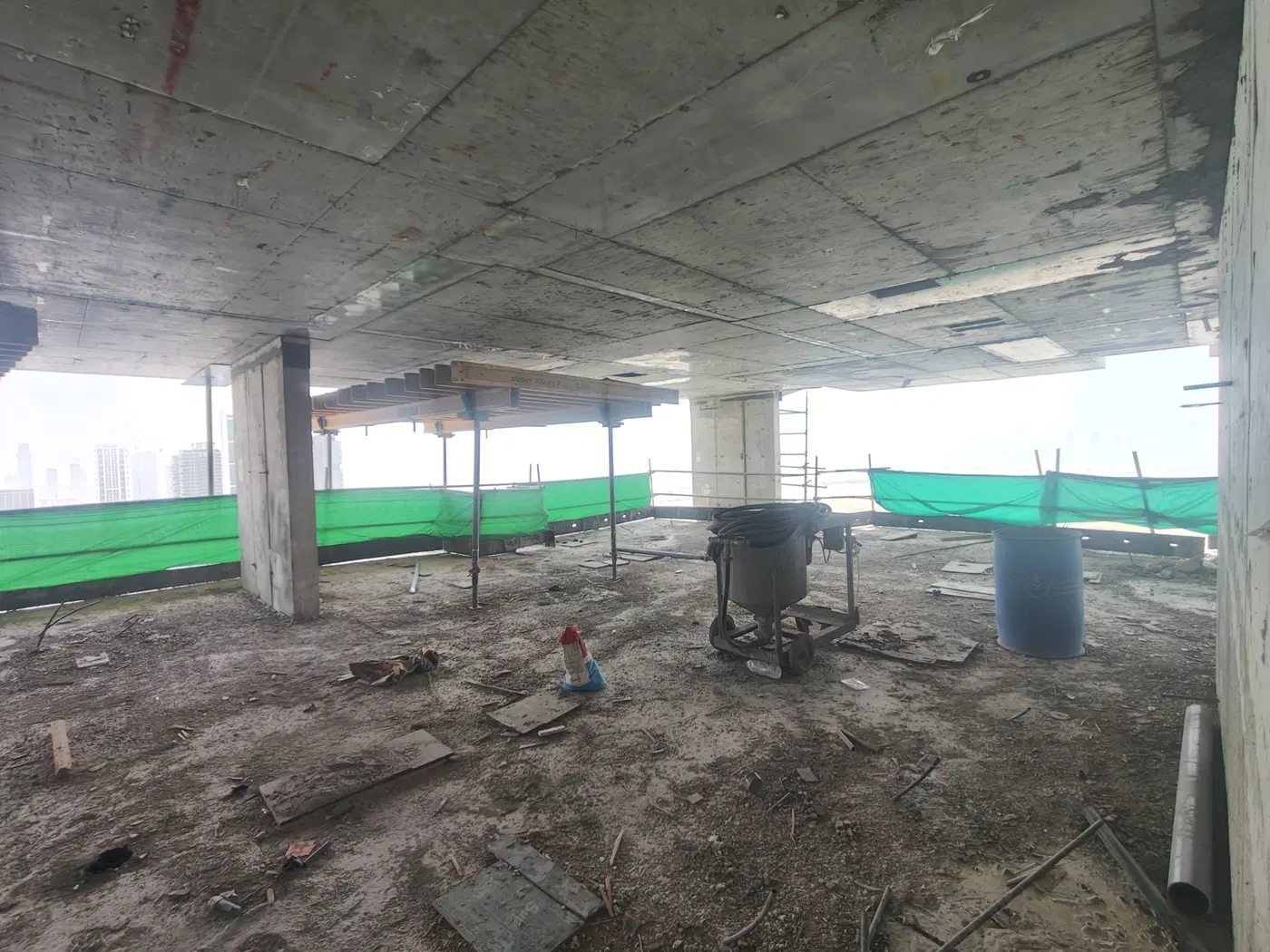

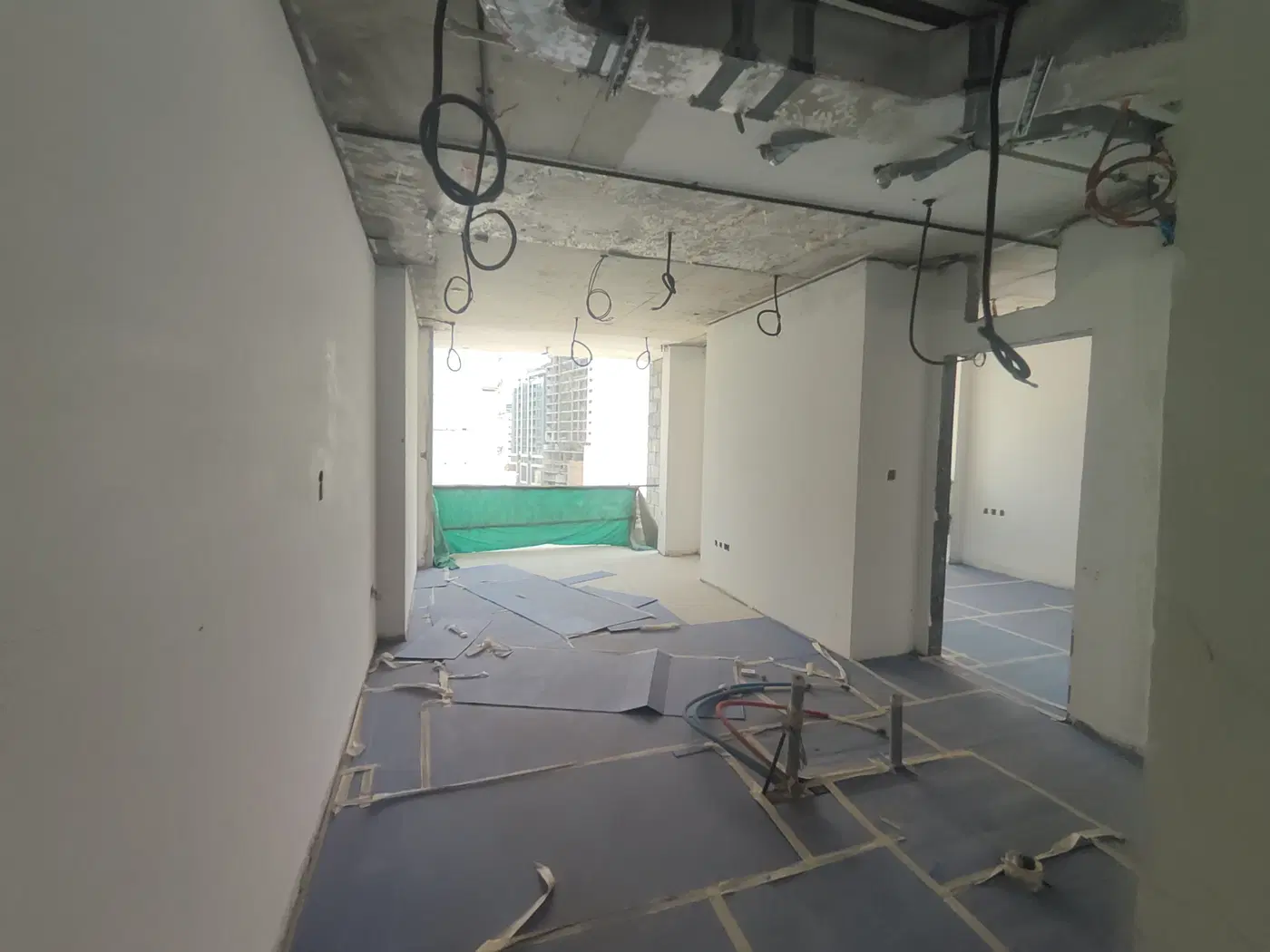

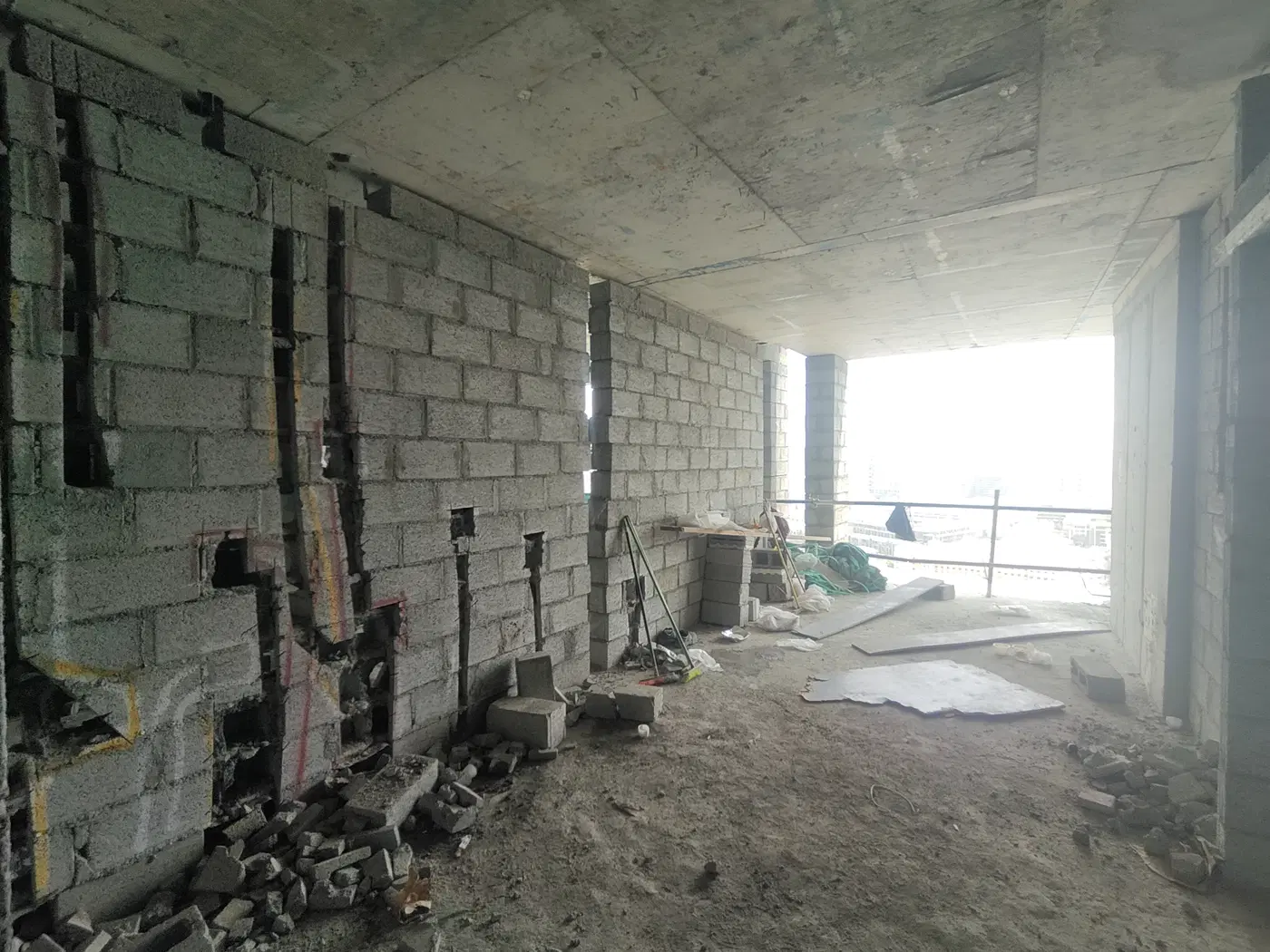

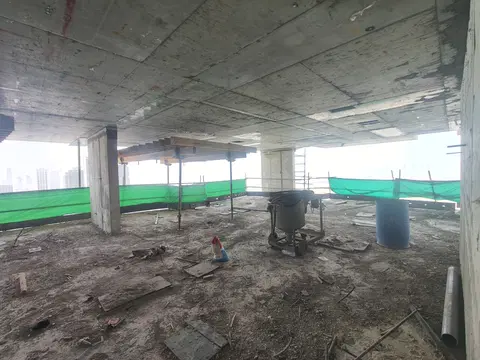

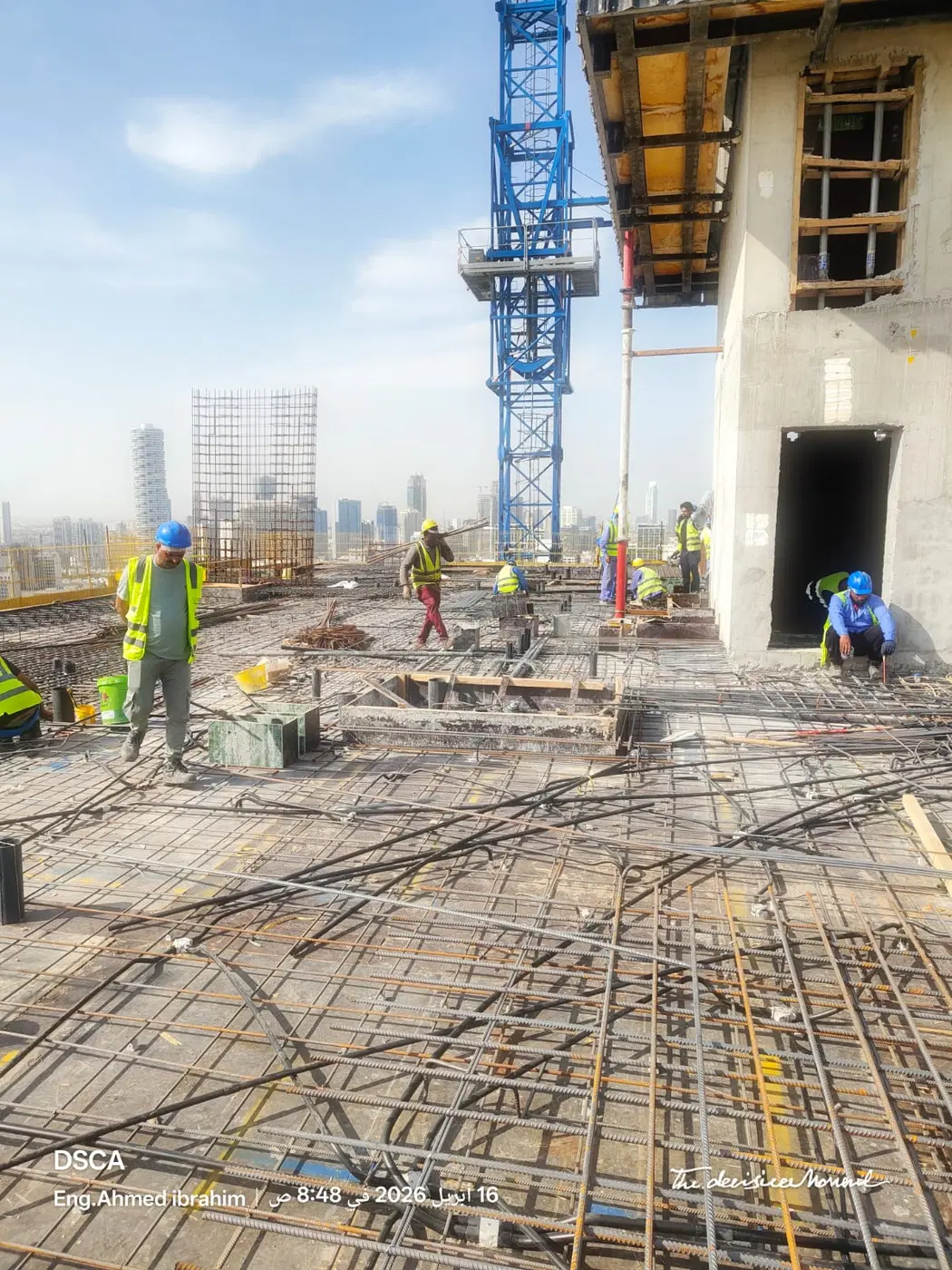

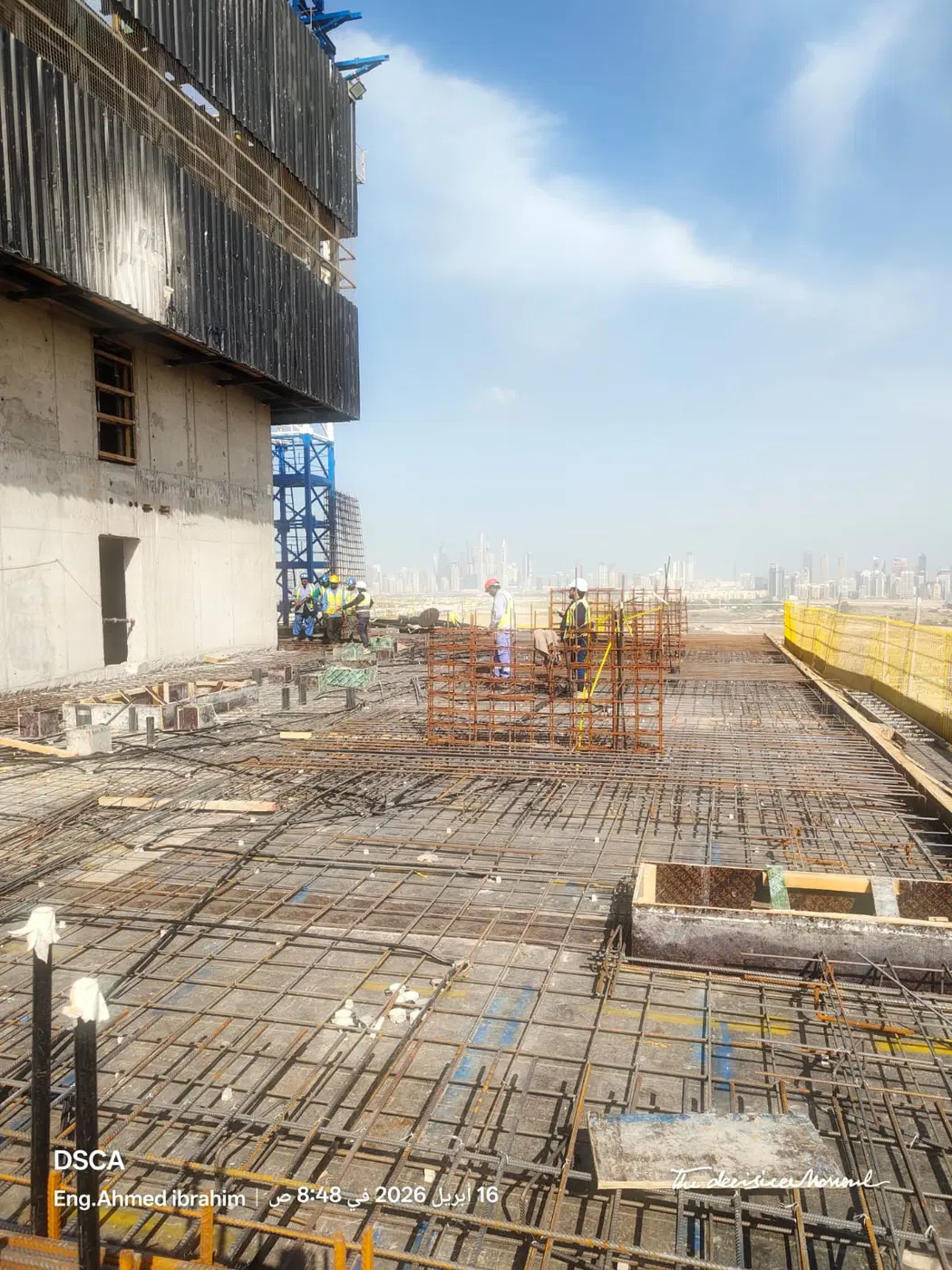

The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 1 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 2 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 3 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 4 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 5 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 6 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 7 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 8 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 9 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 10 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 11 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 12 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 13 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 14 of 15The Fifth Tower, Jumeirah Village Circle construction progress — 4 August 2026, 50.29% complete, photo 15 of 15

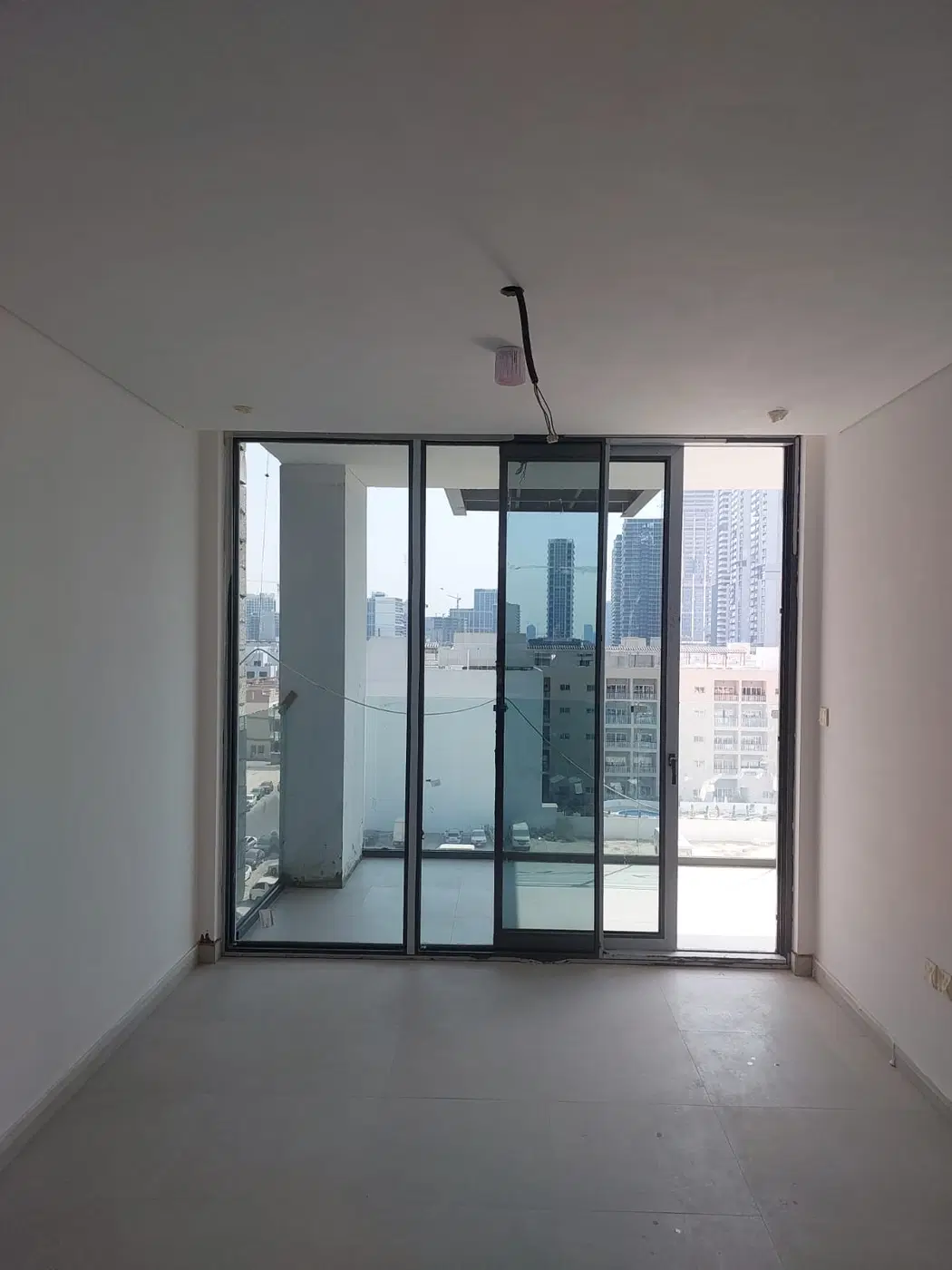

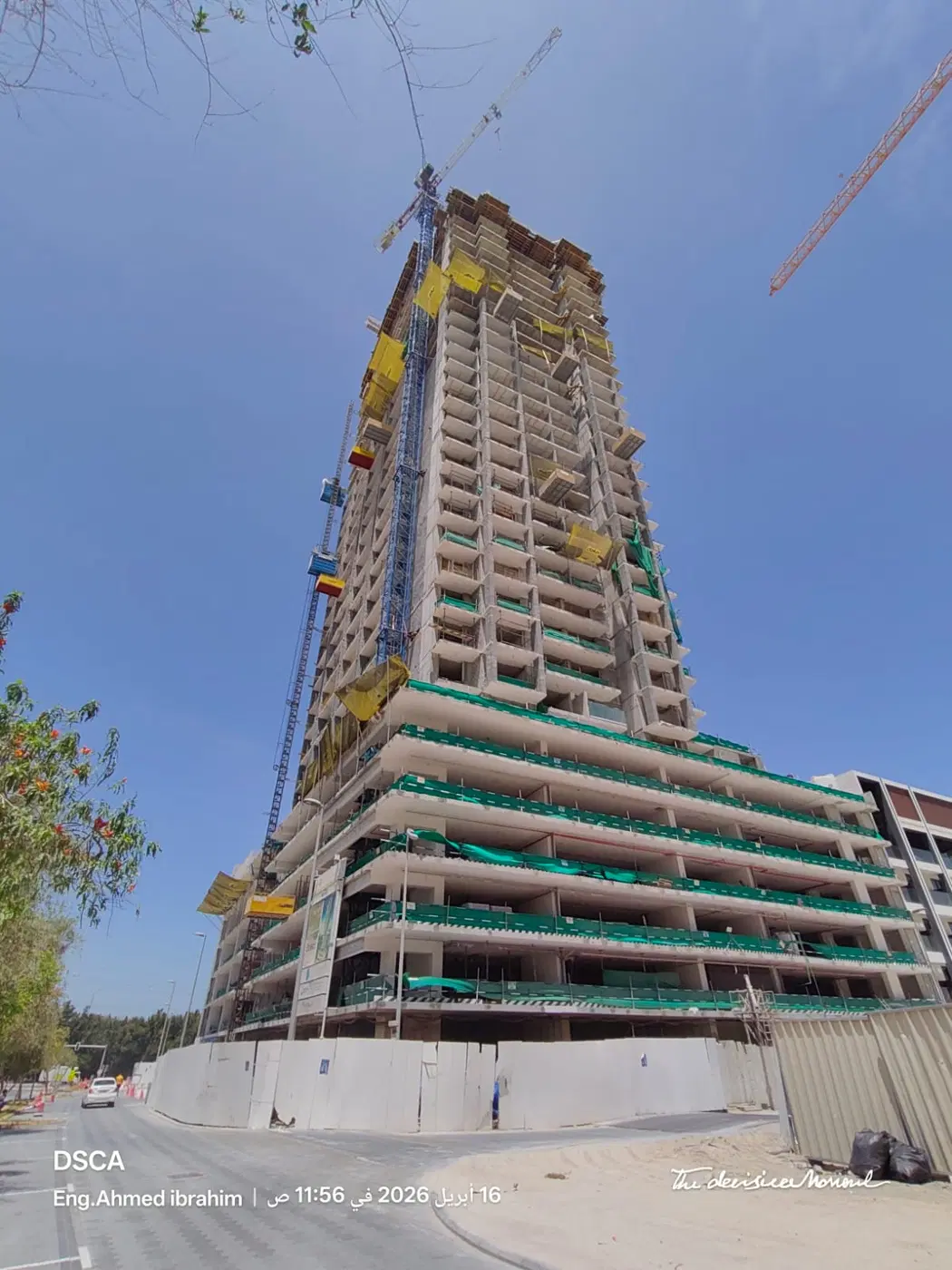

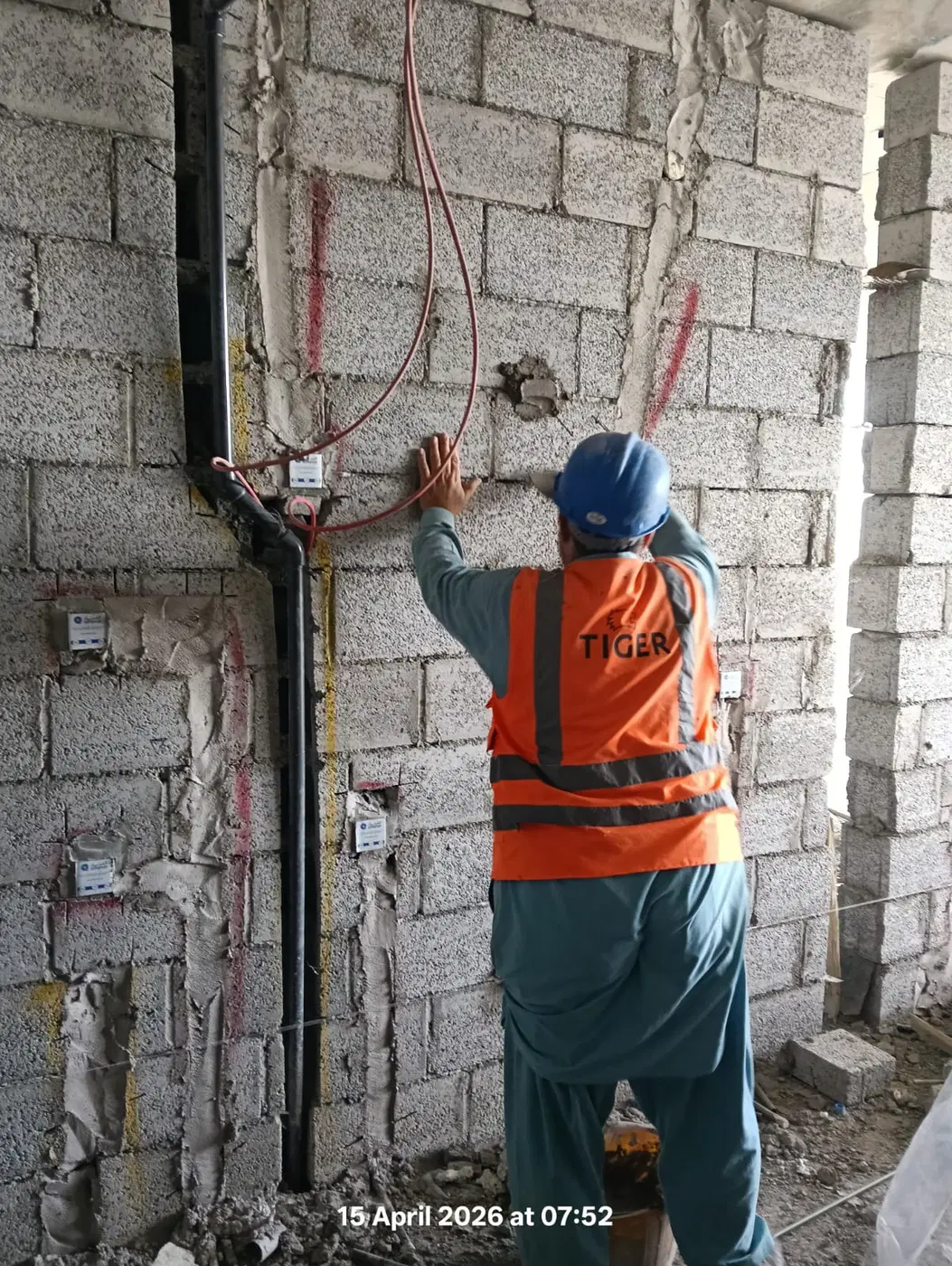

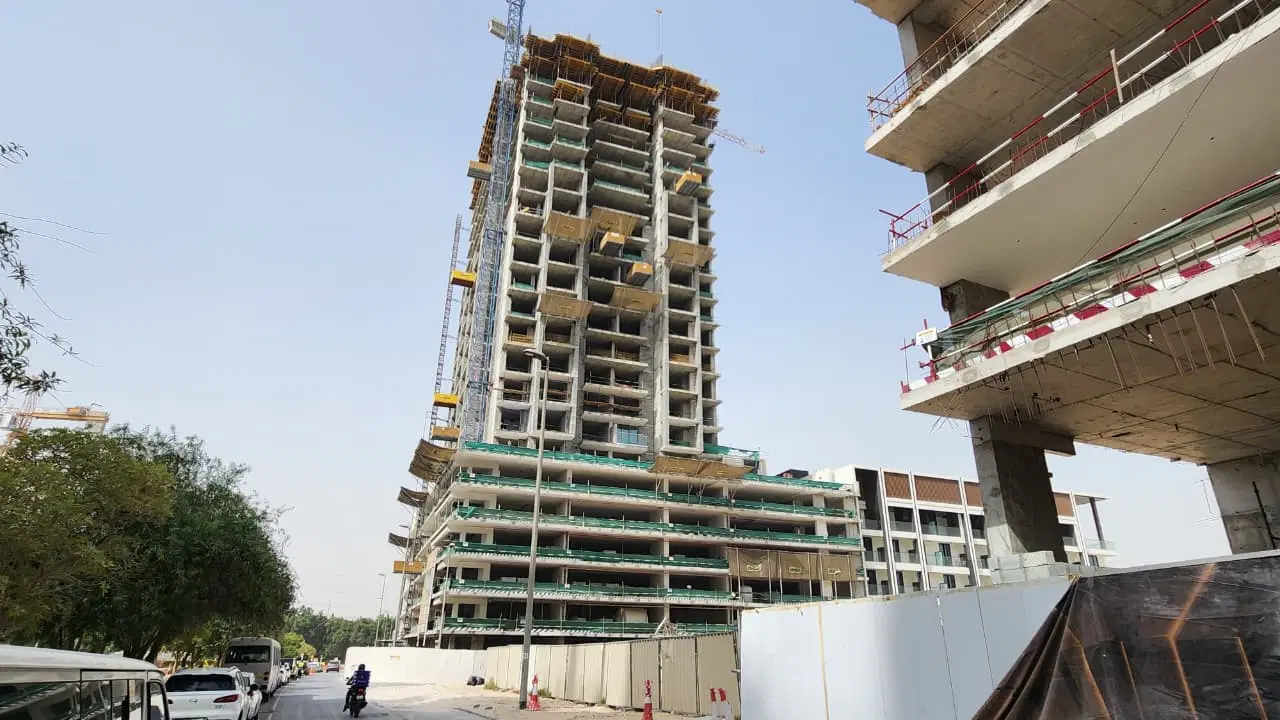

17.04.2026 45.27%

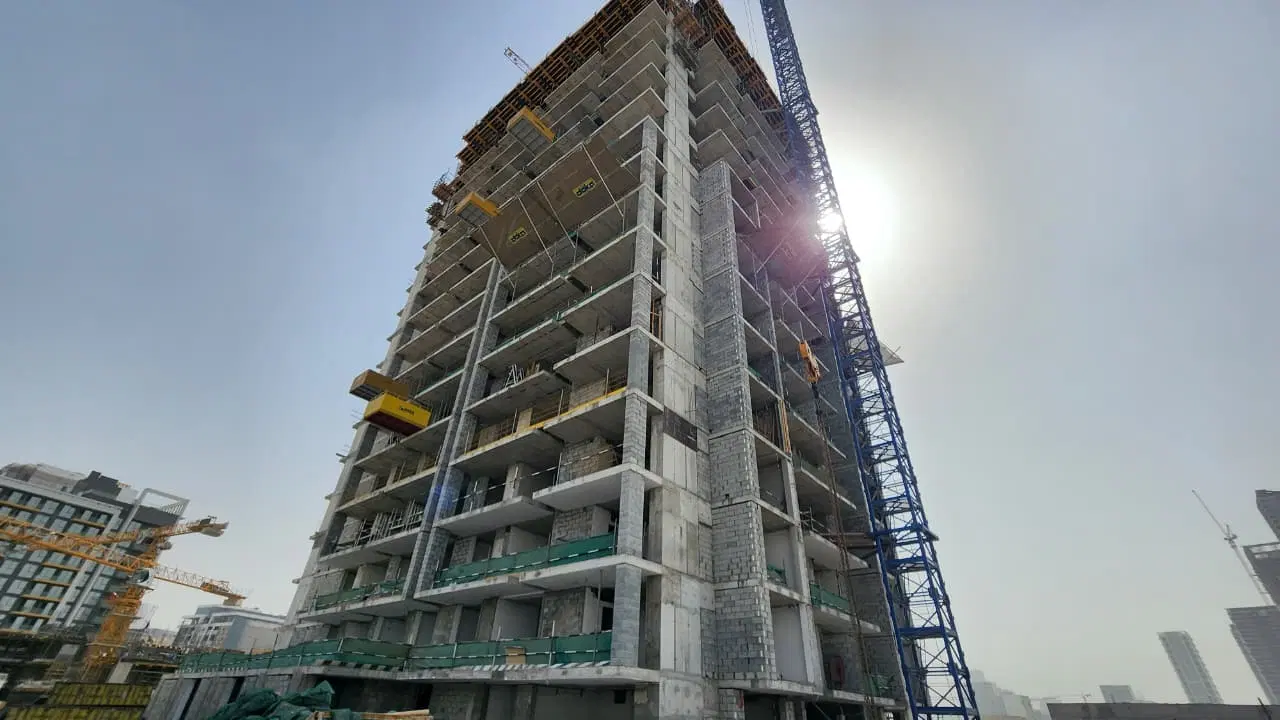

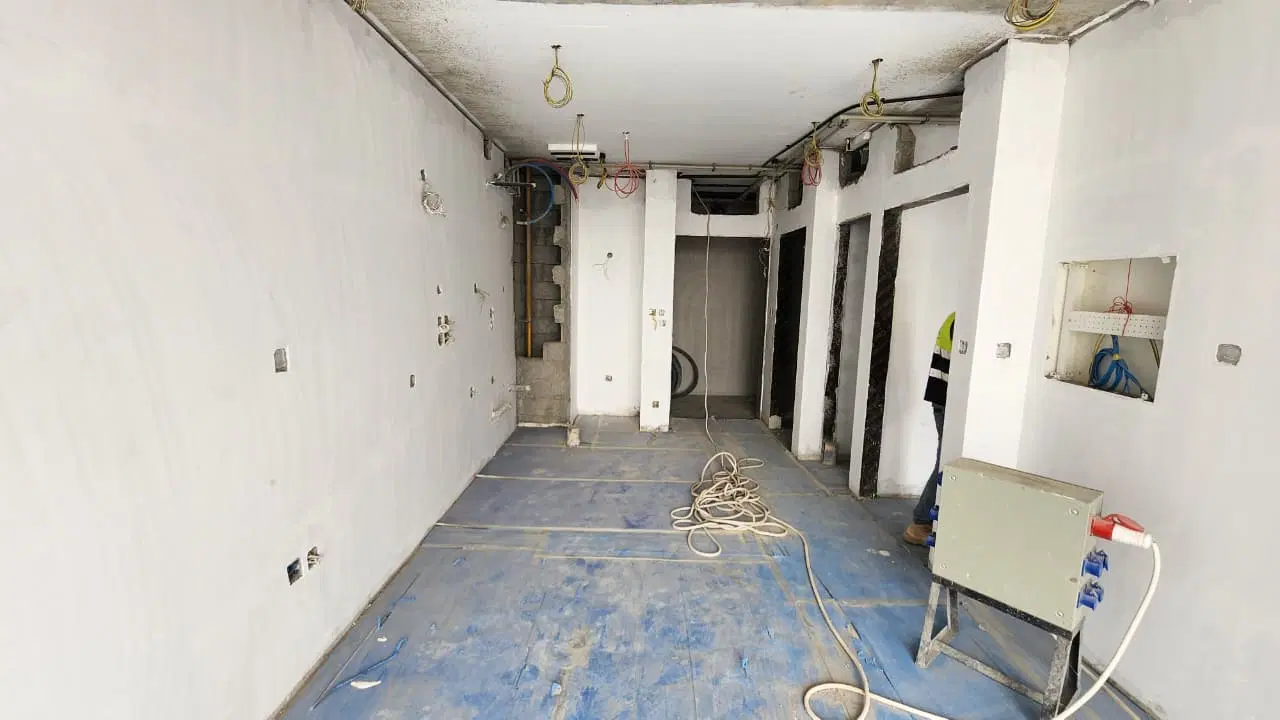

The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 1 of 14The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 2 of 14The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 3 of 14The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 4 of 14The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 5 of 14The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 6 of 14The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 7 of 14The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 8 of 14The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 9 of 14The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 10 of 14The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 11 of 14The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 12 of 14The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 13 of 14The Fifth Tower, Jumeirah Village Circle construction progress — 17 April 2026, 45.27% complete, photo 14 of 14

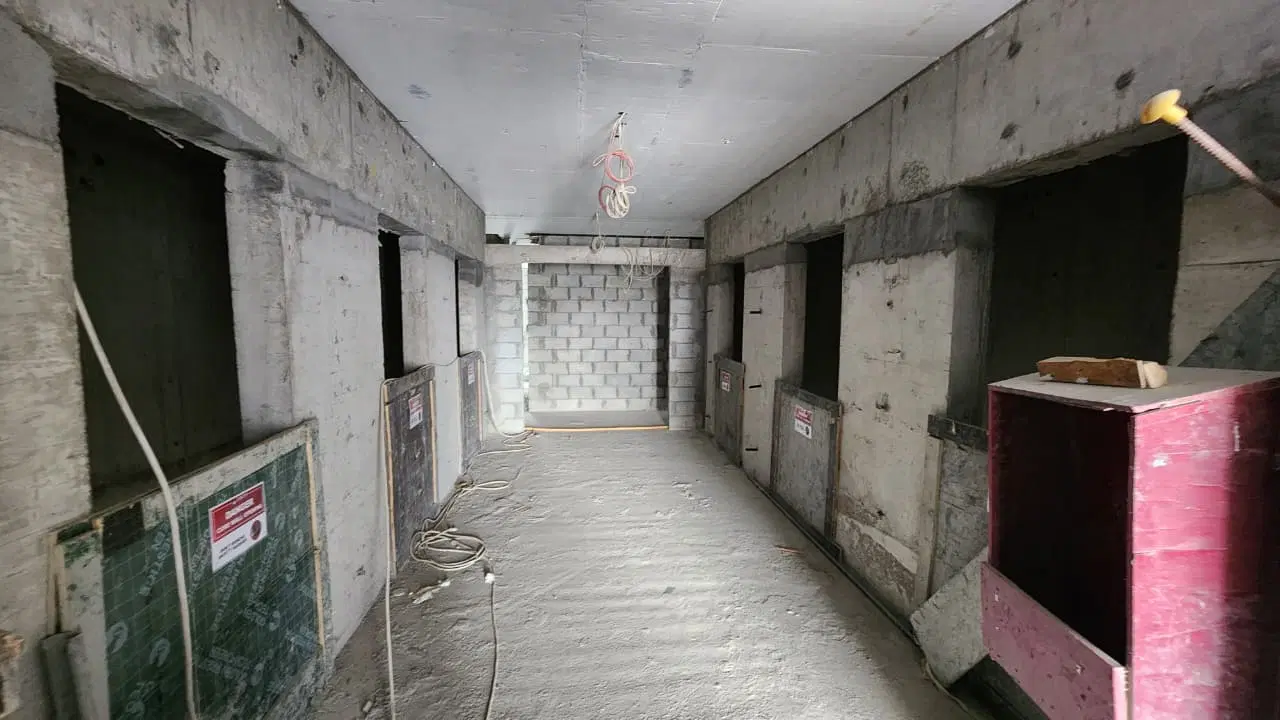

06.11.2025 37.57%

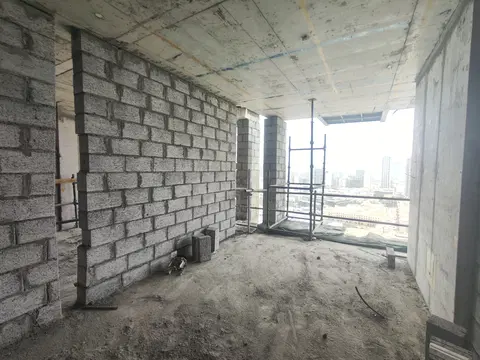

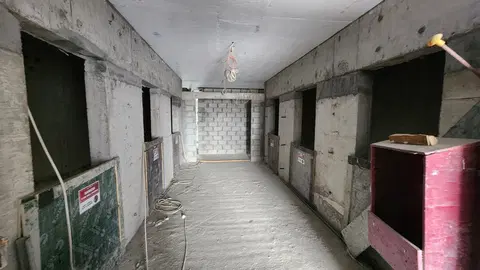

The Fifth Tower, Jumeirah Village Circle construction progress — 6 November 2025, 37.57% complete, photo 1 of 7The Fifth Tower, Jumeirah Village Circle construction progress — 6 November 2025, 37.57% complete, photo 2 of 7The Fifth Tower, Jumeirah Village Circle construction progress — 6 November 2025, 37.57% complete, photo 3 of 7The Fifth Tower, Jumeirah Village Circle construction progress — 6 November 2025, 37.57% complete, photo 4 of 7The Fifth Tower, Jumeirah Village Circle construction progress — 6 November 2025, 37.57% complete, photo 5 of 7The Fifth Tower, Jumeirah Village Circle construction progress — 6 November 2025, 37.57% complete, photo 6 of 7The Fifth Tower, Jumeirah Village Circle construction progress — 6 November 2025, 37.57% complete, photo 7 of 7

65 more photos in the DLD register

Construction photos are taken by the technical inspectors of the Dubai Land Department (DLD) and remain its property. We show compressed copies; full-resolution originals are available in the Real Estate Project Status service.

Recent transactions

DateTypeSize, m²Price, AED
28.09.2026Studio30.3620 000
26.08.20261 BR61.1788 820
24.06.20261 BR60.3760 000
04.05.20261 BR60.2720 000
28.04.20262 BR103.81 210 967
28.04.20262 BR103.81 210 967
28.04.20261 BR61.1815 544
28.04.20261 BR60.3768 465
28.04.20261 BR60.1793 236
28.04.20261 BR60.1793 101
28.04.20261 BR61.0814 658
07.04.20261 BR60.2797 319
07.04.20261 BR60.3764 646
07.04.20261 BR61.1804 200
16.03.20261 BR60.91 053 017
20.02.20261 BR60.0959 546
20.02.20261 BR60.2871 909
17.02.20261 BR61.2780 550
12.02.20261 BR60.3963 053
11.02.20262 BR103.81 636 048
11.02.20261 BR60.31 002 827
09.02.20261 BR60.2814 139
30.01.20261 BR77.71 211 058
28.01.20262 BR103.71 468 845
27.01.20261 BR60.3959 158
26.01.20261 BR60.21 090 148
23.01.20261 BR60.3829 295
22.01.2026Studio30.3508 794
22.01.2026Studio38.7649 162
20.01.20262 BR103.61 250 000
19.01.2026Studio30.3576 000
19.01.20261 BR60.3820 000
15.01.20261 BR61.1933 885
06.01.20262 BR103.71 644 568
22.12.20252 BR103.61 385 062
10.12.20251 BR60.1979 795
03.12.20251 BR60.3984 453
25.11.2025Studio30.3467 222
25.11.20251 BR61.2728 794
25.11.20251 BR60.1858 094
24.11.20252 BR103.71 681 065
20.11.20251 BR60.41 035 007
13.11.20251 BR60.0774 000
12.11.20251 BR60.1790 000
11.11.20251 BR60.21 097 048
10.11.20252 BR103.81 550 855
06.11.20252 BR103.51 250 000
28.10.20252 BR103.71 691 594
21.10.20251 BR60.1961 235
13.10.20251 BR61.2988 000

Dubai Land Department transaction registry, updated 10.10.2026. Explore Dubai property transactions →

Registered transactions in The Fifth Tower

Dubai Land Department records for this building: closed transaction prices, not asking prices or estimates. Figures are medians, so a single expensive sale does not move them.

389deals since 2013
14 730AED per m², median
1%resale, the rest bought from the developer
-6%over the past year

The yearly figure compares the last 12 months with the 12 before them: calendar years would not work, the current one is unfinished. The district moved +1% over the same period, so the building lagged.

What buyers actually paid

TypeSize, m²Price, AEDPer m²Deals
Studio30576 00019 20038
1 bedroom60902 60715 043290
2 bedrooms1041 417 07213 62654

Median across all recorded deals in this building. Rows with fewer than five deals are omitted: there is nothing to average there.

How the price per square metre moved

From 2024 to 2026 — -8% on the price per square metre in this building. The district moved +10% over the same period, so the building lagged the market.

14 7142024——
15 1102025——
13 5992026*——

Top to bottom: purchase price per m², year, annual rent per m², gross yield.

All figures are medians. Years with fewer than eight deals are skipped; rent is shown where there are at least twenty contracts. The yield is gross — service charges are not published in the register.

* 2026 is still in progress and its bar covers part of the year. The growth figure above uses completed years.

Source: Dubai Land Department transaction register. The register is updated daily; the figures here are recalculated weekly.

How much is your property in The Fifth Tower worth?

DLD has recorded 389 sales in this building since 2013, 2 of them resales. We compare your unit with sales of the same layout here, not with asking prices. Free, reply within 24 hours.

By submitting the form you agree to the processing of your contact details.

Places nearby

🎓 JSS International School · 0.5 km🌳 Roolh Park · 0.6 km🎓 Lycée Français Jean Mermoz (South Campus) · 1.1 km🌳 Sabar Park · 1.2 km🌳 Thamam Park · 1.4 km
The Fifth Tower

About the project

The Fifth Tower is a residential and retail development by Object One Real Estate Development in Jumeirah Village Circle, Dubai. The single-building project comprises 345 units and is configured as basement, ground floor, five podium levels, 30 floors and a roof level. It is active, with construction recorded at 50.29% completion and a scheduled completion date of 24 July 2026.

The project and building configuration

The Fifth Tower is planned as one residential and retail building in Jumeirah Village Circle. Its configuration comprises a basement level, ground floor, five podium floors, 30 further floors and a roof level. The development has a total area of 22,784.39 square metres and contains 345 units. The construction specification identifies a concrete structure and blockwork, with internal and external finishes. The project began on 20 March 2024. Its scale, vertical arrangement and mixed residential and retail use place the homes within a single high-rise development rather than across multiple buildings.

Project status and completion

The Fifth Tower is an active project. Construction progress was recorded at 50.29% on the inspection dated 4 August 2026, and the project information was updated on 24 April 2026. The scheduled completion date is 24 July 2026. The building programme runs from its March 2024 start date to the July 2026 completion date. Buyers considering the project can assess it as a development under construction, with a defined project number of 3048 and a stated completion schedule.

Jumeirah Village Circle setting

The Fifth Tower is located in Jumeirah Village Circle, also known as JVC, a freehold master community launched by Nakheel in 2005. The community covers more than 870 hectares and is divided into six districts. Its housing includes apartment buildings, townhouses and villas, while further construction and district-level services continue to be added across the area. JVC sits near the junction of Sheikh Zayed Road and Al Khail Road and has entry and exit connections to Hessa Street. The community includes established residential neighbourhoods as well as retail and leisure provision, including Circle Mall, which has 235 shops, an anchor supermarket, department stores, a multi-screen cinema, a health clinic, cafés, restaurants and a food court.

Road links and Dubai destinations

JVC is primarily car-oriented and has road connections to major Dubai corridors. Dubai Marina is 7.3 km from JVC, Palm Jumeirah is 9.3 km away and JBR Beach is 8.0 km away. Mall of the Emirates is 6.9 km from the community, while Burj Khalifa and Downtown Dubai are 17.0 km away. Dubai Mall is 17.3 km away, Dubai International Airport is 27.0 km away and Al Maktoum International Airport is 18.4 km away. The nearest Dubai Metro Red Line station, R34, is 6,139 metres from central JVC locations. Dubai Mall is stated at a 21-minute drive, while Palm Jumeirah and Dubai Marina are stated at 20 minutes by car; travel times vary with traffic and route.

The wider community

JVC combines low- to mid-rise apartment buildings with townhouse and villa neighbourhoods. By mid-2020, 235 towers or townhouse rows had been completed in the community, with a further 110 under construction. The area contains 367 projects, reflecting its role as a large master-planned residential district. Development has taken place in phases over many years, with infrastructure and housing delivered alongside newer schemes. The community’s residential range includes larger villas, townhouses and apartments, giving the district a mix of established homes and continuing development activity.

Developer

Object One Real Estate Development is the developer of The Fifth Tower. The company is delivering a 345-unit project with residential and retail components in Jumeirah Village Circle. The development is registered under project number 3048 and is planned as one building. Its current construction programme began in March 2024 and has a scheduled completion date in July 2026.

Frequent questions

Who is the developer of The Fifth Tower?
The Fifth Tower is developed by Object One Real Estate Development.
Where is The Fifth Tower located?
The Fifth Tower is located in Jumeirah Village Circle, Dubai.
How many units are in The Fifth Tower?
The project contains 345 units in one building.
What is the completion status of The Fifth Tower?
The project is active and was recorded at 50.29% completion on 4 August 2026.
When is The Fifth Tower scheduled for completion?
The scheduled completion date is 24 July 2026.
What is the building configuration of The Fifth Tower?
The building includes a basement, ground floor, five podium levels, 30 floors and a roof level.
What is near The Fifth Tower in JVC?
Dubai Marina is 7.3 km from JVC, Palm Jumeirah is 9.3 km away and Mall of the Emirates is 6.9 km away. Circle Mall includes 235 shops, an anchor supermarket, department stores, a cinema, cafés and restaurants.
What is the nearest metro station to JVC?
The nearest Dubai Metro Red Line station, R34, is 6,139 metres from central JVC locations.
How can I buy an apartment in The Fifth Tower?
Submit an enquiry via the form on this page or message us on WhatsApp — a Continental Club Property broker (RERA 31933) will help you choose a unit and send the brochure and payment plan.

Nearby projects

Get the presentation and prices

We will send floor plans, the payment plan and available units for this project.

By submitting the form you agree to the processing of your contact details.

Project data comes from the Dubai Land Department (DLD) registry.

For AI agents and researchers

Machine-readable mirrors of this page: Markdown · JSON. They carry the same figures as this page, each with its origin labelled.

How to cite:The Fifth Tower — Continental Club Property, from Dubai Land Department registry and developer data, 2026-10-01, https://continentalclub.ae/project/the-fifth-tower-jumeirah-village-circle/
