Developer: Golden Woods · Dubai South Residential District

Views Vii By Golden Woods

Views Vii By Golden Woods is a residential project by Golden Woods in Dubai South Residential District, Dubai, with planned handover Q3 2026, construction 90.4% complete per the DLD registry, 68 units, 45 DLD-registered sales since 2024.

Planned handoverQ3 2026Developer supplied
Construction90.4%DLD registry · checked 08.05.2026
Units68DLD registry
DLD sales45 since 2024DLD registry
Median sale priceAED 12 917/m²Our calculation

Every figure carries its origin: “DLD registry” is taken from the Dubai Land Department register, “Developer supplied” is stated by the developer, “Our calculation” is computed by us from the first two. Developer prices change without notice — confirm before you commit. Methodology

Layouts and sizes

TypeUnitsTypical size, sq.ft
Studio24333–408
1 Bedroom10781–791
2 Bedroom32964–1 084
3 Bedroom21 768

Size range excludes the smallest and largest 5% of units of each type.

All units are freehold. Data from the DLD registry.

Mortgage for this project

For UAE residents the down payment starts at 20% with terms up to 25 years. Estimate your payment and purchase costs for your budget.

Calculate mortgage

Estimates only; not a bank approval.

Handover date & construction progress

90.35%
  • Construction started31.07.2024
  • Planned handover (developer)Q3 2026
  • Status date08.05.2026
  • Progress between DLD inspections+25.9% (03.12.2025 → 08.05.2026)
  • Escrow bankADCB
  • DLD project number3233

Data from the Dubai Land Department project registry (updated 08.10.2026 09:55).

Inspection history 3
025507510022.08.202408.05.2026
Actual, per inspections

Pace: 5.05% per month. At this rate 100% falls on 05.07.2026.

The pace is calculated from the past year of inspections. It is an estimate, not a developer commitment. For reference: across 1,175 completed projects the median pace is 2.48% per month and the median build takes 40 months.

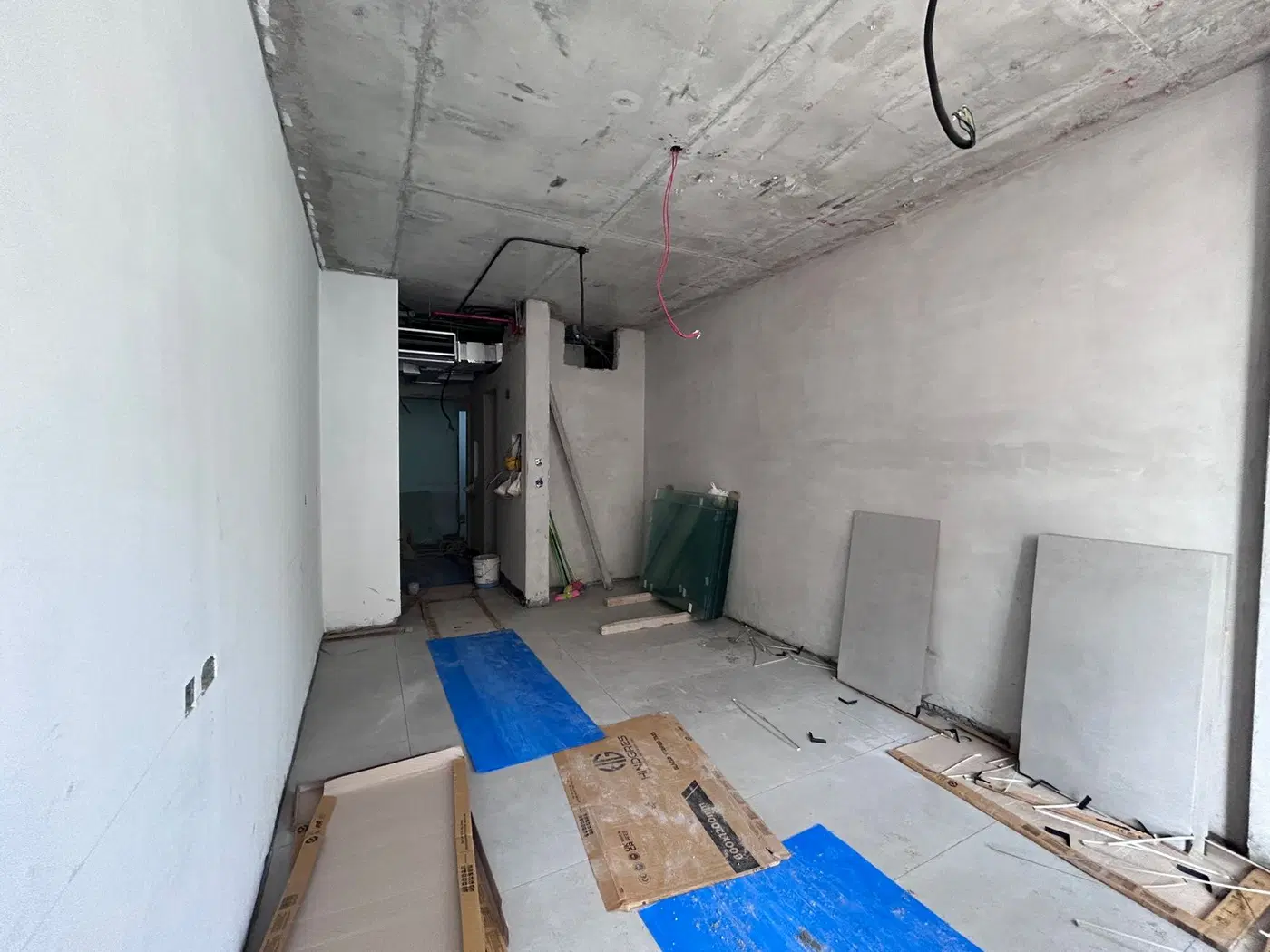

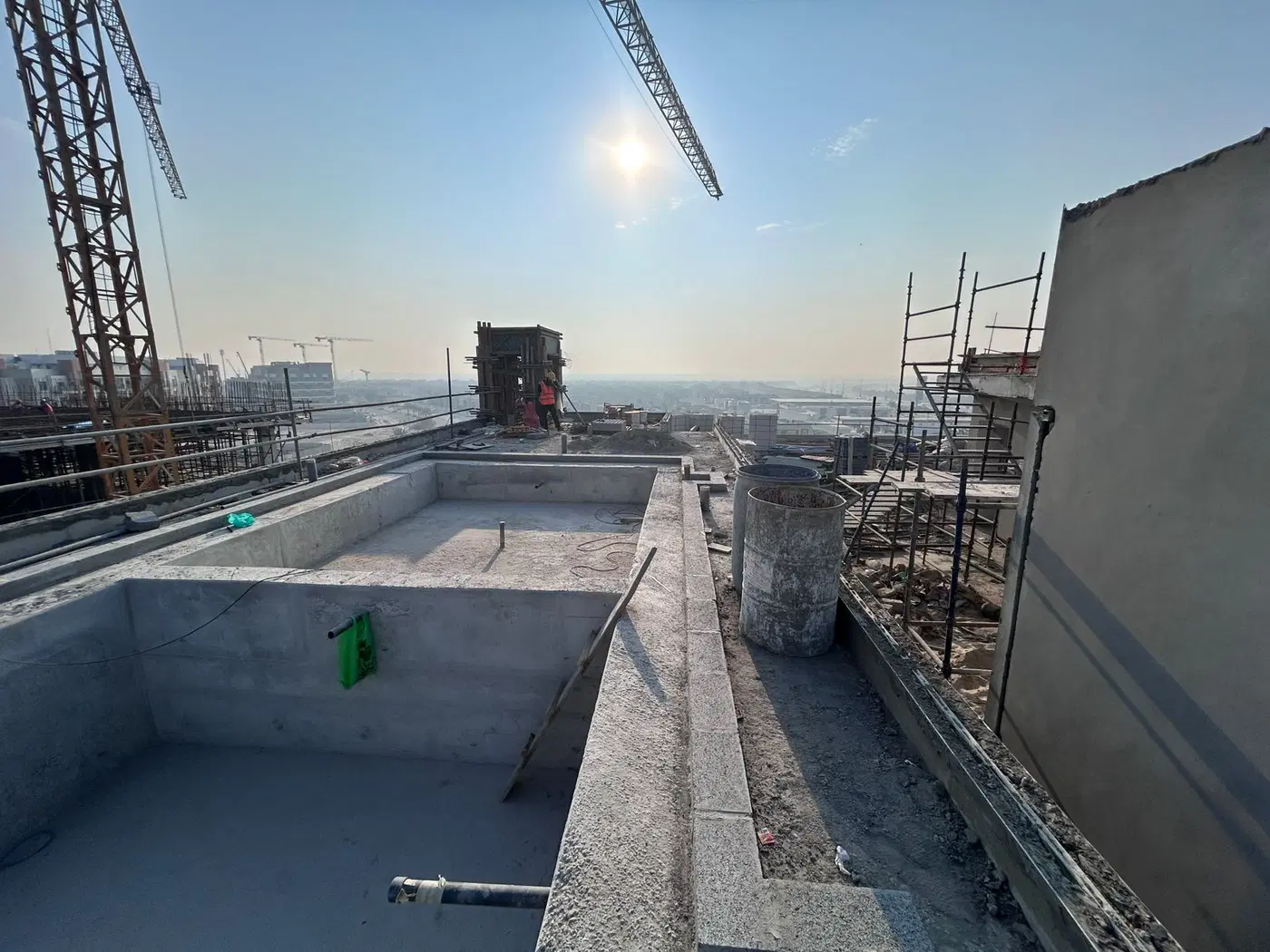

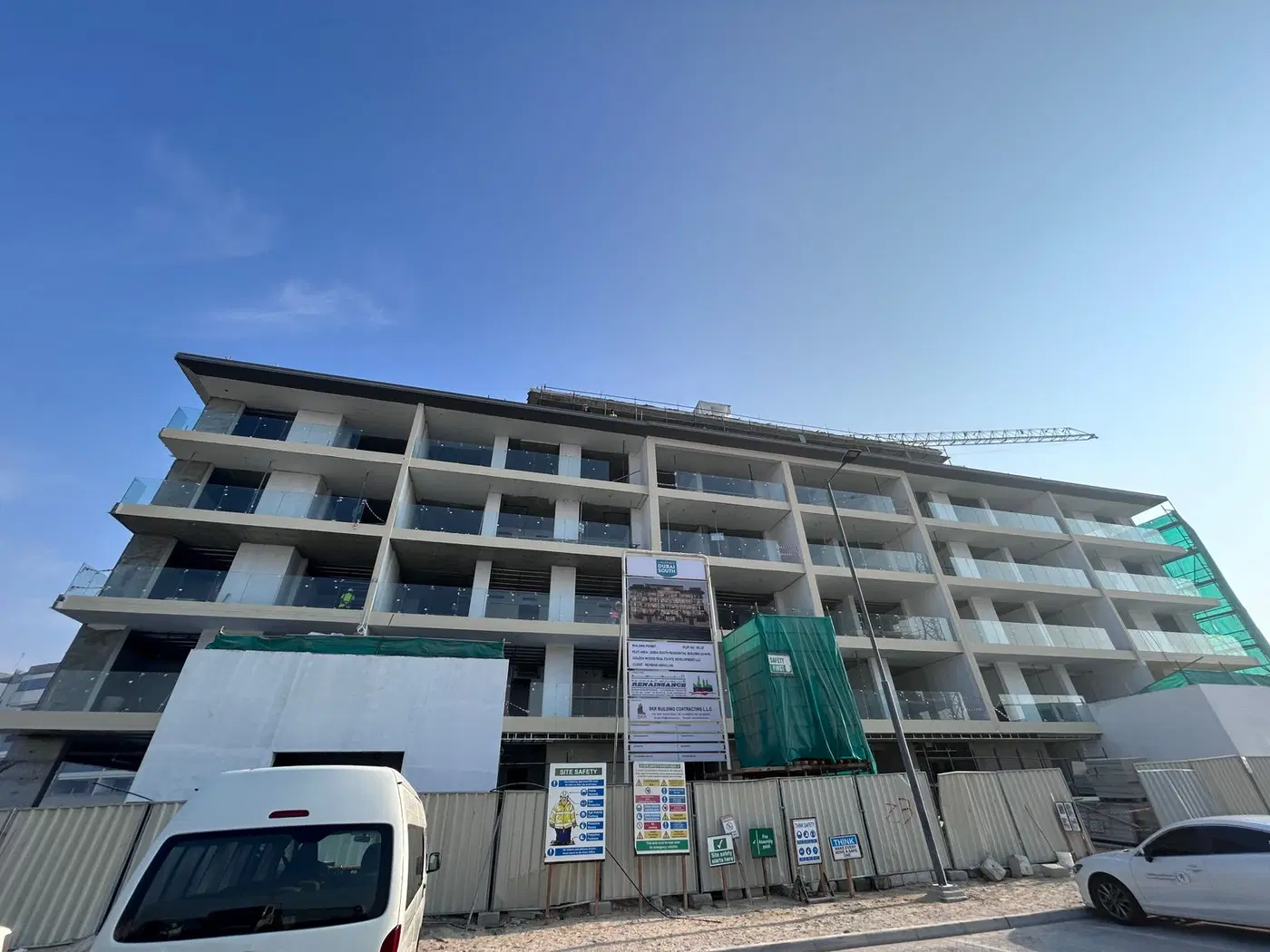

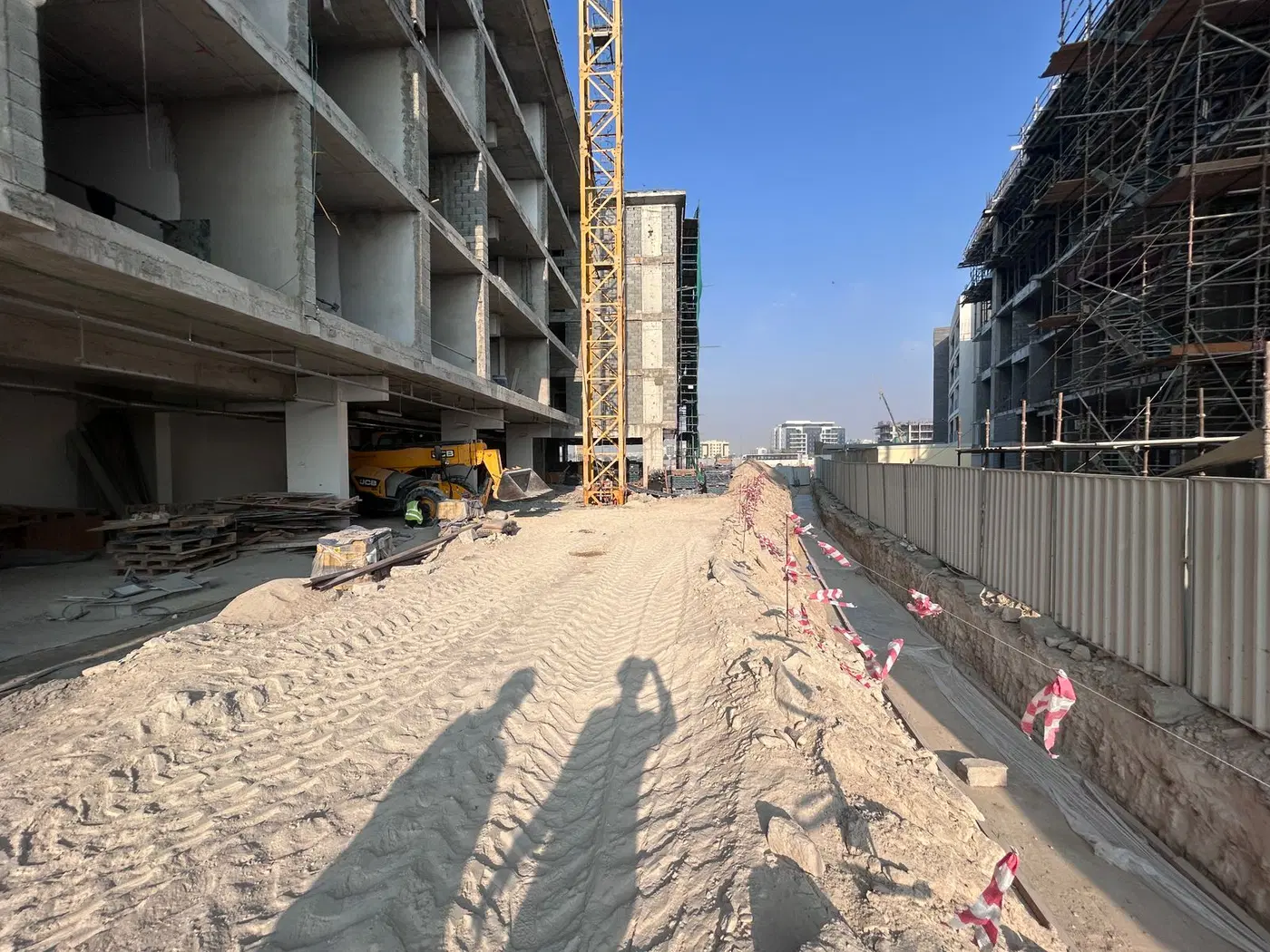

Construction progress 21

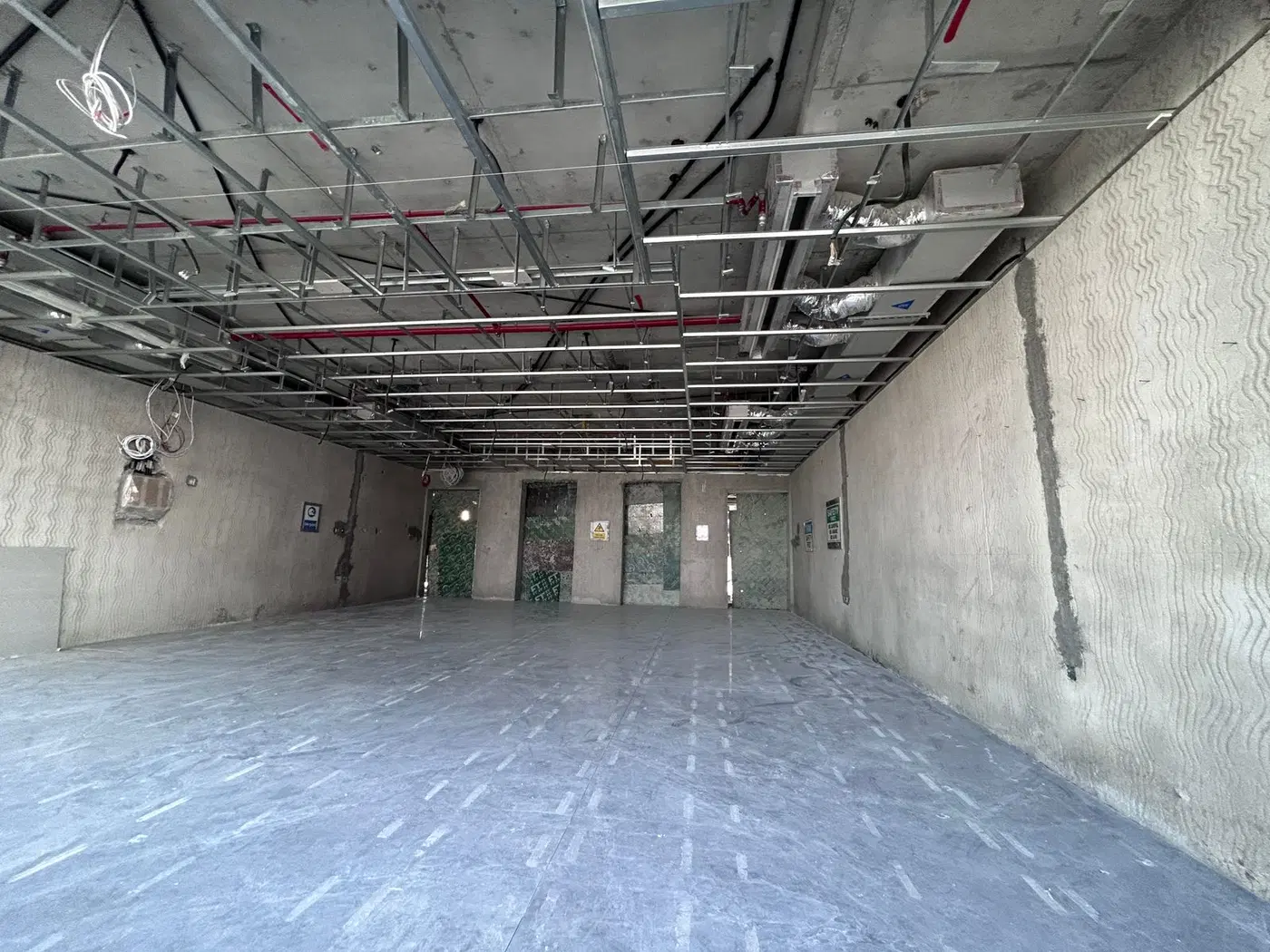

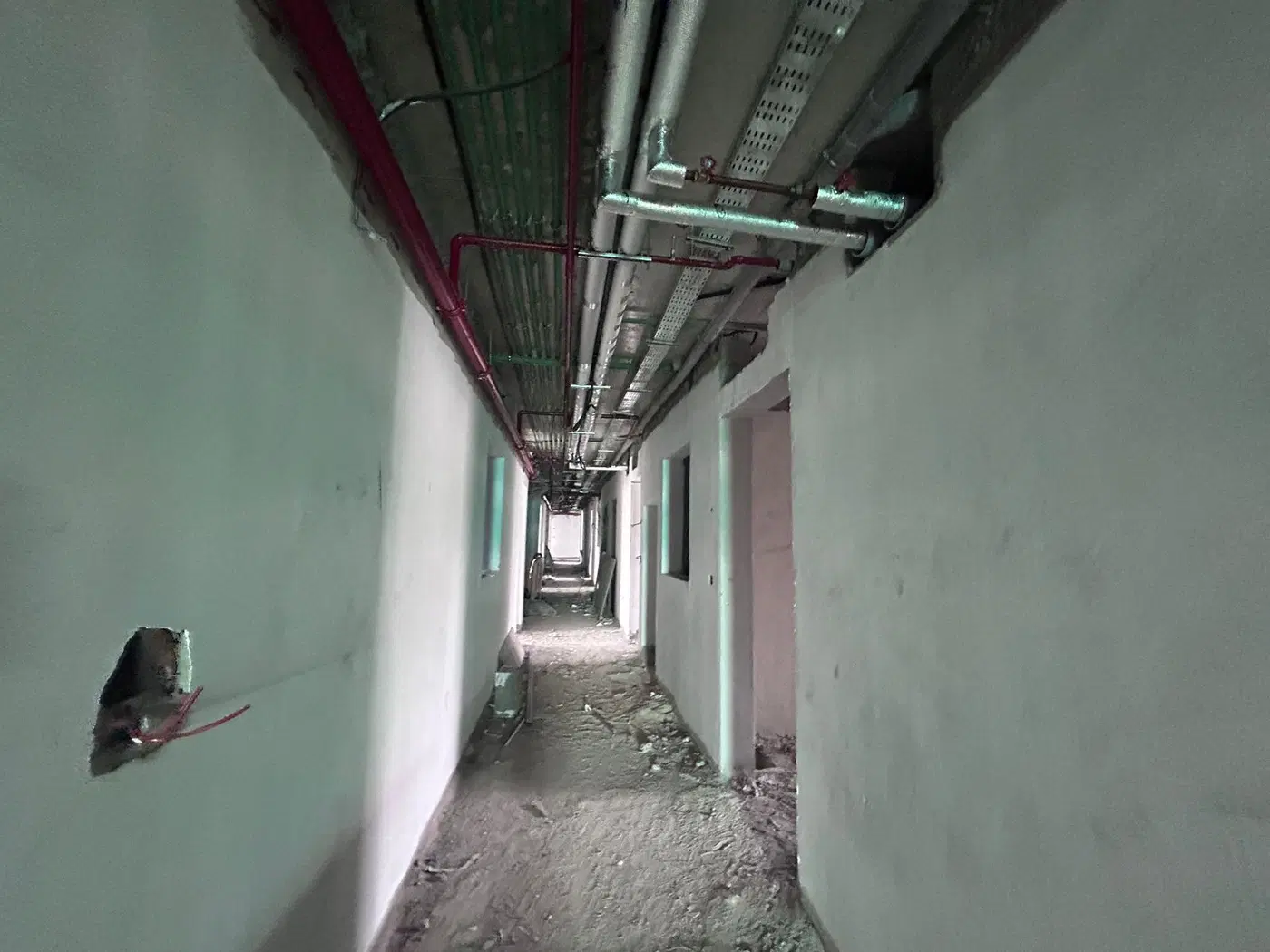

08.05.2026 90.35%

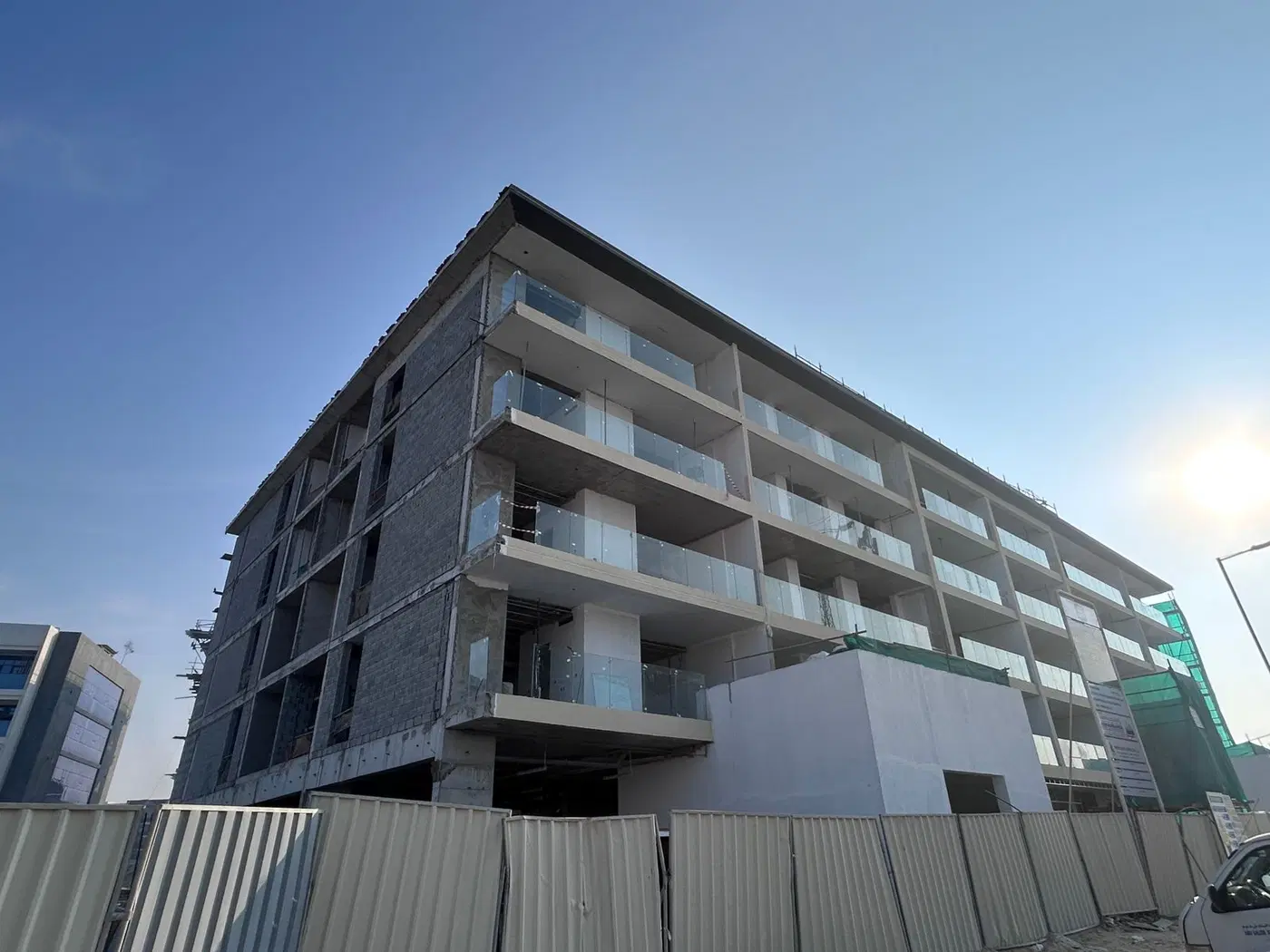

Views Vii By Golden Woods, Dubai South Residential District construction progress — 8 May 2026, 90.35% complete, photo 1 of 9Views Vii By Golden Woods, Dubai South Residential District construction progress — 8 May 2026, 90.35% complete, photo 2 of 9Views Vii By Golden Woods, Dubai South Residential District construction progress — 8 May 2026, 90.35% complete, photo 3 of 9Views Vii By Golden Woods, Dubai South Residential District construction progress — 8 May 2026, 90.35% complete, photo 4 of 9Views Vii By Golden Woods, Dubai South Residential District construction progress — 8 May 2026, 90.35% complete, photo 5 of 9Views Vii By Golden Woods, Dubai South Residential District construction progress — 8 May 2026, 90.35% complete, photo 6 of 9Views Vii By Golden Woods, Dubai South Residential District construction progress — 8 May 2026, 90.35% complete, photo 7 of 9Views Vii By Golden Woods, Dubai South Residential District construction progress — 8 May 2026, 90.35% complete, photo 8 of 9Views Vii By Golden Woods, Dubai South Residential District construction progress — 8 May 2026, 90.35% complete, photo 9 of 9

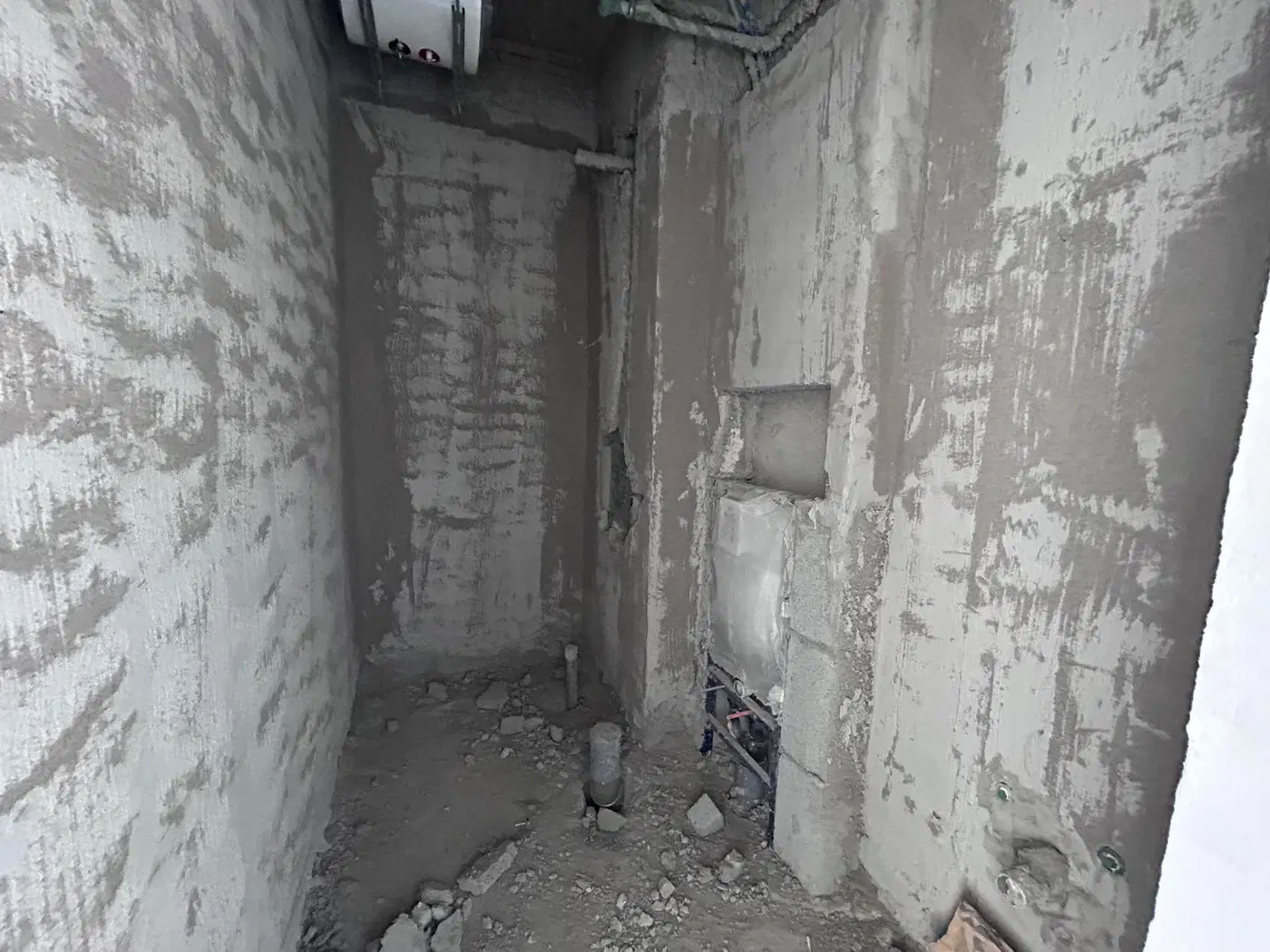

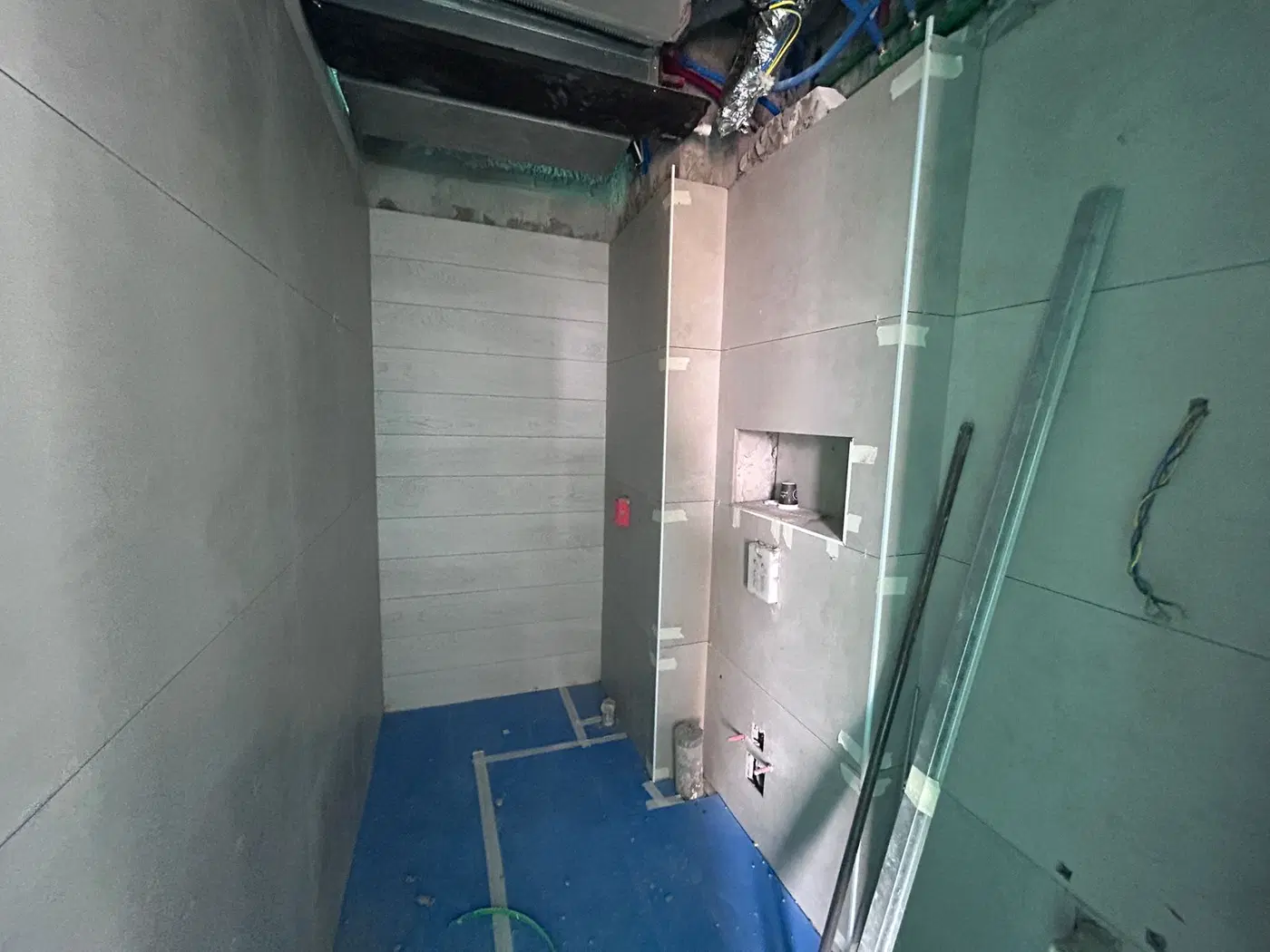

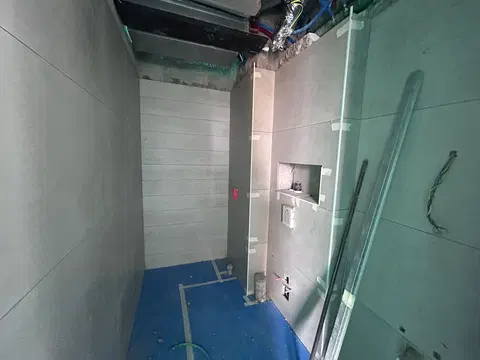

03.12.2025 64.45%
Views Vii By Golden Woods, Dubai South Residential District construction progress — 3 December 2025, 64.45% complete, photo 1 of 10Views Vii By Golden Woods, Dubai South Residential District construction progress — 3 December 2025, 64.45% complete, photo 2 of 10Views Vii By Golden Woods, Dubai South Residential District construction progress — 3 December 2025, 64.45% complete, photo 3 of 10Views Vii By Golden Woods, Dubai South Residential District construction progress — 3 December 2025, 64.45% complete, photo 4 of 10Views Vii By Golden Woods, Dubai South Residential District construction progress — 3 December 2025, 64.45% complete, photo 5 of 10Views Vii By Golden Woods, Dubai South Residential District construction progress — 3 December 2025, 64.45% complete, photo 6 of 10Views Vii By Golden Woods, Dubai South Residential District construction progress — 3 December 2025, 64.45% complete, photo 7 of 10Views Vii By Golden Woods, Dubai South Residential District construction progress — 3 December 2025, 64.45% complete, photo 8 of 10Views Vii By Golden Woods, Dubai South Residential District construction progress — 3 December 2025, 64.45% complete, photo 9 of 10Views Vii By Golden Woods, Dubai South Residential District construction progress — 3 December 2025, 64.45% complete, photo 10 of 10

22.08.2024 0.00%
Views Vii By Golden Woods, Dubai South Residential District construction progress — 22 August 2024, 0.00% complete, photo 1 of 2Views Vii By Golden Woods, Dubai South Residential District construction progress — 22 August 2024, 0.00% complete, photo 2 of 2

Construction photos are taken by the technical inspectors of the Dubai Land Department (DLD) and remain its property. We show compressed copies; full-resolution originals are available in the Real Estate Project Status service.

Recent transactions

DateTypeSize, m²Price, AED
25.09.20262 BR90.11 212 550
15.09.20263 BR164.32 165 898
06.05.20262 BR94.81 224 636
06.05.20262 BR94.81 224 636
06.04.2026Studio37.7430 000
04.03.2026Studio31.3471 674
04.03.20262 BR90.11 248 583
17.02.20262 BR90.11 261 052
28.01.20262 BR90.11 261 052
05.01.20262 BR89.61 253 083
02.01.20262 BR89.61 253 083
01.01.20261 BR72.5936 719
05.11.20253 BR164.32 121 696
04.11.2025Studio30.9425 000
30.10.20252 BR90.11 164 052
18.08.2025Studio31.3244 260
18.08.20252 BR90.1703 279
18.08.20251 BR72.5565 935
18.08.2025Studio31.3244 260
30.07.20252 BR94.81 020 420
04.07.20252 BR94.81 224 504
04.07.20252 BR98.71 328 138
03.07.20252 BR90.11 164 180
02.07.20252 BR94.81 224 504
01.07.20252 BR90.11 164 048
15.05.20252 BR90.11 115 673
30.04.20252 BR100.71 300 716
28.04.20252 BR90.11 164 048
09.04.20252 BR100.7785 849
09.04.2025Studio30.9340 000
03.04.2025Studio37.7294 205
31.03.2025Studio37.9529 778
04.03.2025Studio37.9529 778
04.03.20252 BR94.81 224 502
03.03.20251 BR72.5565 935
25.02.2025Studio37.9529 776
25.02.2025Studio31.3471 674
17.02.2025Studio37.7373 500
14.02.2025Studio37.7527 539
13.02.2025Studio37.9529 778
13.02.2025Studio31.3437 983
12.02.2025Studio37.7527 540
30.01.2025Studio37.9509 400
10.01.2025Studio31.3370 601
09.01.2025Studio30.9432 526
19.12.2024Studio31.3471 674

Dubai Land Department transaction registry, updated 07.10.2026. Explore Dubai property transactions →

Registered transactions in Views Vii By Golden Woods

Dubai Land Department records for this building: closed transaction prices, not asking prices or estimates. Figures are medians, so a single expensive sale does not move them.

45deals since 2024
12 917AED per m², median
0%resale, the rest bought from the developer
+6%over the past year

The yearly figure compares the last 12 months with the 12 before them: calendar years would not work, the current one is unfinished. The district moved +3% over the same period, so the building grew faster.

What buyers actually paid

TypeSize, m²Price, AEDPer m²Deals
Studio38471 67412 41220
2 bedrooms901 224 50413 60620

Median across all recorded deals in this building. Rows with fewer than five deals are omitted: there is nothing to average there.

Source: Dubai Land Department transaction register. The register is updated daily; the figures here are recalculated weekly.

How much is your property in Views Vii By Golden Woods worth?

DLD has recorded 45 sales in this building since 2024. We compare your unit with sales of the same layout here, not with asking prices. Free, reply within 24 hours.

By submitting the form you agree to the processing of your contact details.
Views Vii By Golden Woods

About the project

Views Vii By Golden Woods is a 68-unit residential project in Dubai South Residential District, within Madinat Al Mataar. Golden Wood Real Estate Development is developing the single-building scheme, which is configured as a ground floor, four upper floors and a roof level. The project is active, with construction recorded at 90.35% on 8 May 2026 and completion scheduled for 30 July 2026.

The project and building format

Views Vii By Golden Woods comprises one residential building with 68 units. Its registered configuration is G+4+Roof, meaning a ground floor, four floors above it and a roof level. The project began on 31 July 2024 and has a recorded total project area of 4,881.26. The development sits in Madinat Al Mataar, in Dubai South Residential District. This district forms the residential component of the wider Dubai South masterplan, a development zone connected with aviation, logistics and economic precincts. The district’s original planning framework includes residential plots, streets, open spaces and local infrastructure.

Construction progress and scheduled completion

The project is active. Its completion ratio was recorded at 90.35% following an inspection dated 8 May 2026. The scheduled completion date is 30 July 2026, which is also the project end date. Construction started on 31 July 2024. The recorded progress places Views Vii By Golden Woods in the final phase of its construction programme. Buyers assessing timing can use the scheduled completion date together with the recorded completion ratio as the project’s stated construction position.

Dubai South Residential District setting

Views Vii By Golden Woods is located in Dubai South Residential District, a residential enclave within the larger Dubai South development. Dubai South is positioned to serve Al Maktoum International Airport and adjacent economic, logistics and aviation areas. The residential district has been planned as a housing neighbourhood for residents connected with the wider Dubai South zone. Its published masterplan framework sets out residential blocks, open spaces and local infrastructure. The wider district contains residential developments at different stages of construction and completion, with nineteen projects recorded across the area.

Road travel and airport connections

Dubai South Residential District has recorded road connections to major Dubai destinations. Typical driving times are 38 minutes to Dubai Mall, 34 minutes to Palm Jumeirah, 35 minutes to Burj Al Arab and 37 minutes to The Walk at JBR. Al Maktoum International Airport has a recorded driving time of 19 minutes from the district, while Dubai International Airport has a recorded driving time of 38 minutes. Journey times depend on traffic conditions and the route selected. The nearest referenced metro connection is on the Red Line, at station R76, recorded 6,663 metres from the district and not classified as walkable.

Local education and the wider neighbourhood

The International School of Choueifat DIP is a recorded nearby school option, located 5.8 kilometres from Dubai South Residential District. Retail, leisure and healthcare services for the district are accessed across the wider Dubai South area and neighbouring urban districts. Residential projects recorded within the district include Trafford Residence, The Eighty Three, South Living, Oasis Residences Dubai South, Myra Residences, Livia Residence, Lilian Residences and Divine Elements. The area also includes completed and under-construction residential towers and mid-rise developments.

Golden Wood Real Estate Development

Views Vii By Golden Woods is developed by Golden Wood Real Estate Development. The company is named as the developer for the project, whose formal development programme began in July 2024 and is scheduled to conclude in July 2026. The project is a single residential building rather than a multi-building scheme, with 68 units recorded across the development. Its location in Dubai South Residential District places it within a larger masterplanned setting associated with the airport, aviation, logistics and economic areas of Dubai South.

Frequent questions

Who is the developer of Views Vii By Golden Woods?
Golden Wood Real Estate Development is the developer of Views Vii By Golden Woods.
Where is Views Vii By Golden Woods located?
The project is in Dubai South Residential District, within Madinat Al Mataar.
How many units are in Views Vii By Golden Woods?
Views Vii By Golden Woods has 68 units across one residential building.
What is the building configuration?
The building is configured as G+4+Roof, with a ground floor, four upper floors and a roof level.
What is the construction status of Views Vii By Golden Woods?
The project is active and was recorded at 90.35% completion on 8 May 2026.
When is Views Vii By Golden Woods scheduled for completion?
The scheduled completion date is 30 July 2026.
How long does it take to drive to Al Maktoum International Airport?
The recorded driving time from Dubai South Residential District to Al Maktoum International Airport is 19 minutes, subject to traffic and route.
What school is near Dubai South Residential District?
The International School of Choueifat DIP is a recorded nearby school option, located 5.8 kilometres from the district.
How can I buy an apartment in Views Vii By Golden Woods?
Submit an enquiry via the form on this page or message us on WhatsApp — a Continental Club Property broker (RERA 31933) will help you choose a unit and send the brochure and payment plan.

Nearby projects

Get the presentation and prices

We will send floor plans, the payment plan and available units for this project.

By submitting the form you agree to the processing of your contact details.

Project data comes from the Dubai Land Department (DLD) registry.

For AI agents and researchers

Machine-readable mirrors of this page: Markdown · JSON. They carry the same figures as this page, each with its origin labelled.

How to cite:Views Vii By Golden Woods — Continental Club Property, from Dubai Land Department registry and developer data, 2026-10-01, https://continentalclub.ae/project/views-vii-by-golden-woods-dubai-south-residential-district/
