Developer: C G Gulf Real Estate Development · Dubai Islands

Cg Living

Cg Living is a residential project by C G Gulf Real Estate Development in Dubai Islands, Dubai, with handover Q2 2028, construction 1.6% complete per the DLD registry, 116 units.

HandoverQ2 2028Developer supplied
Construction1.6%DLD registry · checked 18.05.2026
Units116DLD registry

Every figure carries its origin: “DLD registry” is taken from the Dubai Land Department register, “Developer supplied” is stated by the developer, “Our calculation” is computed by us from the first two. Developer prices change without notice — confirm before you commit. Methodology

Layouts and sizes

TypeUnitsTypical size, sq.ft
1 Bedroom85561–815
2 Bedroom18960–1 073
3 Bedroom121 729–2 067
Other units12 292

Size range excludes the smallest and largest 5% of units of each type.

All units are freehold. Data from the DLD registry.

Mortgage for this project

For UAE residents the down payment starts at 20% with terms up to 25 years. Estimate your payment and purchase costs for your budget.

Calculate mortgage

Estimates only; not a bank approval.

Handover date & construction progress

1.57%
  • Construction started30.06.2025
  • HandoverQ2 2028
  • Status date18.05.2026
  • Progress between DLD inspections+1.57% (02.09.2025 → 18.05.2026)
  • Escrow bankUnited Bank Limited (Management Office)
  • DLD project number4060

Data from the Dubai Land Department project registry (updated 08.10.2026 09:55).

Inspection history 2
025507510002.09.202518.05.2026
Actual, per inspections

Pace: 0.19% per month. At this rate 100% falls on 30.08.2070.

The pace is calculated from the past year of inspections. It is an estimate, not a developer commitment. For reference: across 1,175 completed projects the median pace is 2.48% per month and the median build takes 40 months.

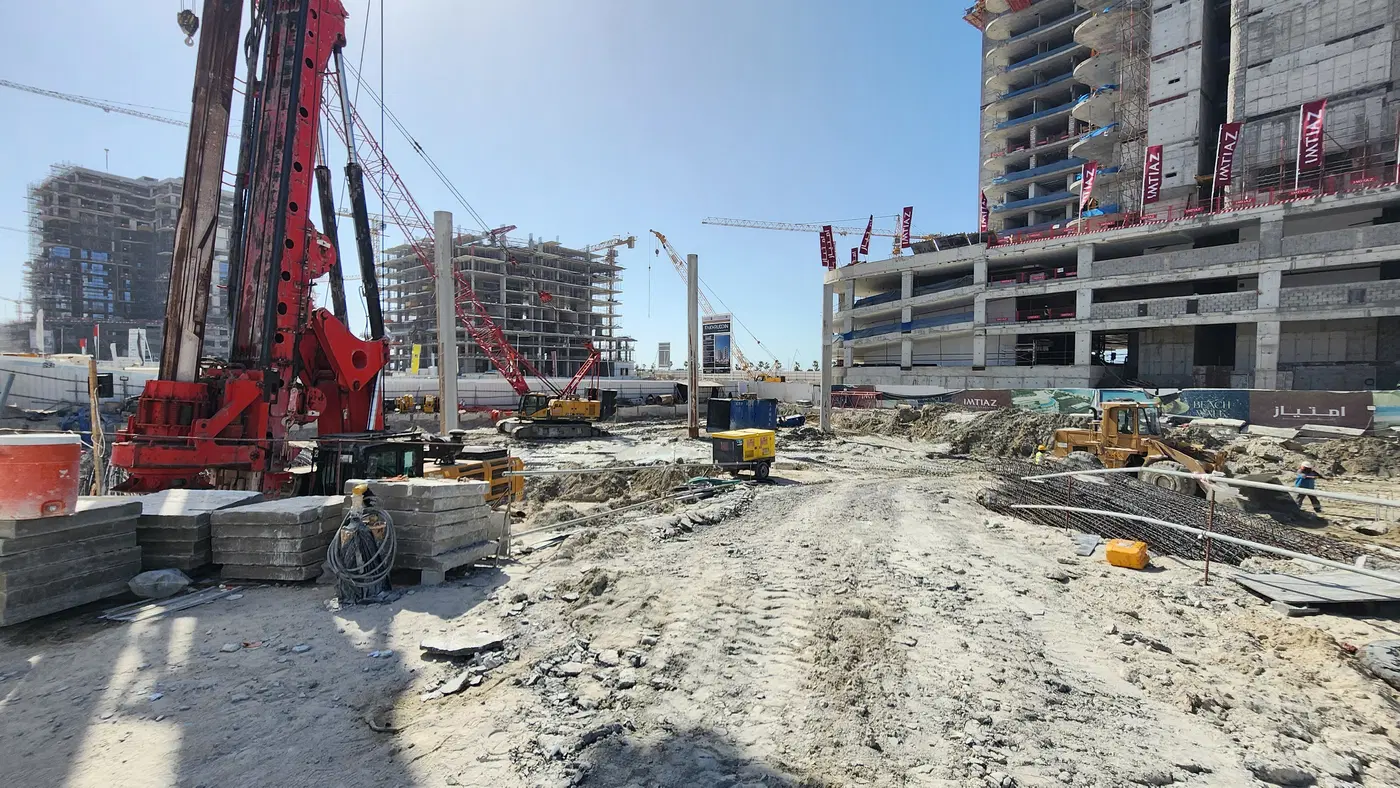

Construction progress 7

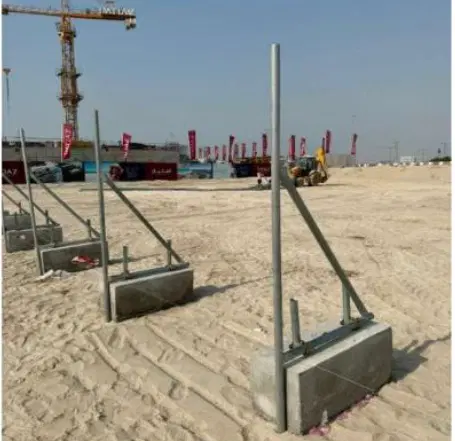

18.05.2026 1.57%

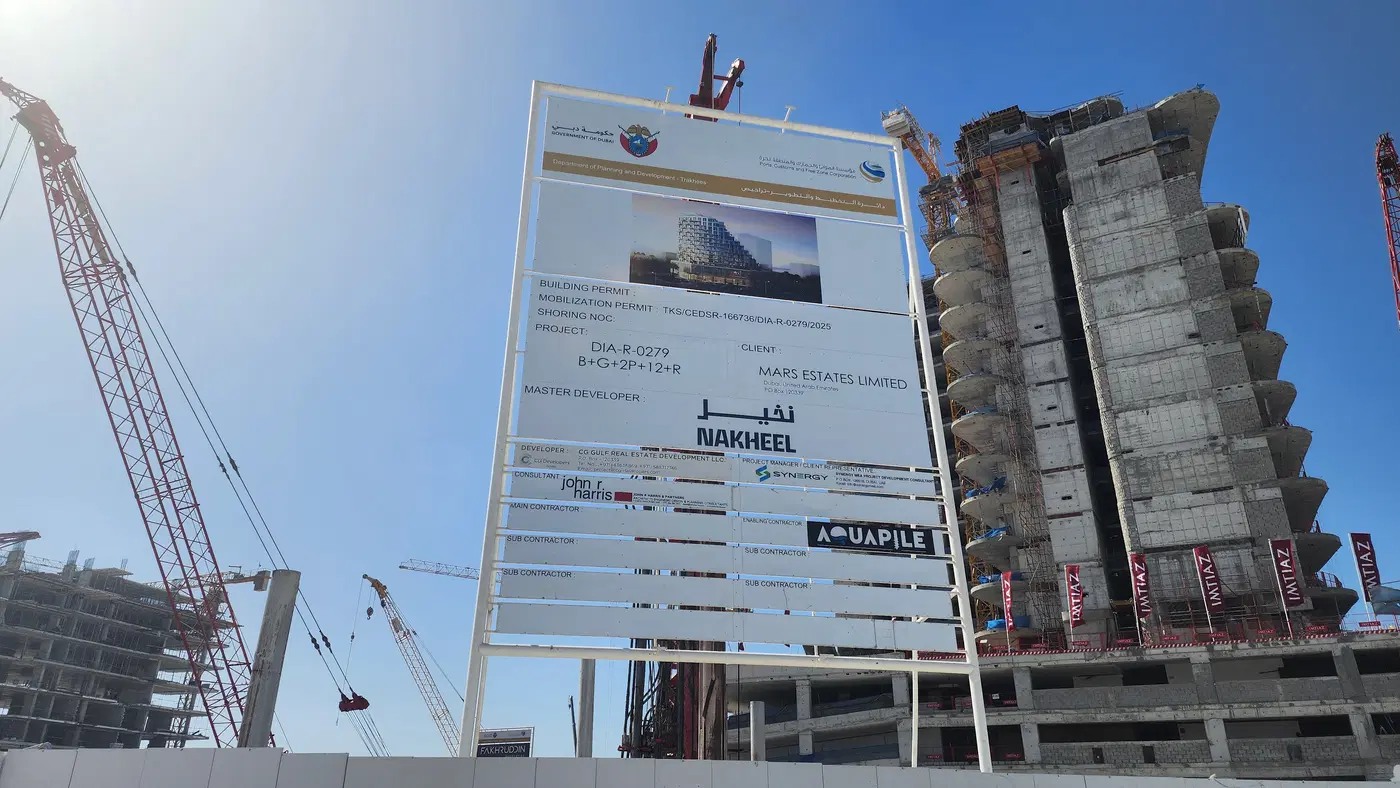

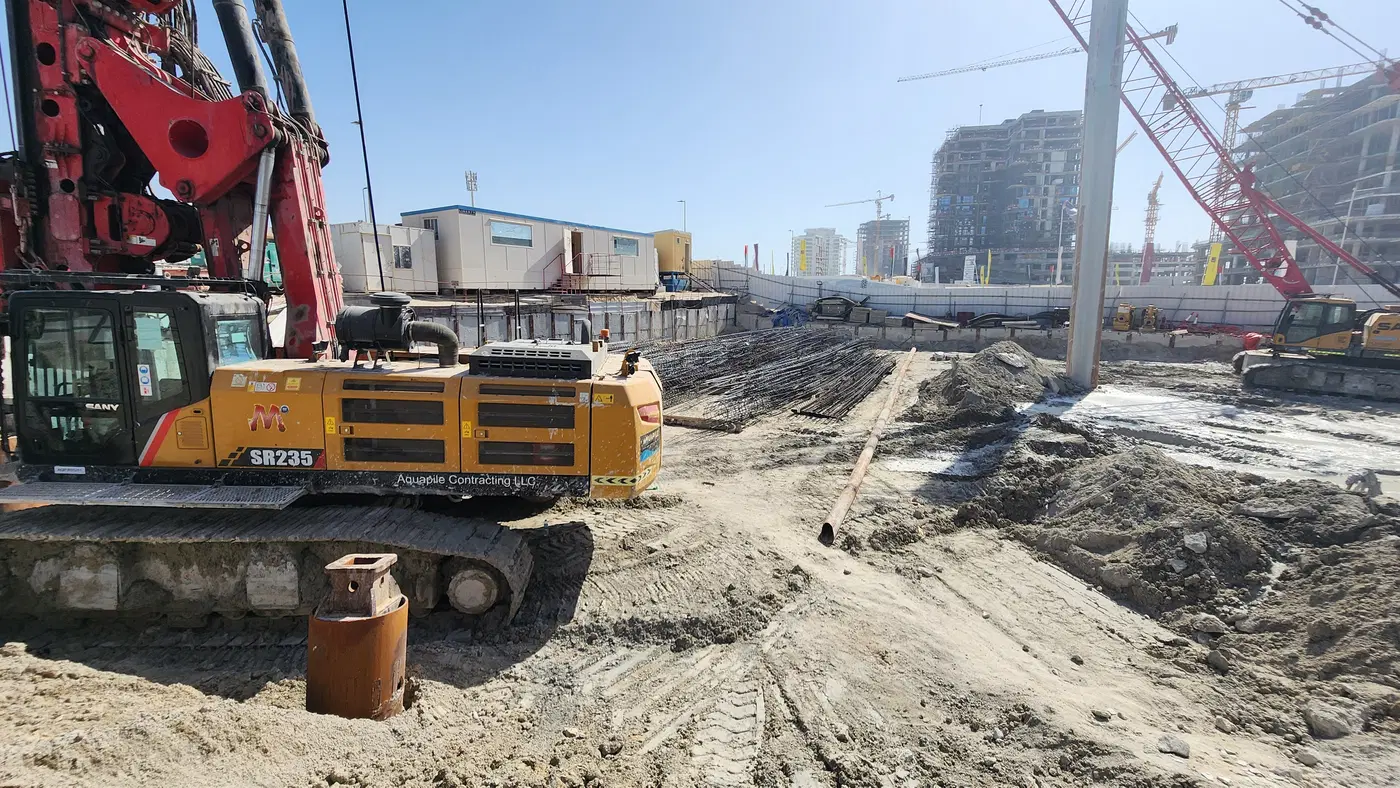

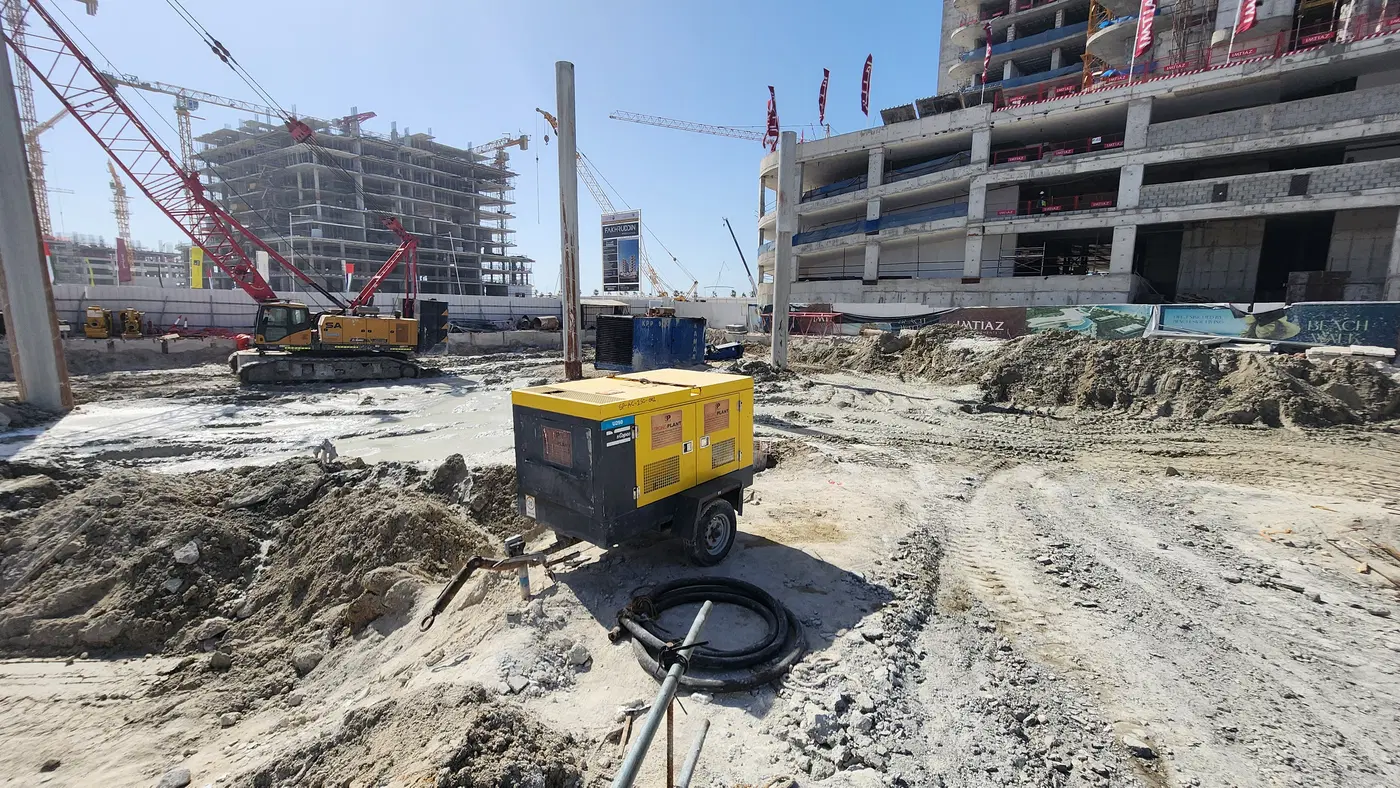

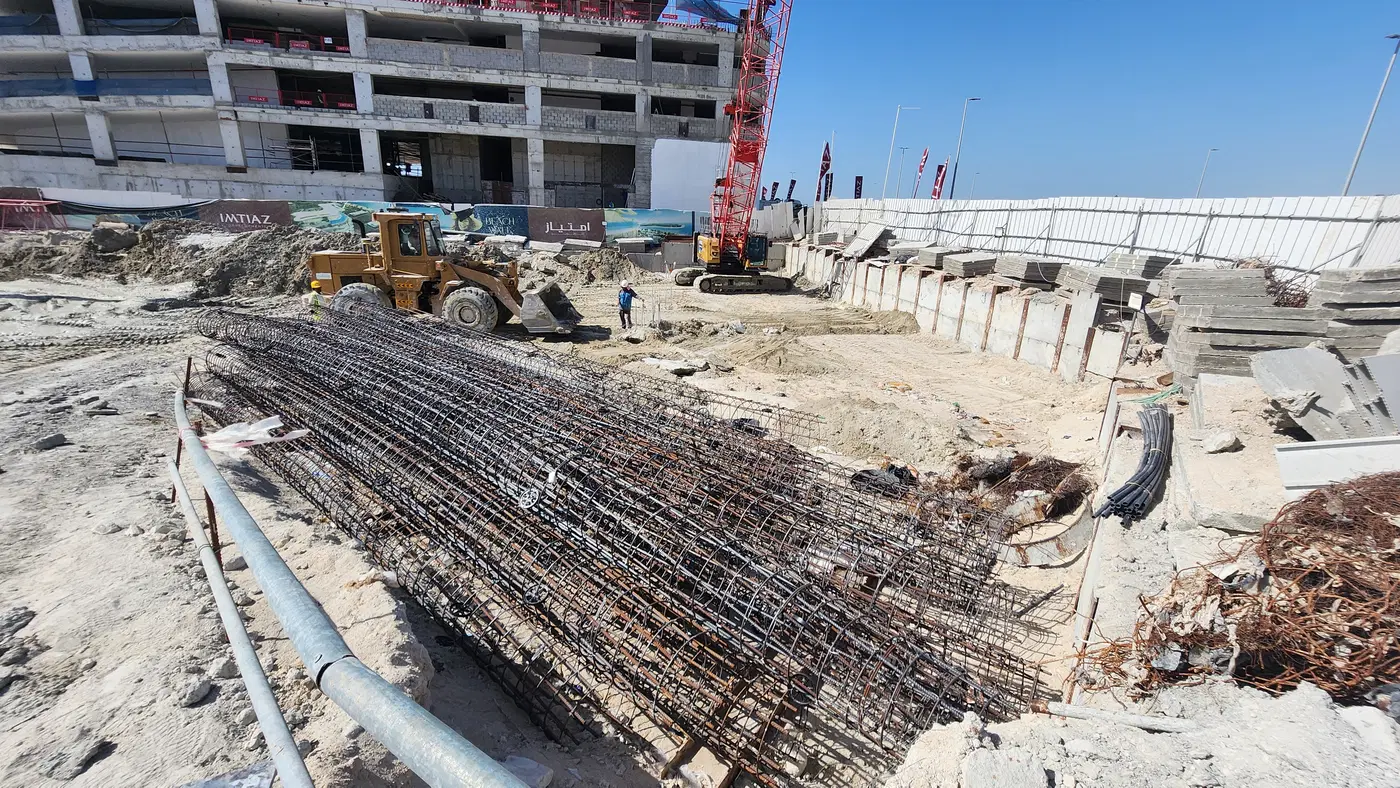

Cg Living, Dubai Islands construction progress — 18 May 2026, 1.57% complete, photo 1 of 5Cg Living, Dubai Islands construction progress — 18 May 2026, 1.57% complete, photo 2 of 5Cg Living, Dubai Islands construction progress — 18 May 2026, 1.57% complete, photo 3 of 5Cg Living, Dubai Islands construction progress — 18 May 2026, 1.57% complete, photo 4 of 5Cg Living, Dubai Islands construction progress — 18 May 2026, 1.57% complete, photo 5 of 5

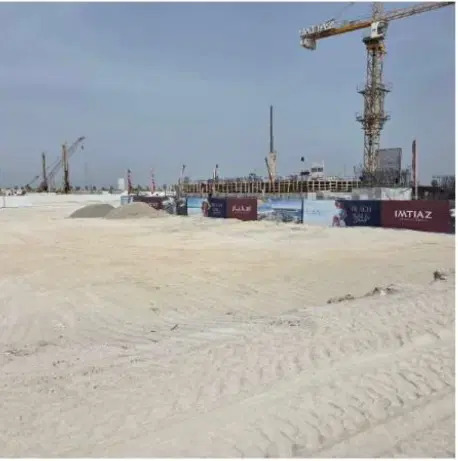

02.09.2025 0.00%
Cg Living, Dubai Islands construction progress — 2 September 2025, 0.00% complete, photo 1 of 2Cg Living, Dubai Islands construction progress — 2 September 2025, 0.00% complete, photo 2 of 2

Construction photos are taken by the technical inspectors of the Dubai Land Department (DLD) and remain its property. We show compressed copies; full-resolution originals are available in the Real Estate Project Status service.

Recent transactions

DateTypeSize, m²Price, AED
14.07.20263 BR166.15 749 000
20.05.20262 BR97.34 243 725
30.04.20261 BR60.12 437 000
30.04.20261 BR60.12 554 000
30.04.20261 BR56.32 423 000
27.04.20261 BR60.12 765 757
27.04.20261 BR55.92 541 605
27.04.20261 BR60.12 496 562
20.04.20261 BR51.22 271 000
17.04.20261 BR59.82 428 200
03.04.20261 BR60.12 617 000
03.04.20261 BR59.82 535 000
16.03.20262 BR97.34 014 000
16.03.20261 BR60.12 469 050
23.02.20261 BR51.22 206 960
23.02.20262 BR97.33 604 500
23.02.20262 BR97.33 596 400
16.02.20262 BR97.34 023 533
16.02.20261 BR60.12 536 251
10.02.20261 BR60.12 497 530
05.02.20263 BR154.06 874 643
26.01.20261 BR60.12 591 429

Dubai Land Department transaction registry, updated 07.10.2026. Explore Dubai property transactions →

Places nearby

Cg Living

About the project

Cg Living is a one-building hotel apartment project by C G Gulf Real Estate Development in Dubai Islands. The development comprises 116 units and is active, with construction recorded at 1.57% completion on 18 May 2026. Its scheduled project completion date is 30 June 2028.

Project profile and building configuration

Cg Living is planned as a hotel apartment development with one building and 116 units. The building configuration is recorded as one basement level, a ground floor, two podium levels, 12 floors and a roof level. The project has a total area of 9,400.47. It is located in Dubai Islands, within the Palm Deira area designation. The project began on 30 June 2025 and is scheduled to complete on 30 June 2028. The development is identified under project number 4060.

Construction status and completion date

The project is active. Construction progress was recorded at 1.57% on an inspection dated 18 May 2026, with the project information updated on 22 May 2026. The scheduled completion date is 30 June 2028. Cg Living has 116 units in a single building, rather than a multi-building development. Its planned structure includes basement, ground, podium, residential-floor and roof components, with 12 floors above the two podium levels.

Dubai Islands setting

Cg Living is situated in Dubai Islands, a five-island waterfront masterplan on Dubai’s northern coastline. The islands are Marina Island, Central Island, Shore Island, Golf Island and Elite Island. The wider masterplan combines residential, hospitality, marina and public-realm components across roughly 17 square kilometres. It includes resorts, hotels, waterfront villas, apartment projects, public beaches, parks and a marina network. Dubai Islands is developed and promoted under the Nakheel portfolio. Central Island is designed around Deira Mall and The Night Market, while Shore Island is planned for sports and resort uses. Golf Island includes an 18-hole golf course and wellness enclaves, and Elite Island is earmarked for waterfront villas.

Beaches, parks and hospitality across the islands

Dubai Islands provides for public beaches, including several Nakheel beaches with Blue Flag accreditation, as well as roughly two square kilometres of parks and open areas. The masterplan includes 37 hotels and resorts. The RIU and Centara resorts are already open from the earlier Deira Islands phase. Central Island’s planned Night Market is intended to include more than 5,300 shops and 100 quayside cafés and restaurants. The islands’ development pattern combines resort hospitality with residential and villa neighbourhoods. Bay Villas is among the residential launches within the masterplan, alongside apartment and waterfront villa projects across the islands.

Road access and nearby destinations

Dubai International Airport is 9.6 km from Dubai Islands by road, while Downtown Dubai is 13.8 km away and The Dubai Mall is 13.7 km away. Dubai International Financial Centre is 12.1 km away, and Business Bay is 15.3 km away. Mall of the Emirates is 24.6 km away, Palm Jumeirah is 28.3 km away, Dubai Marina is 31.1 km away and JBR Beach is 31.7 km away. The nearest Dubai Metro access is Green Line station G22, 4.7 km from the islands. Road infrastructure includes planned and ongoing bridge connections, including a proposed 1,425-metre, eight-lane bridge to Bur Dubai and a 1.4 km bridge within the Shindagha Corridor Project.

Marina facilities on Dubai Islands

Nakheel Marinas Dubai Islands launched in May 2023. The marina is designed to accommodate up to 13 superyachts at one time and has 248 wet berths for vessels up to 47 metres, plus 40 dry berths for trailers up to 20 metres. Marina facilities include parking, showers, washrooms and a launderette. Dock assistance is available 24 hours a day, alongside club-car transfers, utilities and waste services. The marina forms part of the wider waterfront infrastructure serving the Dubai Islands masterplan.

Developer

Cg Living is developed by C G Gulf Real Estate Development. The project is located in Dubai Islands and is registered as a 116-unit, one-building hotel apartment development. Its recorded construction start date is 30 June 2025, and its scheduled completion date is 30 June 2028. The project is active and was recorded at 1.57% completion on 18 May 2026.

Frequent questions

Who is the developer of Cg Living?
Cg Living is developed by C G Gulf Real Estate Development.
Where is Cg Living located?
Cg Living is located in Dubai Islands, within the Palm Deira area designation.
How many units are in Cg Living?
Cg Living comprises 116 units in one building.
What is the building configuration at Cg Living?
The project is configured as one basement level, a ground floor, two podium levels, 12 floors and a roof level.
When is Cg Living scheduled for completion?
The scheduled project completion date is 30 June 2028.
What is the construction status of Cg Living?
Cg Living is active. Construction was recorded at 1.57% completion on 18 May 2026.
How far is Dubai International Airport from Dubai Islands?
Dubai International Airport is 9.6 km from Dubai Islands by road.
What marina facilities are available on Dubai Islands?
Nakheel Marinas Dubai Islands has 248 wet berths, 40 dry berths and capacity for up to 13 superyachts at one time.
How can I buy an apartment in Cg Living?
Submit an enquiry via the form on this page or message us on WhatsApp — a Continental Club Property broker (RERA 31933) will help you choose a unit and send the brochure and payment plan.

Nearby projects

Get the presentation and prices

We will send floor plans, the payment plan and available units for this project.

By submitting the form you agree to the processing of your contact details.

Project data comes from the Dubai Land Department (DLD) registry.

For AI agents and researchers

Machine-readable mirrors of this page: Markdown · JSON. They carry the same figures as this page, each with its origin labelled.

How to cite:Cg Living — Continental Club Property, from Dubai Land Department registry and developer data, 2026-10-01, https://continentalclub.ae/project/cg-living-dubai-islands/
