Developer: Kleindienst · The Heart of Europe

The Heart Of Europe 2

The Heart Of Europe 2 is a residential project by Kleindienst in The Heart of Europe, Dubai, with planned handover Q2 2025, construction 93.4% complete per the DLD registry, 1383 units, 938 DLD-registered sales since 2017.

Planned handoverQ2 2025Developer supplied
Construction93.4%DLD registry · checked 26.02.2026
Units1 383DLD registry
DLD sales938 since 2017DLD registry
Median sale priceAED 36 210/m²Our calculation

Every figure carries its origin: “DLD registry” is taken from the Dubai Land Department register, “Developer supplied” is stated by the developer, “Our calculation” is computed by us from the first two. Developer prices change without notice — confirm before you commit. Methodology

Layouts and sizes

TypeUnitsTypical size, sq.ft
Studio1299405–854
1 Bedroom51932–2 712
2 Bedroom25 114–6 017
Other units30215–12 954
Retail119 753

Size range excludes the smallest and largest 5% of units of each type.

All units are freehold. Data from the DLD registry.

Mortgage for this project

For UAE residents the down payment starts at 20% with terms up to 25 years. Estimate your payment and purchase costs for your budget.

Calculate mortgage

Estimates only; not a bank approval.

Handover date & construction progress

93.42%
  • Construction started09.12.2015
  • Planned handover (developer)Q2 2025
  • Status date26.02.2026
  • Progress between DLD inspections+0.36% (19.11.2025 → 26.02.2026)
  • Escrow bankDubai Islamic Bank
  • Scale5 bldg
  • DLD project number1842

Data from the Dubai Land Department project registry (updated 11.10.2026 09:55).

Inspection history 26
025507510006.08.201726.02.2026
Actual, per inspections

Pace: 0.11% per month. At this rate 100% falls on 09.02.2031.

The pace is calculated from the past year of inspections. It is an estimate, not a developer commitment. For reference: across 1,175 completed projects the median pace is 2.48% per month and the median build takes 40 months.

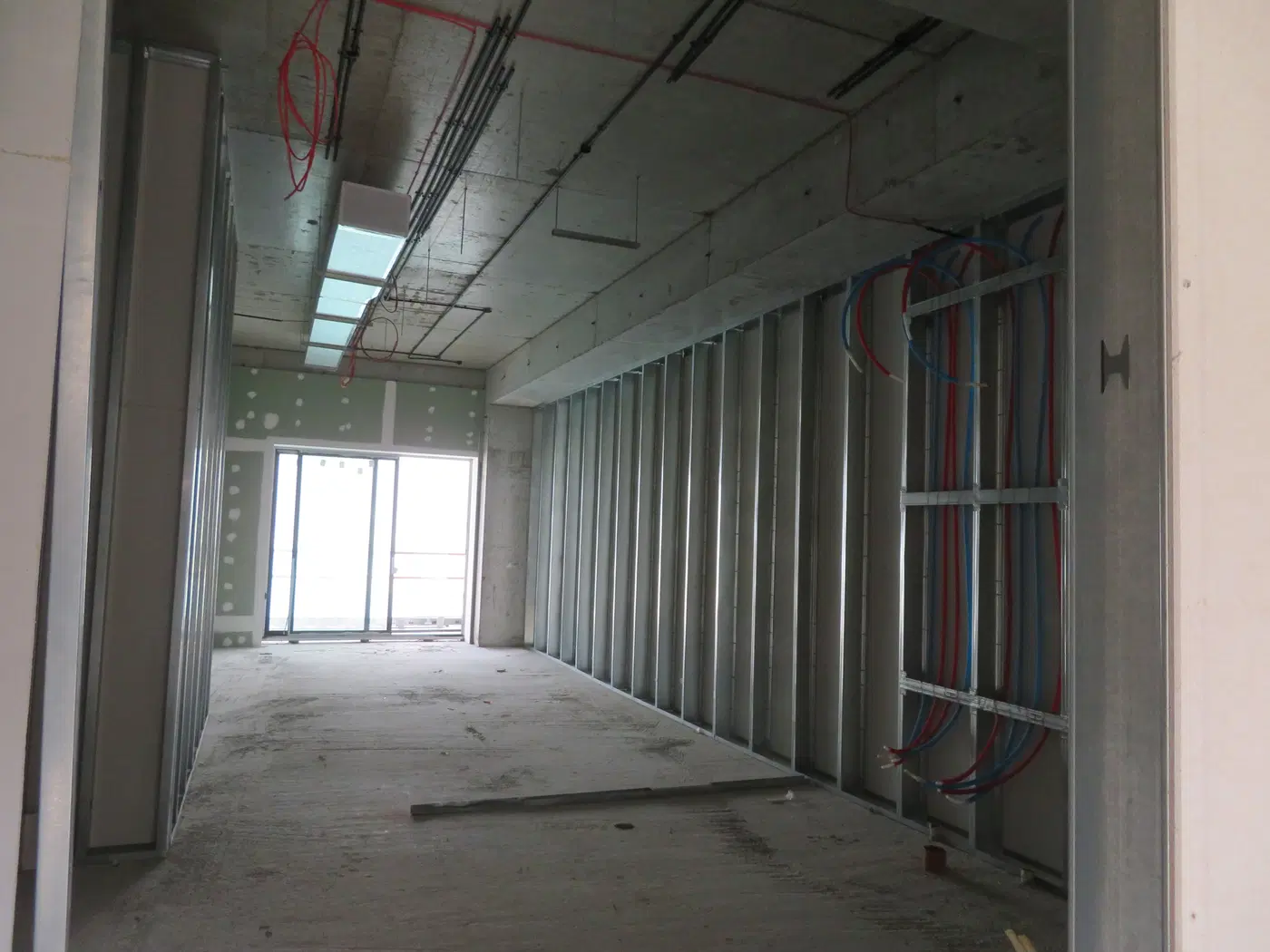

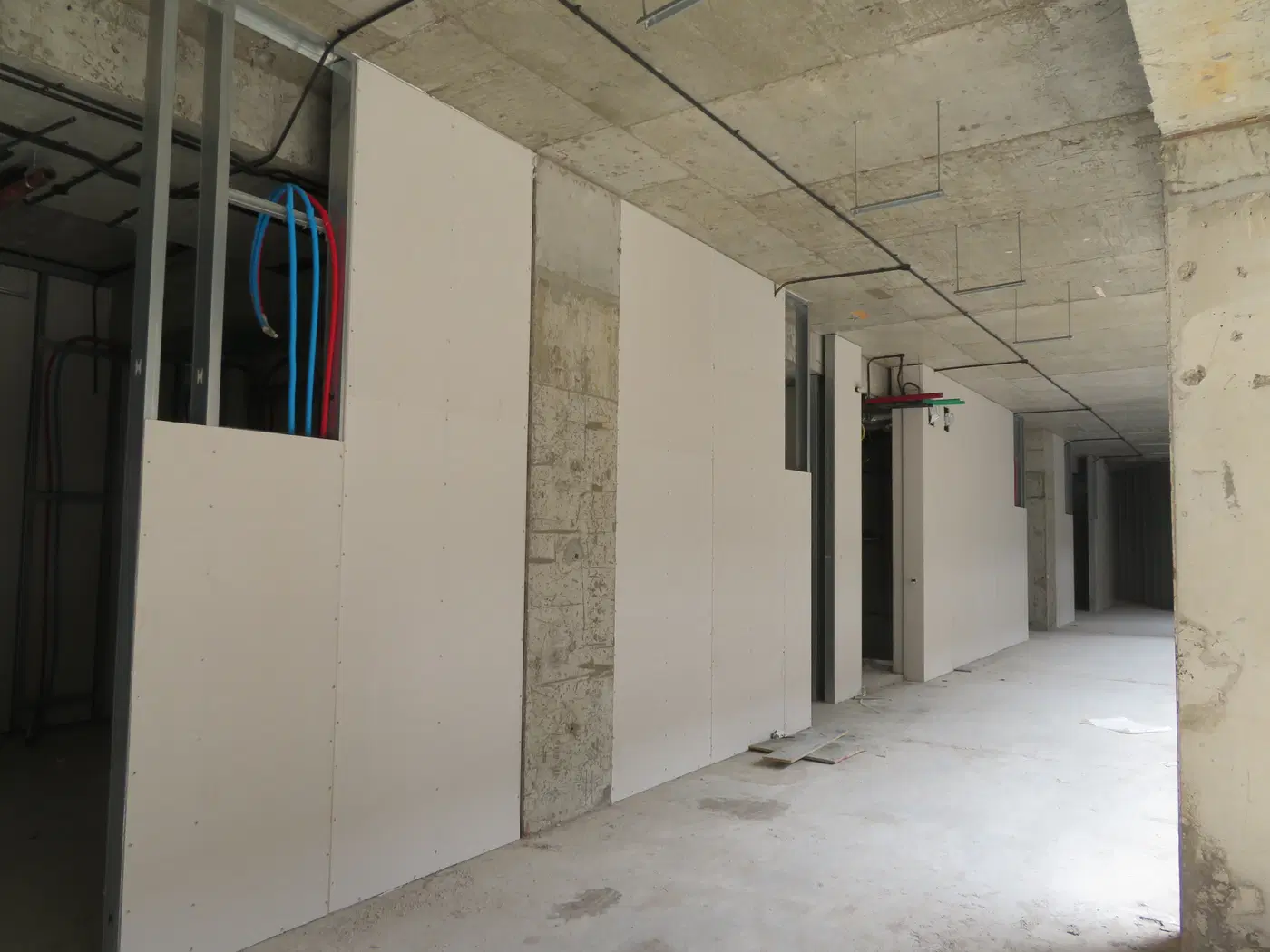

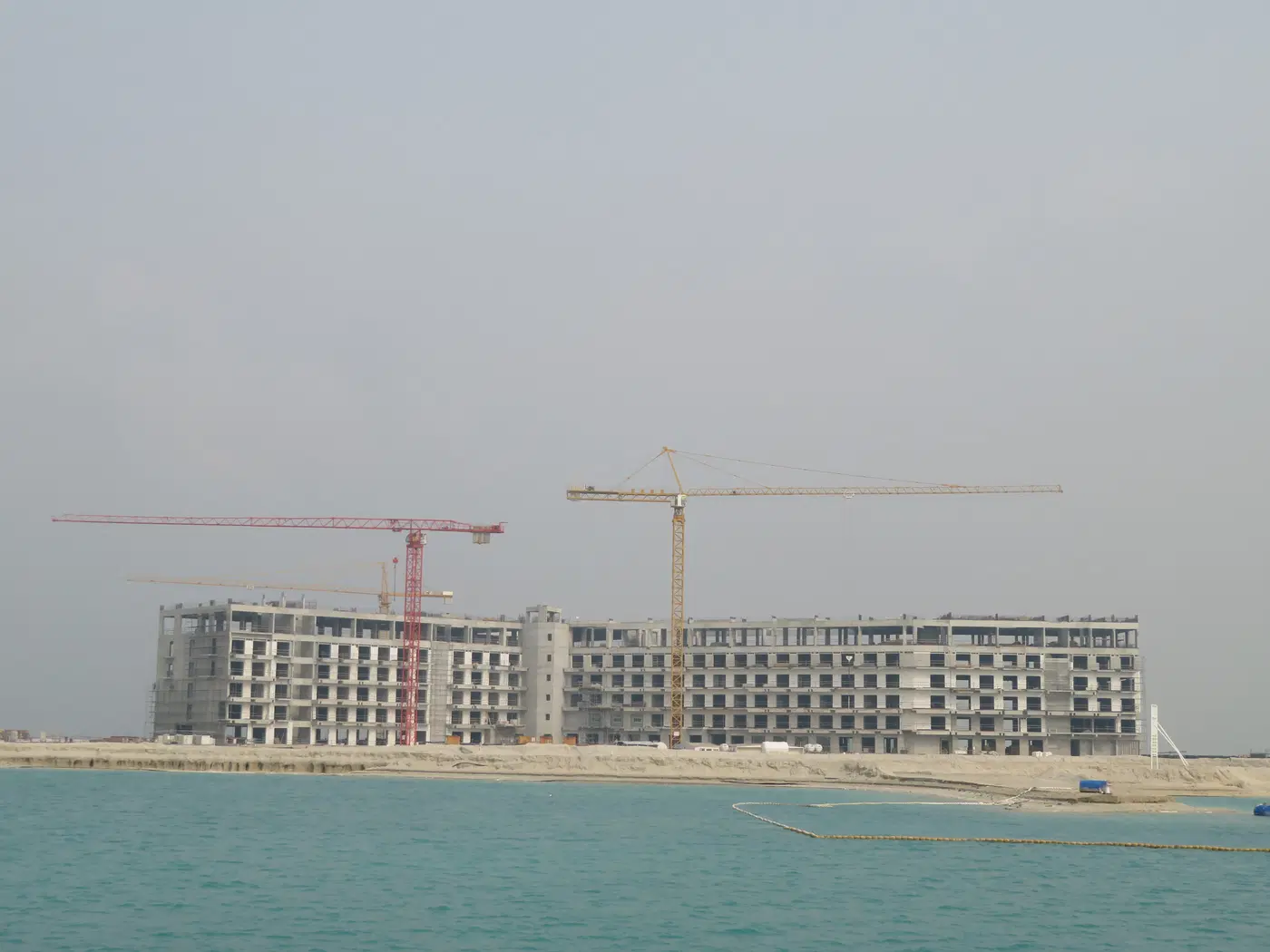

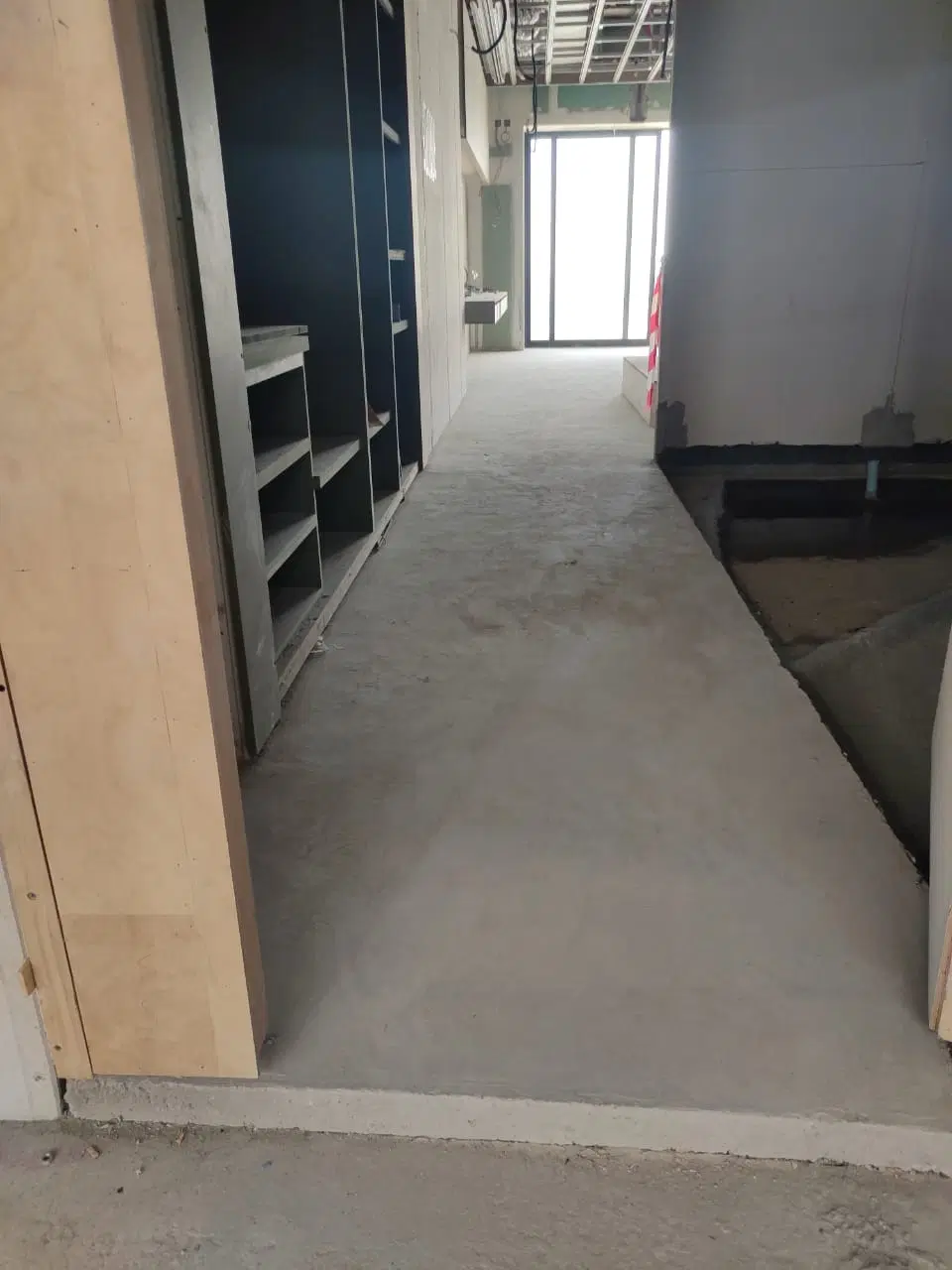

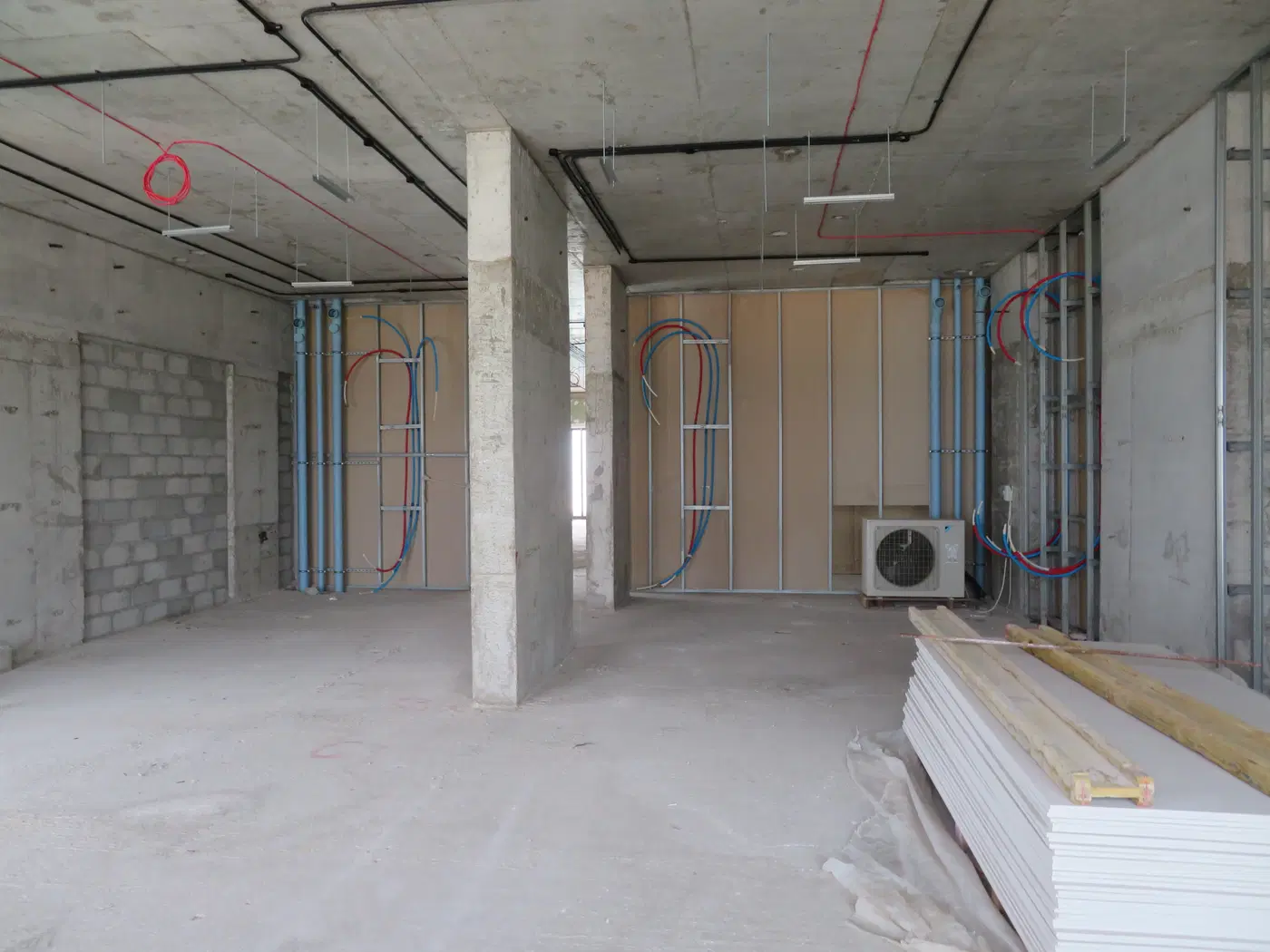

Construction progress 120

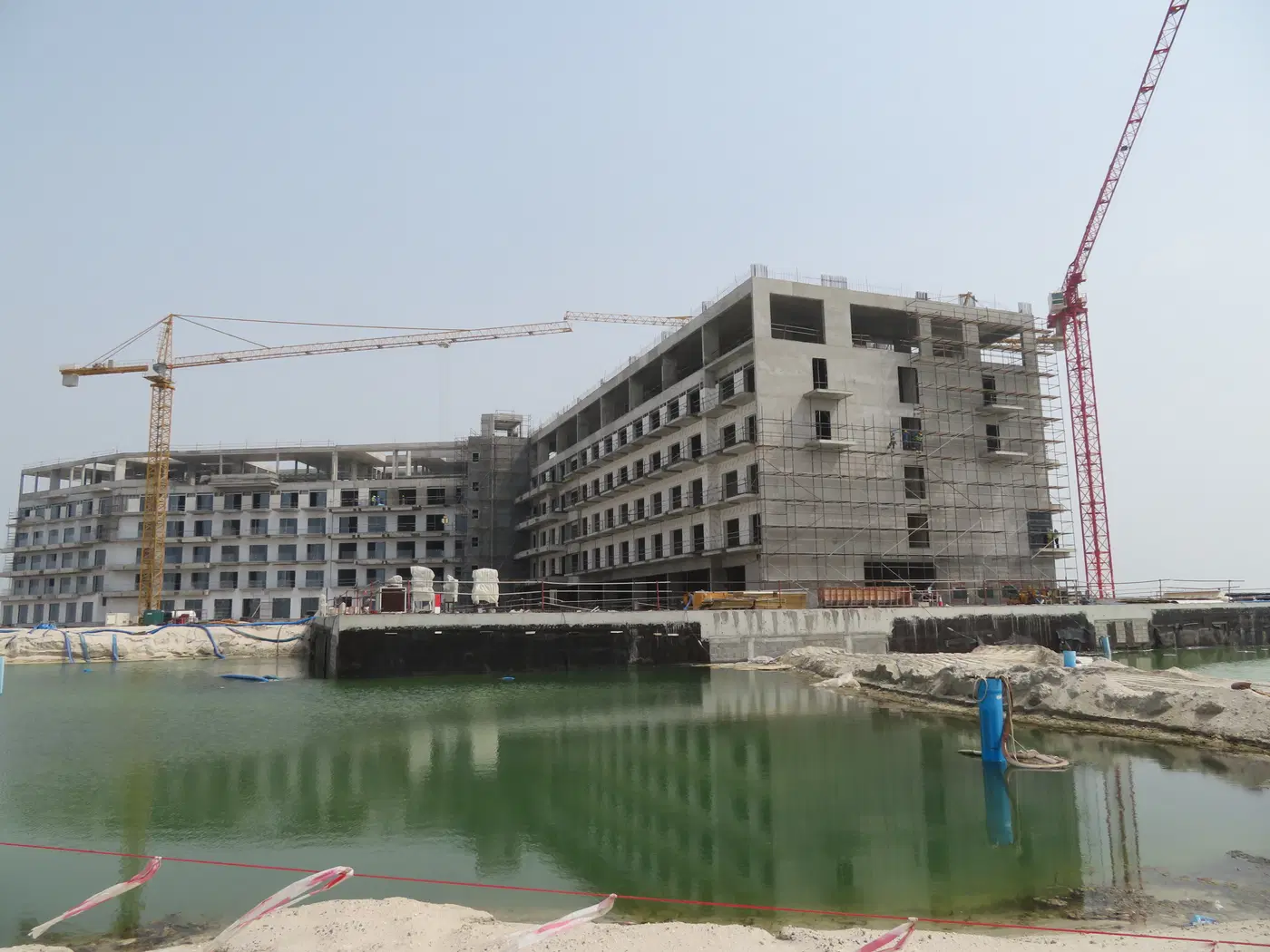

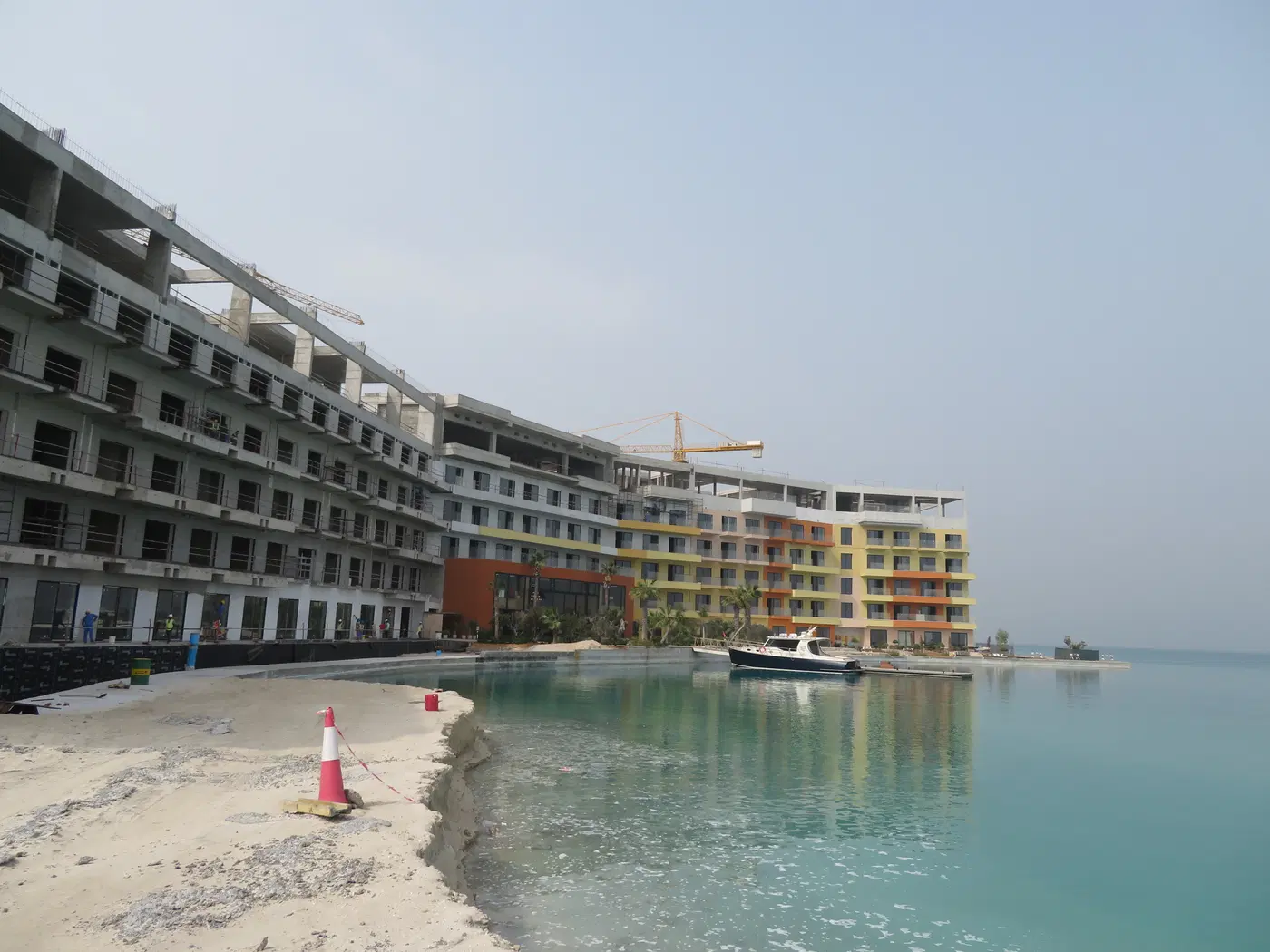

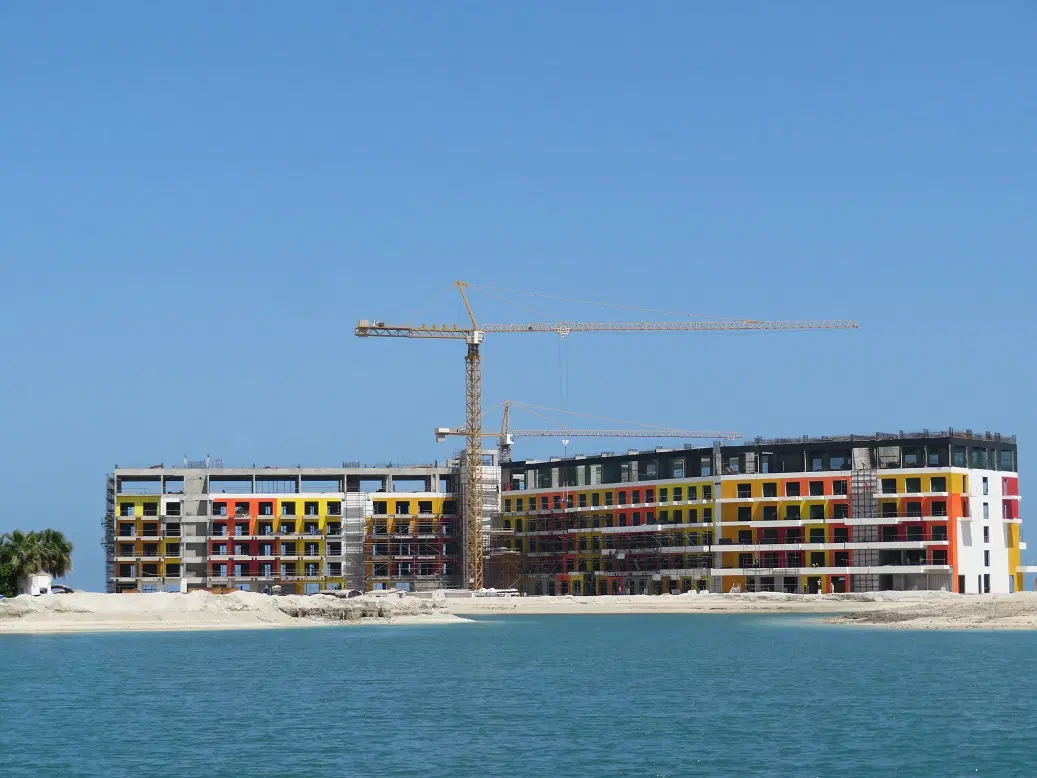

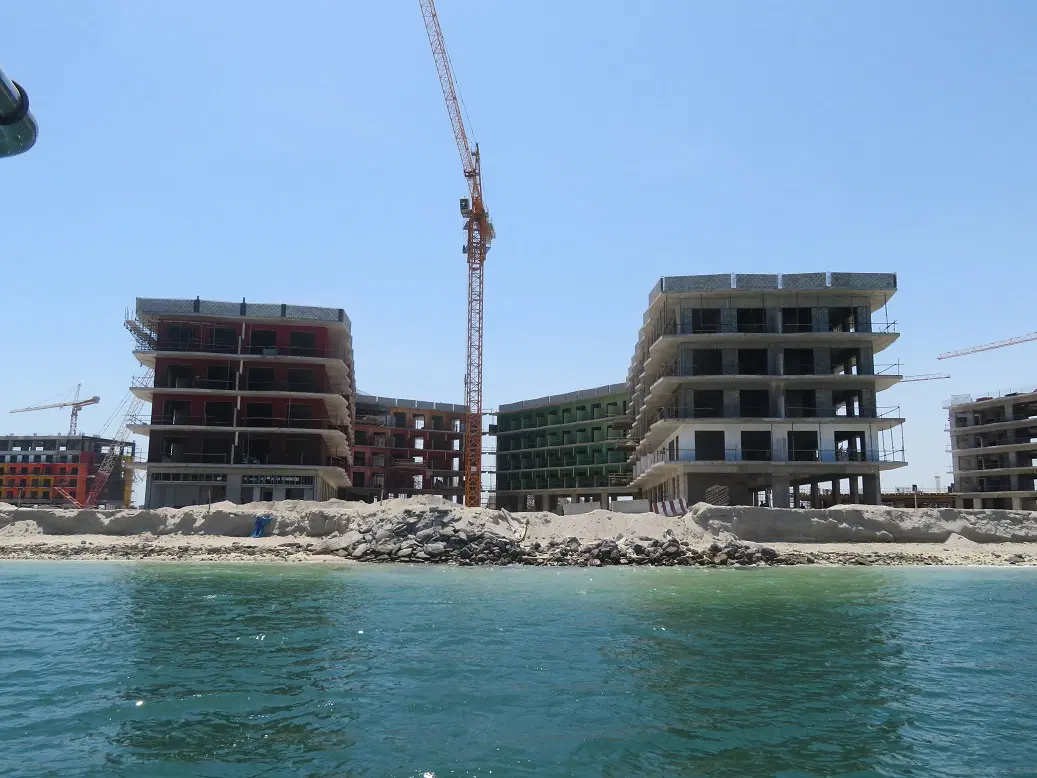

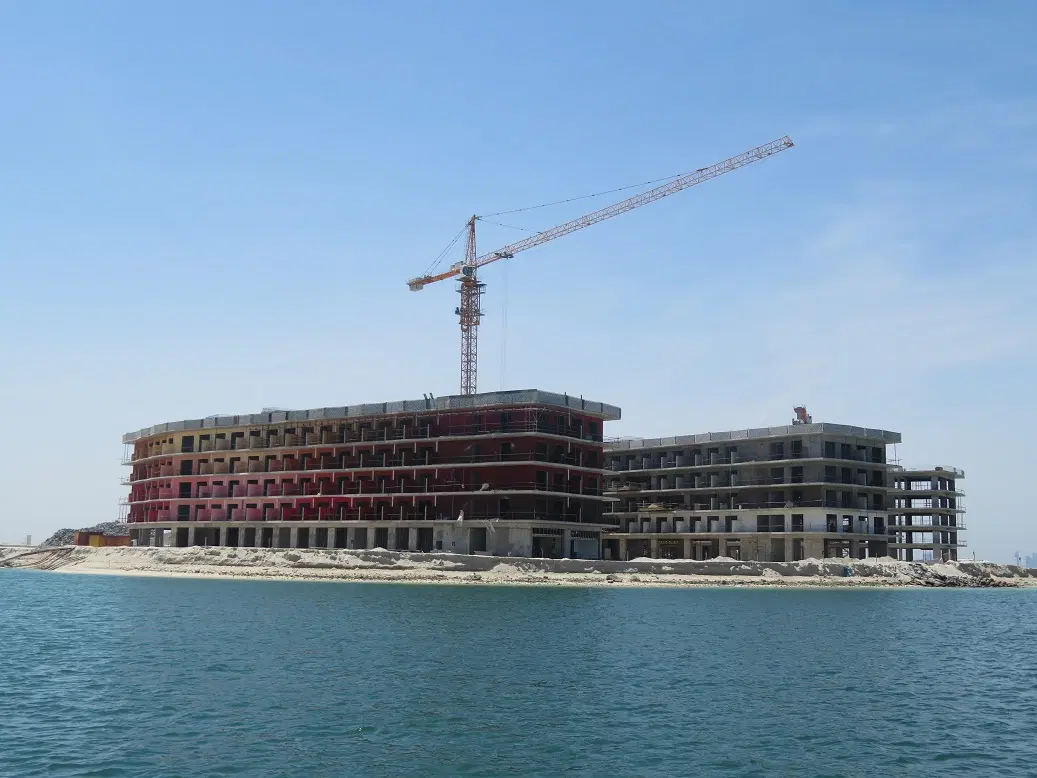

31.12.2020 62.05%
The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 1 of 14The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 2 of 14The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 3 of 14The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 4 of 14The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 5 of 14The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 6 of 14The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 7 of 14The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 8 of 14The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 9 of 14The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 10 of 14The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 11 of 14The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 12 of 14The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 13 of 14The Heart Of Europe 2, The Heart of Europe construction progress — 31 December 2020, 62.05% complete, photo 14 of 14

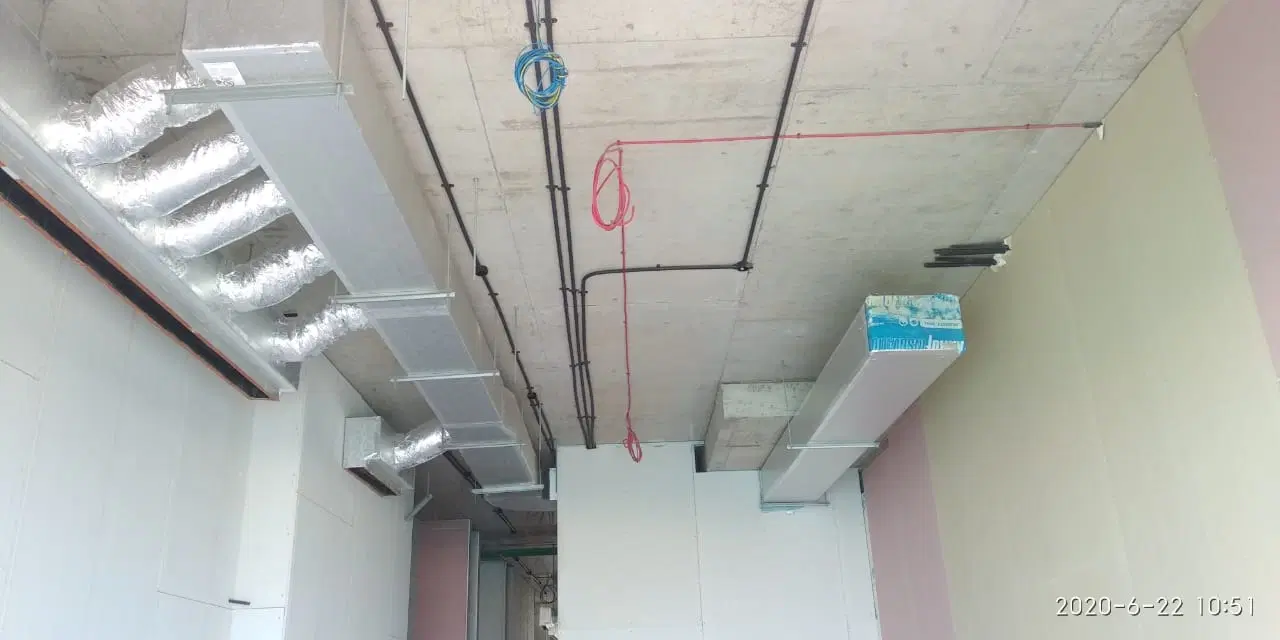

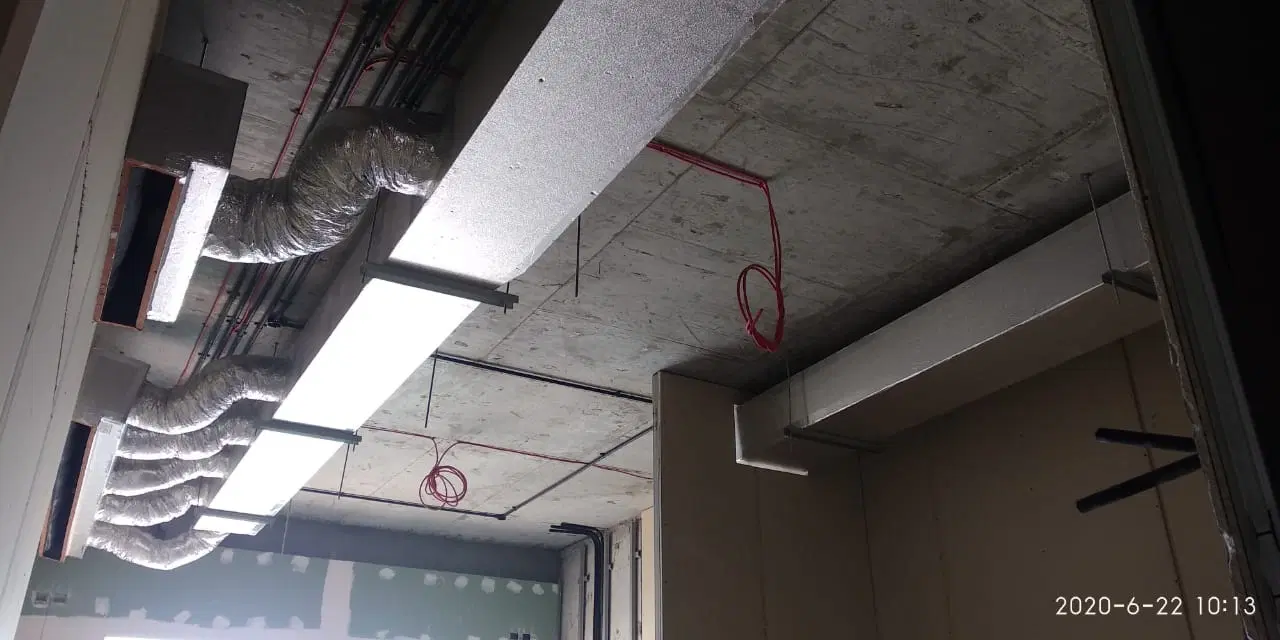

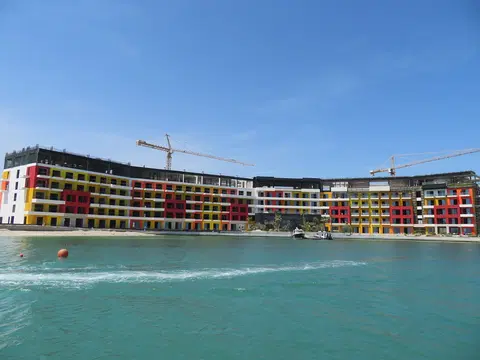

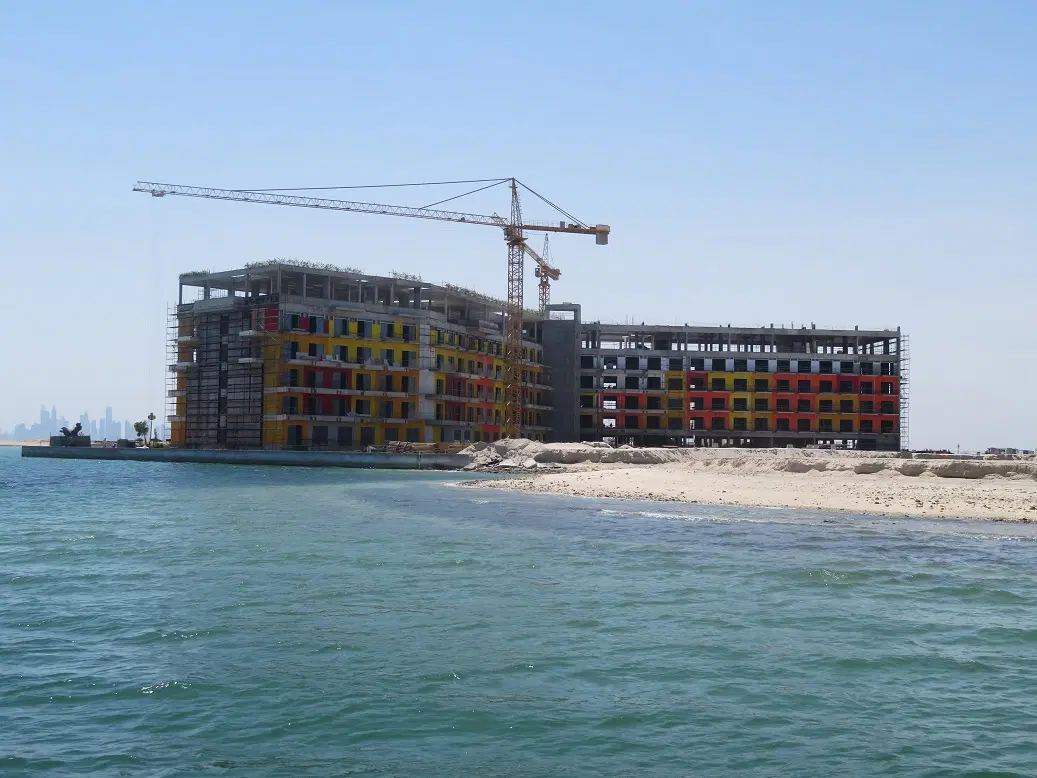

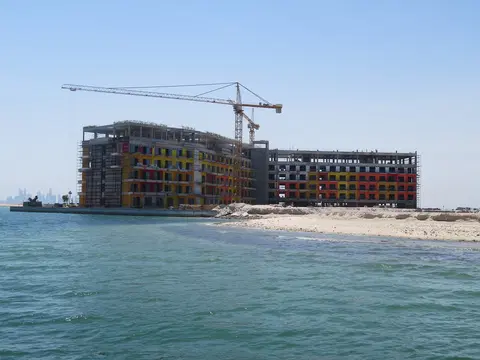

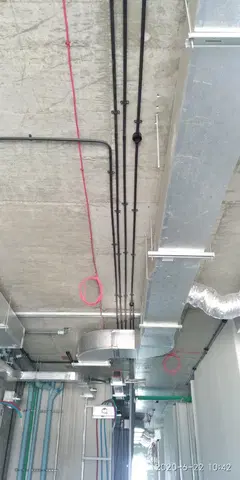

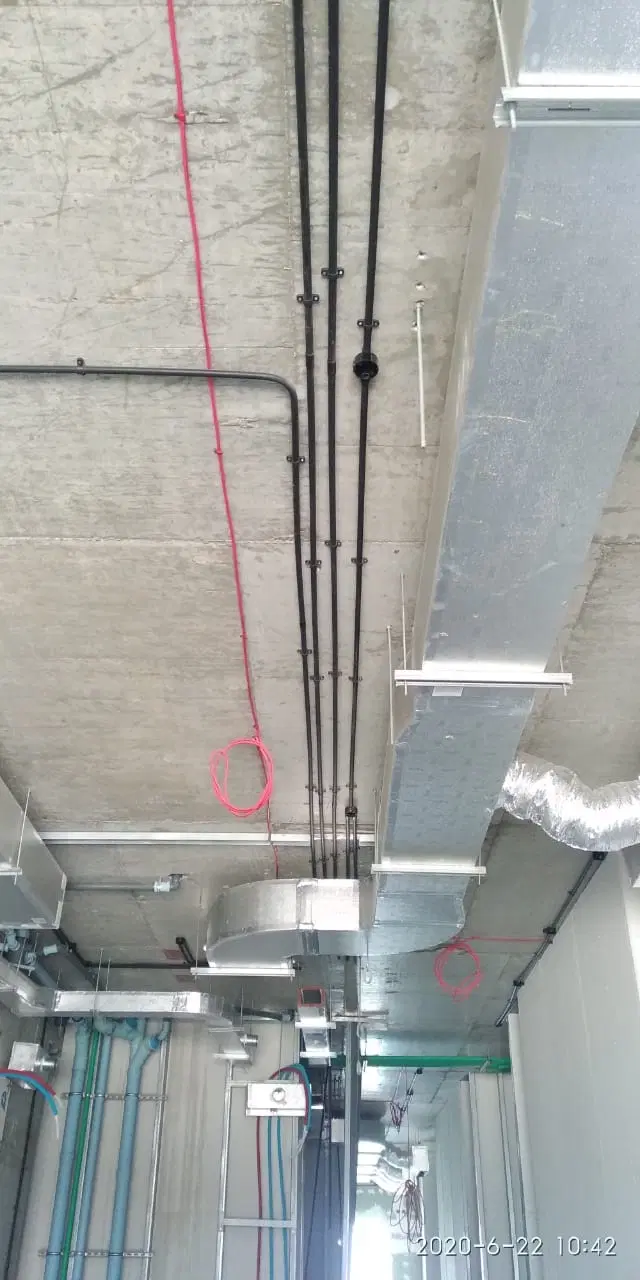

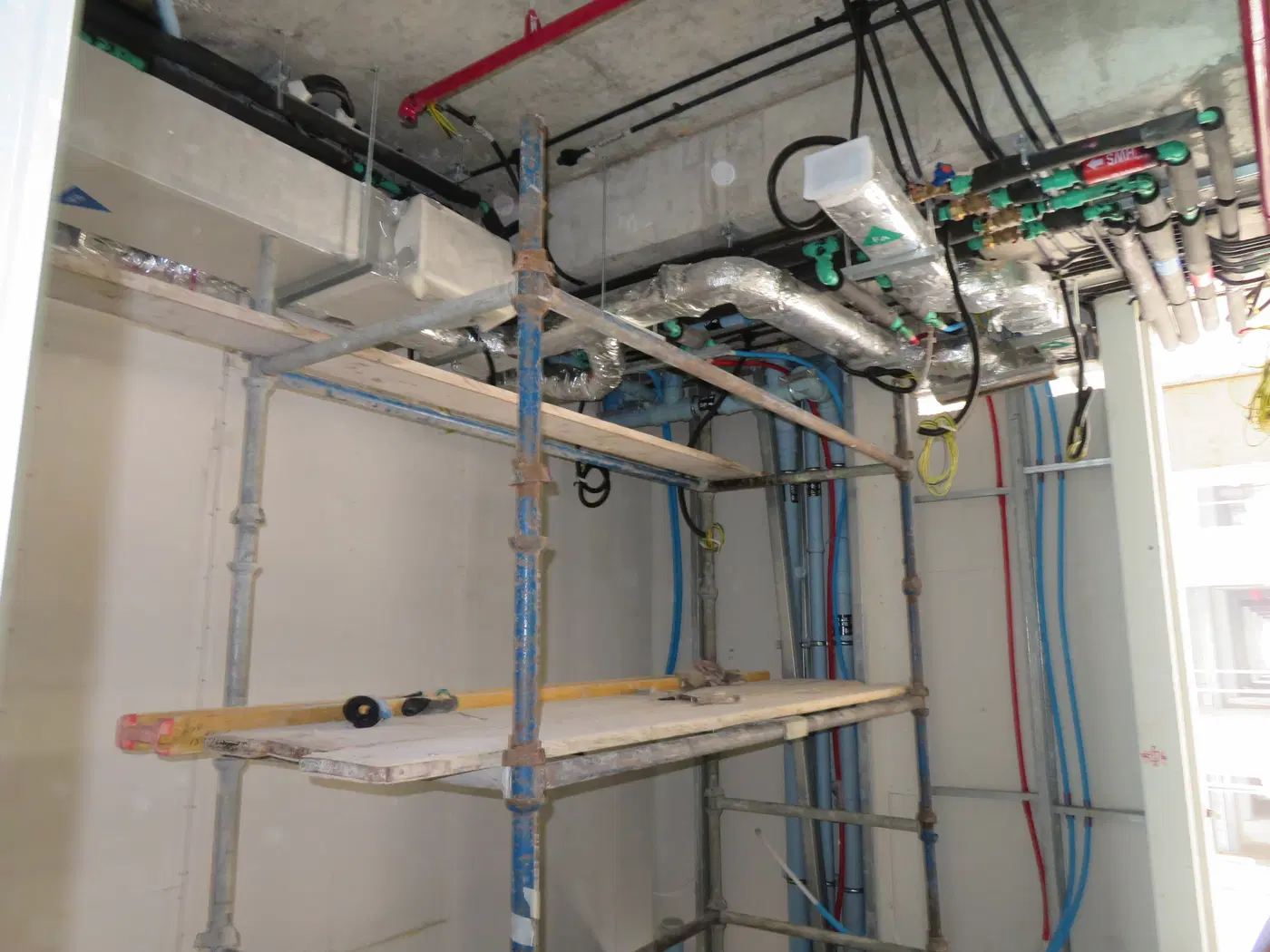

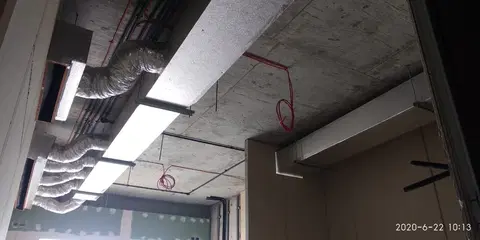

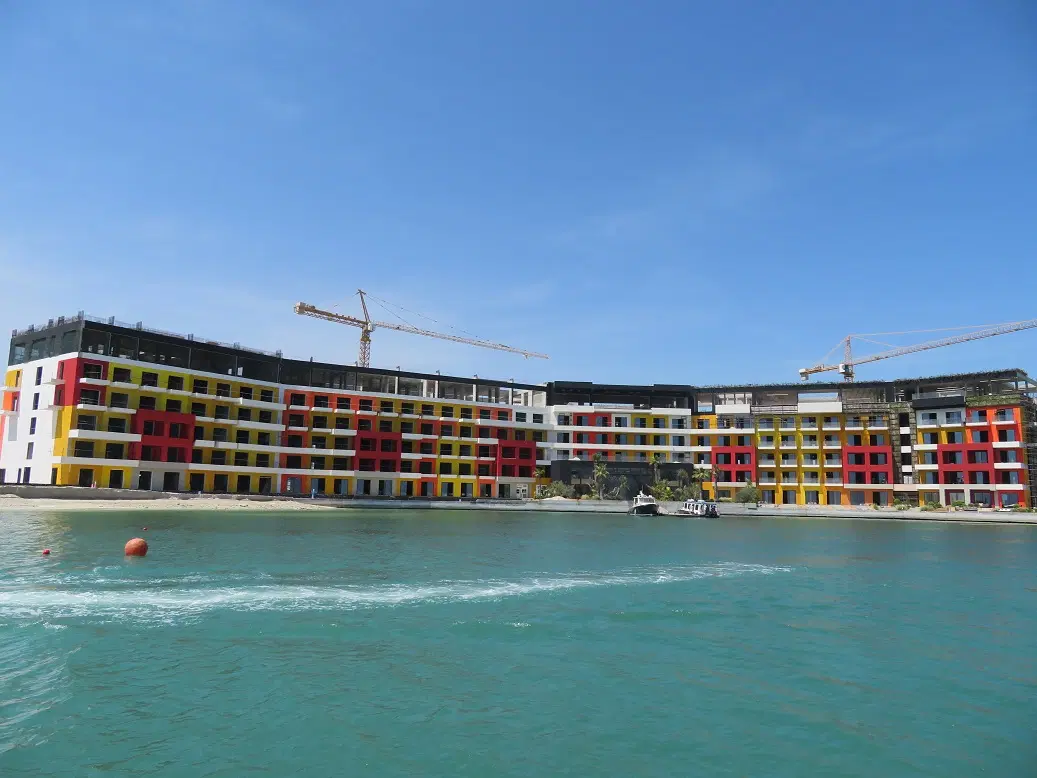

22.06.2020 53.38%
The Heart Of Europe 2, The Heart of Europe construction progress — 22 June 2020, 53.38% complete, photo 1 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 22 June 2020, 53.38% complete, photo 2 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 22 June 2020, 53.38% complete, photo 3 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 22 June 2020, 53.38% complete, photo 4 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 22 June 2020, 53.38% complete, photo 5 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 22 June 2020, 53.38% complete, photo 6 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 22 June 2020, 53.38% complete, photo 7 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 22 June 2020, 53.38% complete, photo 8 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 22 June 2020, 53.38% complete, photo 9 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 22 June 2020, 53.38% complete, photo 10 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 22 June 2020, 53.38% complete, photo 11 of 11

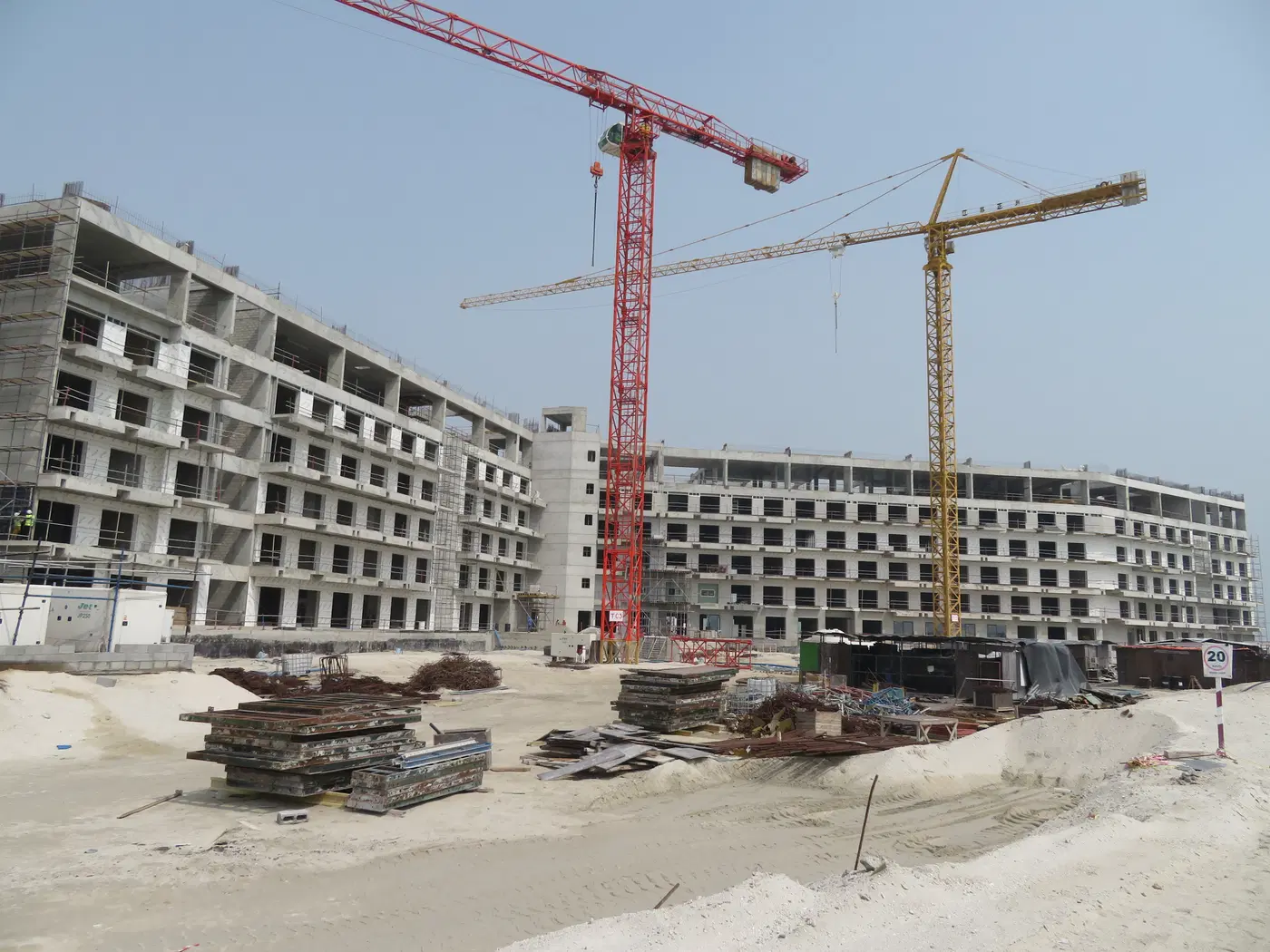

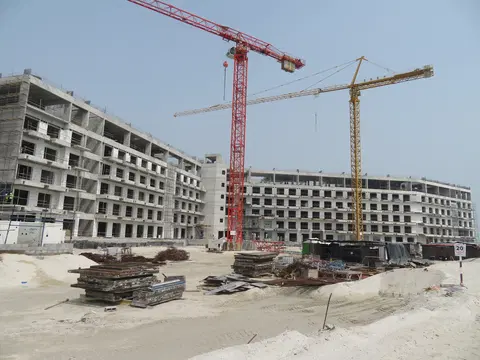

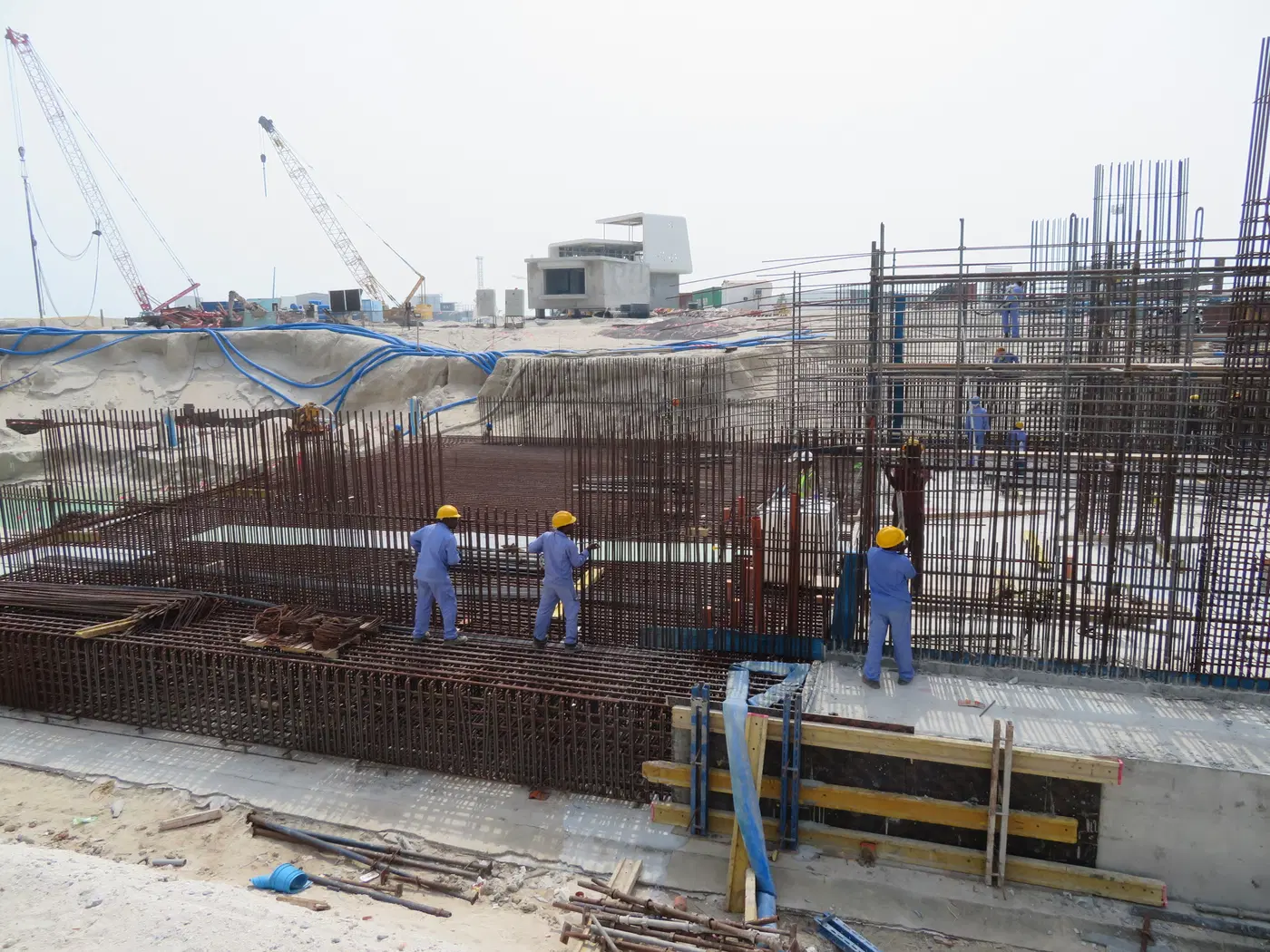

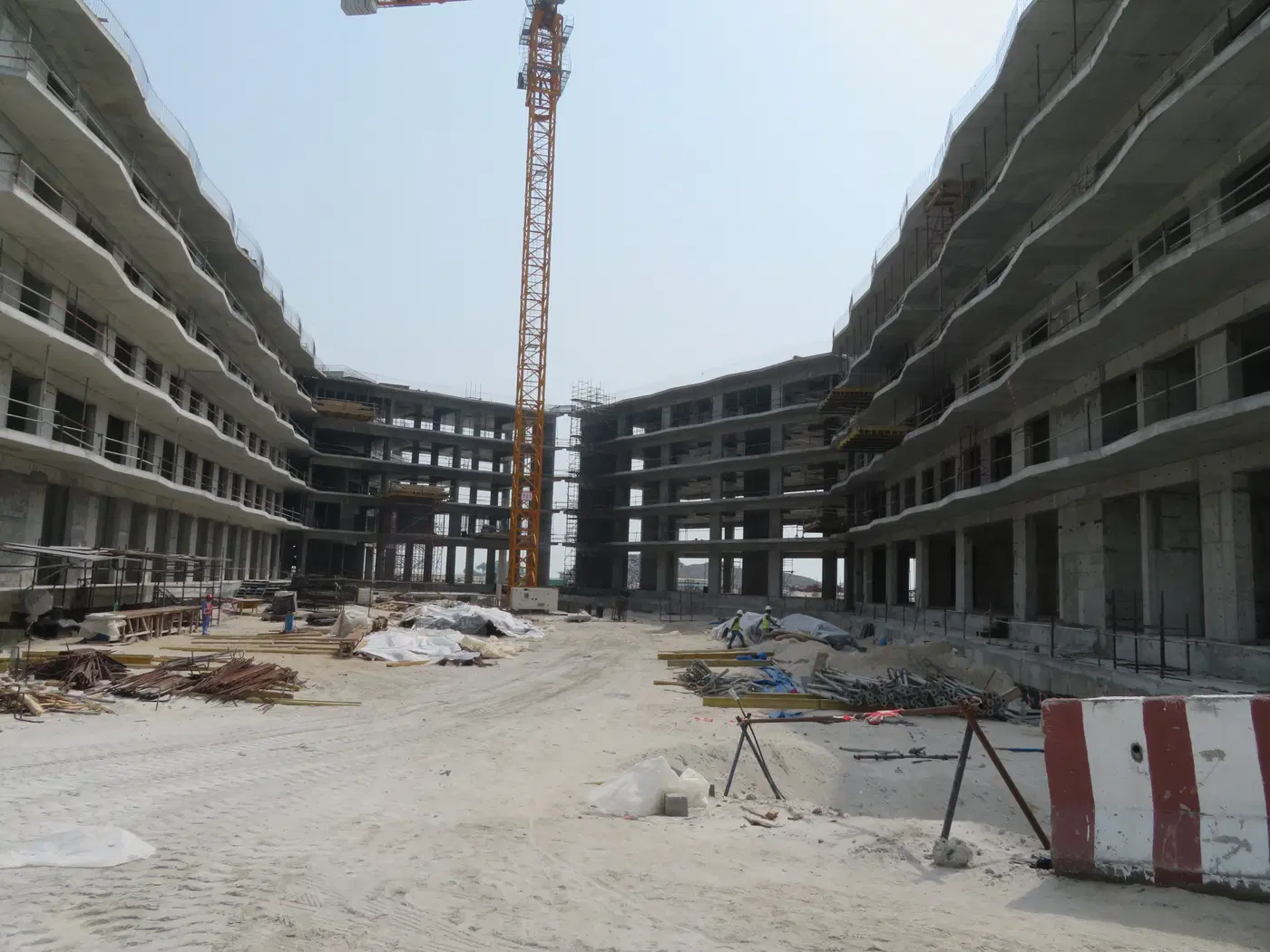

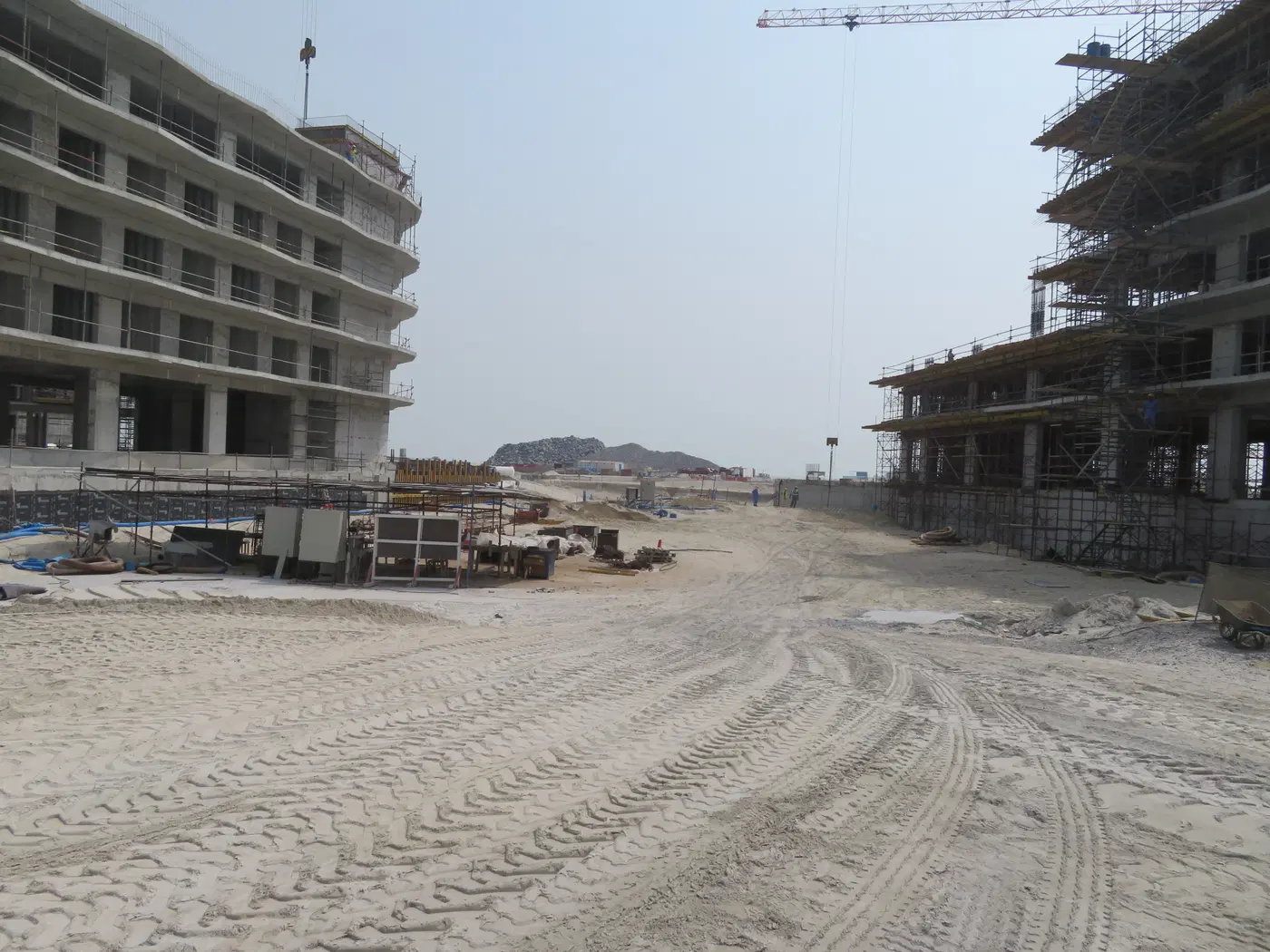

09.03.2020 45.43%

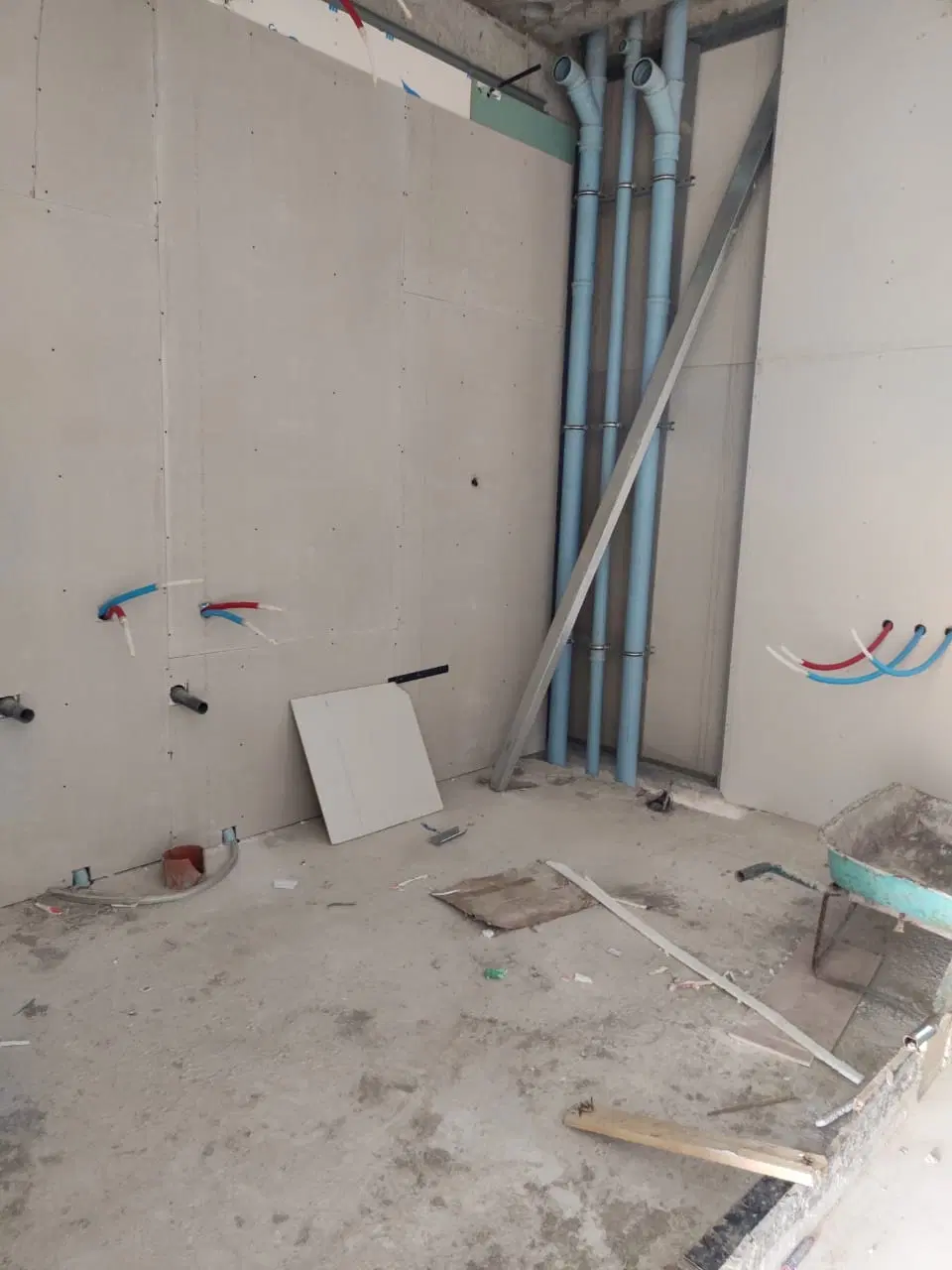

The Heart Of Europe 2, The Heart of Europe construction progress — 9 March 2020, 45.43% complete, photo 1 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 9 March 2020, 45.43% complete, photo 2 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 9 March 2020, 45.43% complete, photo 3 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 9 March 2020, 45.43% complete, photo 4 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 9 March 2020, 45.43% complete, photo 5 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 9 March 2020, 45.43% complete, photo 6 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 9 March 2020, 45.43% complete, photo 7 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 9 March 2020, 45.43% complete, photo 8 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 9 March 2020, 45.43% complete, photo 9 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 9 March 2020, 45.43% complete, photo 10 of 11The Heart Of Europe 2, The Heart of Europe construction progress — 9 March 2020, 45.43% complete, photo 11 of 11

84 more photos in the DLD register

Construction photos are taken by the technical inspectors of the Dubai Land Department (DLD) and remain its property. We show compressed copies; full-resolution originals are available in the Real Estate Project Status service.

Recent transactions

DateTypeSize, m²Price, AED
16.09.2026Studio63.01 000 000
03.08.2026Studio37.72 000 000
26.06.2026Studio37.81 300 000
08.06.2026Studio37.31 080 000
28.04.2026Studio37.7679 000
11.03.2026Studio37.71 993 906
10.03.2026Studio37.71 355 000
19.02.2026Studio37.81 700 000
19.02.2026Studio37.7980 000
18.02.2026Studio37.71 700 000
13.02.2026Studio37.71 700 000
11.02.2026Studio42.42 200 000
23.01.2026Studio46.51 863 112
08.01.2026Studio49.8600 000
18.12.2025Studio54.93 000 000
25.11.2025Studio89.74 600 000
06.10.2025Studio19.4825 286
26.09.2025Studio37.72 155 500
25.09.2025Studio37.81 600 000
18.09.2025Studio37.81 700 000
17.09.2025Studio37.81 400 002
15.09.2025Studio37.7968 000
10.09.2025Studio37.9748 000
10.09.2025Studio37.81 700 000
10.09.2025Studio71.13 660 685
10.09.2025Studio37.71 800 000
27.08.2025Studio37.81 848 497
25.08.2025Studio37.72 000 000
13.08.2025Studio55.41 450 000
08.08.2025Studio37.81 550 000
07.08.2025Studio37.71 650 000
01.08.2025Studio46.41 500 000
01.08.2025Studio38.12 050 652
14.07.2025Studio37.72 088 369
09.07.2025Studio37.71 330 000
09.07.2025Studio37.81 550 000
09.07.2025Studio56.01 800 000
09.07.2025Studio46.41 550 000
09.07.2025Studio37.71 000 000
26.06.2025Studio37.71 800 000
23.06.2025Studio37.71 700 000
23.06.2025Studio37.71 650 000
19.06.2025Studio37.81 650 000
18.06.2025Studio37.71 695 379
12.06.2025Studio71.12 670 247
12.06.2025Studio37.71 700 000
12.06.2025Studio37.62 016 000
10.06.2025Studio40.11 300 000
29.05.2025Studio37.72 144 323
27.05.2025Studio37.61 681 841
Rentals — 1
DateTypeSize, m²Rent, AED/yr
09.05.2023Shop266.0153 274

Dubai Land Department transaction registry, updated 10.10.2026. Explore Dubai property transactions →

Registered transactions in The Heart Of Europe 2

Dubai Land Department records for this building: closed transaction prices, not asking prices or estimates. Figures are medians, so a single expensive sale does not move them.

938deals since 2017
36 210AED per m², median
12%resale, the rest bought from the developer
+3%over the past year

What buyers actually paid

TypeSize, m²Price, AEDPer m²Deals
Studio381 380 00036 316909
1 bedroom964 400 00045 83319

Median across all recorded deals in this building. Rows with fewer than five deals are omitted: there is nothing to average there.

How the price per square metre moved

From 2022 to 2025 — +26% on the price per square metre in this building.

35 4712017——
36 9492018——
35 4712019——
35 4712020——
35 4562021——
35 4712022——
35 4712023——
36 9342024——
44 6942025——
45 0452026*——

Top to bottom: purchase price per m², year, annual rent per m², gross yield.

All figures are medians. Years with fewer than eight deals are skipped; rent is shown where there are at least twenty contracts. The yield is gross — service charges are not published in the register.

* 2026 is still in progress and its bar covers part of the year. The growth figure above uses completed years.

Source: Dubai Land Department transaction register. The register is updated daily; the figures here are recalculated weekly.

How much is your property in The Heart Of Europe 2 worth?

DLD has recorded 938 sales in this building since 2017, 112 of them resales. We compare your unit with sales of the same layout here, not with asking prices. Free, reply within 24 hours.

By submitting the form you agree to the processing of your contact details.
The Heart Of Europe 2

About the project

The Heart Of Europe 2 is a 1,383-unit hotel-apartment development by T H O E Real Estate Development at The Heart of Europe in Dubai’s World Islands. It includes Portofino and Côte d’Azur hotel-apartment components, designed with concrete structures, blockwork and internal and external finishes. The project is active and recorded 93.42% completion on 26 February 2026.

The project

The Heart Of Europe 2 forms part of The Heart of Europe, a themed island cluster within Dubai’s World Islands archipelago. The project has 1,383 units and five buildings. Its stated development programme includes one G+5 Portofino hotel-apartment building and one G+4 Côte d’Azur hotel-apartment building. The construction design is based on concrete structures and blockwork, with internal and external finishes. The Heart of Europe combines residences, hotels, floating villas and leisure-oriented elements across multiple islands, with a concept shaped by references to European destinations and regions.

Portofino and Côte d’Azur hotel apartments

The project’s hotel-apartment elements are identified as Portofino and Côte d’Azur. Portofino is planned as a G+5 hotel-apartment component, while Côte d’Azur is planned as a G+4 hotel-apartment component. These buildings sit within a wider island setting that includes hospitality, residential and leisure uses. The Heart of Europe masterplan has evolved through phases, with different islands allocated to villas, hotels, retail and leisure functions. The Heart Of Europe 2 itself is recorded as a five-building project with 1,383 units.

The Heart of Europe setting

The Heart of Europe is located offshore within The World Islands, Dubai. The wider destination is a cluster of islands developed around architecture, hospitality and experiences inspired by European cities and regions. Its wider programme includes private residences, hotels, floating villas and public leisure elements. The masterplan has referenced attractions including Rainy Street, floating and underwater accommodation, an underwater hotel component with wellness facilities, and an outdoor snow plaza. These elements belong to the wider Heart of Europe destination rather than being stated as facilities within every building of The Heart Of Europe 2.

Access and mainland connections

Access to The Heart of Europe requires a sea transfer or other organised transport from mainland docking points serving The World Islands. The nearest recorded Red Line metro station is R29, at a mapped distance of 10,627 metres from the island location. Recorded mainland distances include 11.5 kilometres to Business Bay, 11.9 kilometres to Burj Khalifa and Downtown Dubai, 12.3 kilometres to DIFC, 12.4 kilometres to The Dubai Mall, and 20.7 kilometres to Dubai International Airport. Palm Jumeirah is recorded at 13.2 kilometres, while Dubai Marina is 16.7 kilometres away.

Construction status and completion date

The Heart Of Europe 2 is recorded as active. Its completion ratio was 93.42% at the inspection dated 26 February 2026. The recorded project start date is 9 December 2015, and the recorded completion date is 30 April 2025. The project has a total of 1,383 units. Within the broader Heart of Europe destination, construction has proceeded in stages across different assets, including hotel buildings, villas and specialised floating accommodation. The active status and 93.42% completion ratio apply specifically to The Heart Of Europe 2.

Developer

T H O E Real Estate Development is the developer of The Heart Of Europe 2. The project is located within The Heart of Europe, where the wider destination has been developed in phases across islands in The World archipelago. The wider programme includes hotel, residential, floating-villa and leisure components. The Heart Of Europe 2 is one of the hotel-apartment developments within this offshore destination, with its Portofino and Côte d’Azur components recorded as part of the project design.

Frequent questions

Who is the developer of The Heart Of Europe 2?
The Heart Of Europe 2 is developed by T H O E Real Estate Development.
Where is The Heart Of Europe 2 located?
The project is located at The Heart of Europe in Dubai’s World Islands. The location is offshore and is accessed by sea transfer or organised transport from mainland docking points.
What does The Heart Of Europe 2 include?
The project includes Portofino and Côte d’Azur hotel-apartment components. It has 1,383 units and five buildings.
What is the construction status of The Heart Of Europe 2?
The project is active. It recorded a completion ratio of 93.42% on 26 February 2026.
When is the recorded completion date for The Heart Of Europe 2?
The recorded completion date is 30 April 2025. The project remained recorded as active with 93.42% completion on 26 February 2026.
What is near The Heart Of Europe 2?
Recorded distances include 11.5 kilometres to Business Bay, 11.9 kilometres to Downtown Dubai, 12.4 kilometres to The Dubai Mall and 20.7 kilometres to Dubai International Airport.
Is The Heart Of Europe 2 close to a metro station?
The nearest recorded Red Line station is R29, with a mapped distance of 10,627 metres from the island location. Access to the islands requires sea transfer or other organised transport.
What is the building design of The Heart Of Europe 2?
The project is designed with concrete structures and blockwork, together with internal and external finishes. Its stated components include a G+5 Portofino hotel-apartment building and a G+4 Côte d’Azur hotel-apartment building.
How can I buy an apartment in The Heart Of Europe 2?
Submit an enquiry via the form on this page or message us on WhatsApp — a Continental Club Property broker (RERA 31933) will help you choose a unit and send the brochure and payment plan.

Nearby projects

Get the presentation and prices

We will send floor plans, the payment plan and available units for this project.

By submitting the form you agree to the processing of your contact details.

Project data comes from the Dubai Land Department (DLD) registry.

For AI agents and researchers

Machine-readable mirrors of this page: Markdown · JSON. They carry the same figures as this page, each with its origin labelled.

How to cite:The Heart Of Europe 2 — Continental Club Property, from Dubai Land Department registry and developer data, 2026-10-01, https://continentalclub.ae/project/the-heart-of-europe-2-the-heart-of-europe/
