Developer: Emaar Properties · Greenway

Greenway

Greenway is a residential project by Emaar Properties in Greenway, Dubai, with construction 39.1% complete per the DLD registry, 232 units, 239 DLD-registered sales since 2024.

Construction39.1%DLD registry · checked 20.07.2026
Units232DLD registry
DLD sales239 since 2024DLD registry
Median sale priceAED 15 807/m²Our calculation

Every figure carries its origin: “DLD registry” is taken from the Dubai Land Department register, “Developer supplied” is stated by the developer, “Our calculation” is computed by us from the first two. Developer prices change without notice — confirm before you commit. Methodology

Units for sale in Greenway

AED 3,600,000 · 3 bedrooms

Payment plan 90/10

The purchase price is split into these stages.

110%Down payment
280%During construction
310%On handover

The exact schedule is confirmed in the sale agreement for the selected unit.

Mortgage for this project

For UAE residents the down payment starts at 20% with terms up to 25 years. Estimate your payment and purchase costs for your budget.

Calculate mortgage

Estimates only; not a bank approval.

Handover date & construction progress

39.06%
  • StatusActive
  • Construction started04.10.2024
  • Status date20.07.2026
  • Progress between DLD inspections+6.81% (17.03.2026 → 20.07.2026)
  • Escrow bankDubai Islamic Bank
  • Scale232 villas
  • DLD project number3032

Data from the Dubai Land Department project registry (updated 09.10.2026 09:55).

Inspection history 8
025507510001.04.202420.07.2026
Actual, per inspections

Pace: 2.43% per month. At this rate 100% falls on 22.08.2028.

The pace is calculated from the past year of inspections. It is an estimate, not a developer commitment. For reference: across 1,175 completed projects the median pace is 2.48% per month and the median build takes 40 months.

Construction progress 41

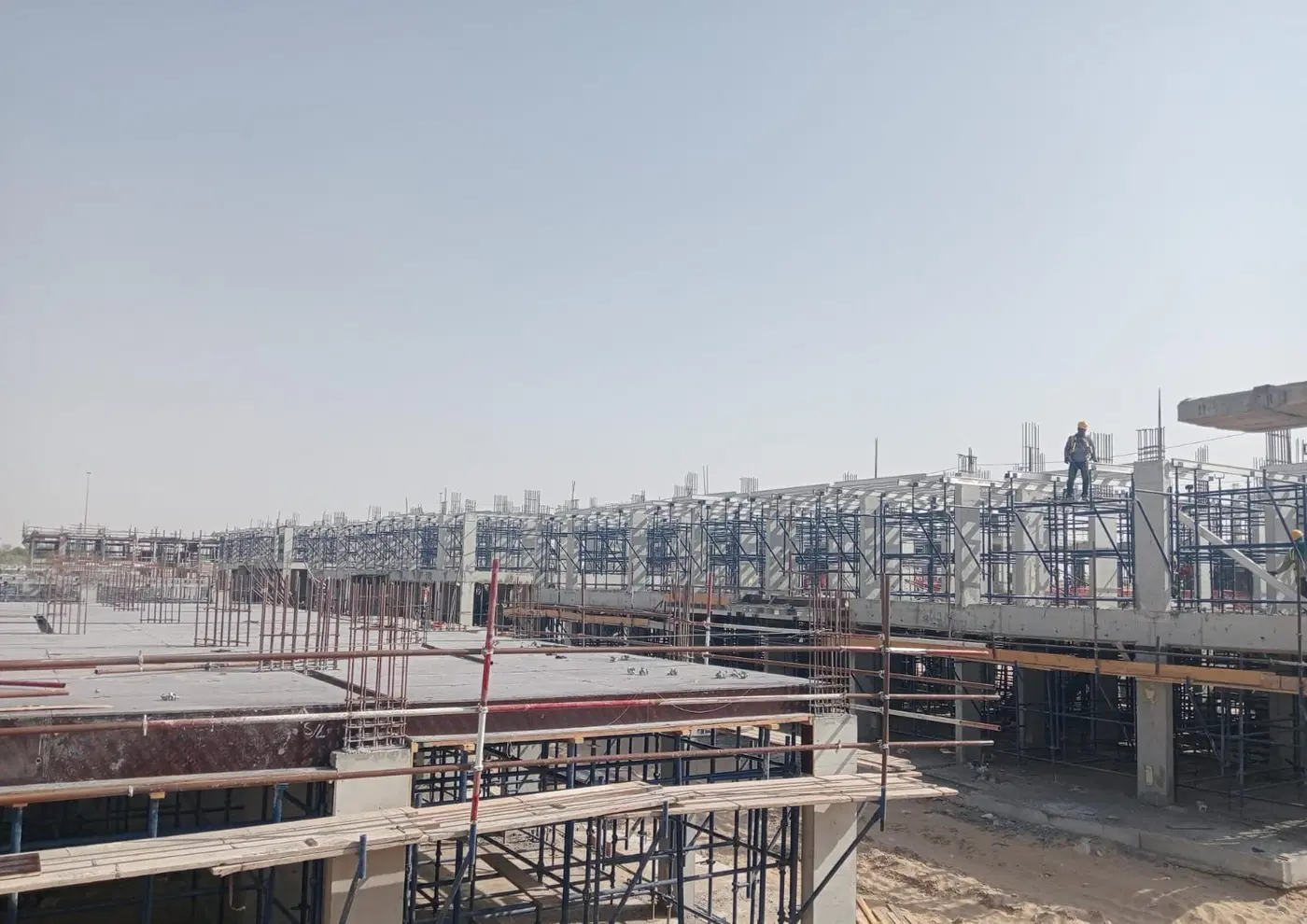

20.07.2026 39.06%

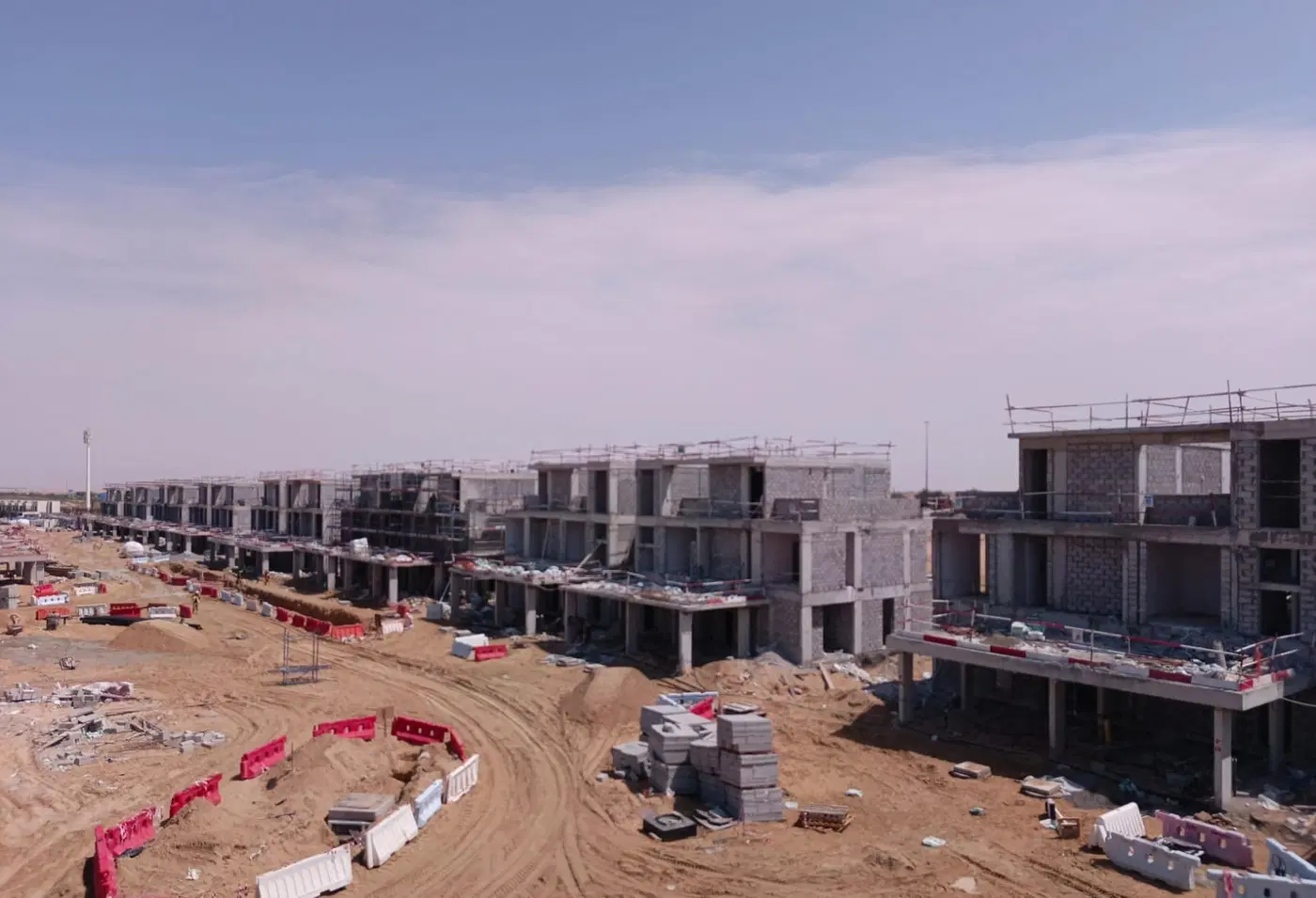

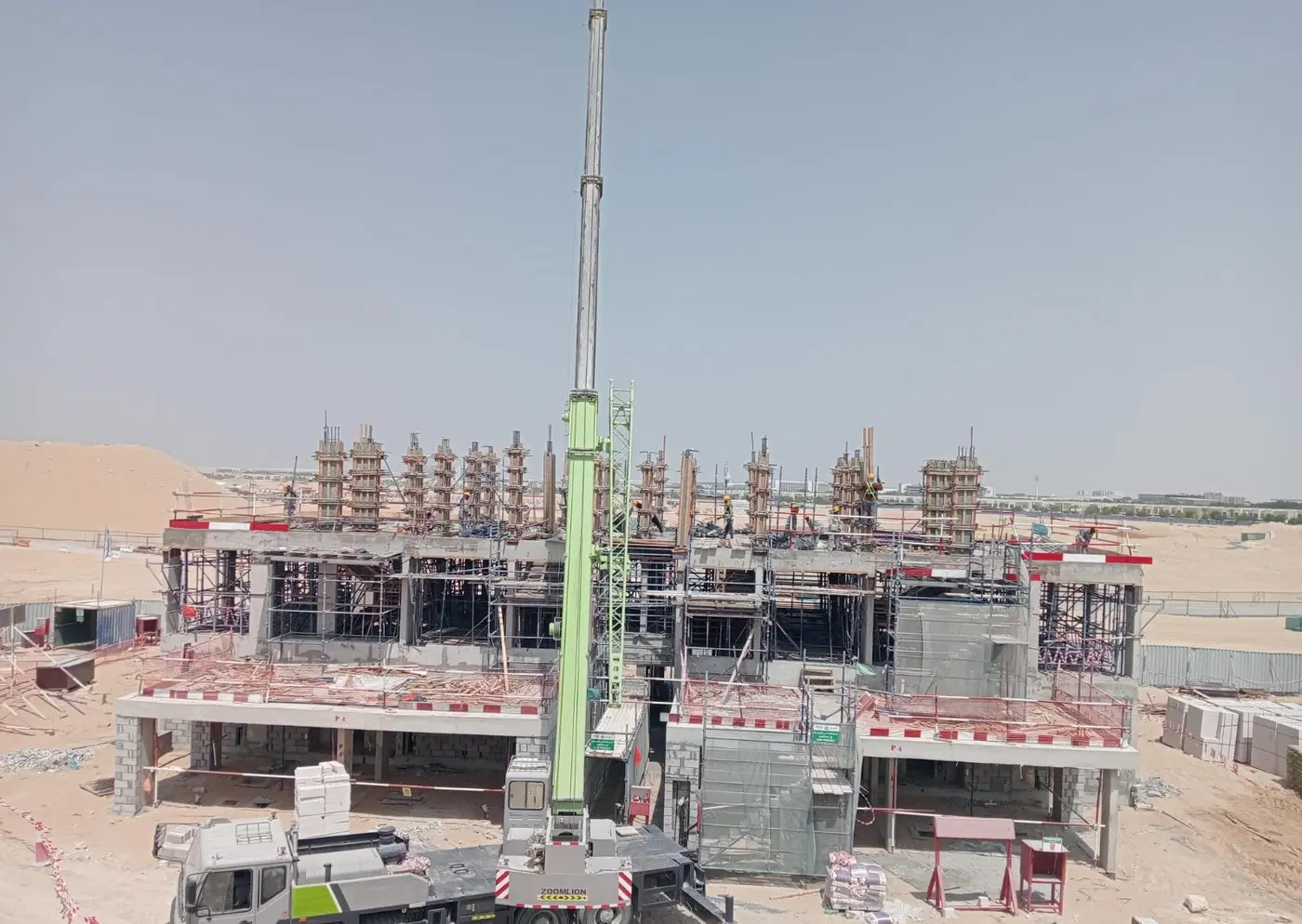

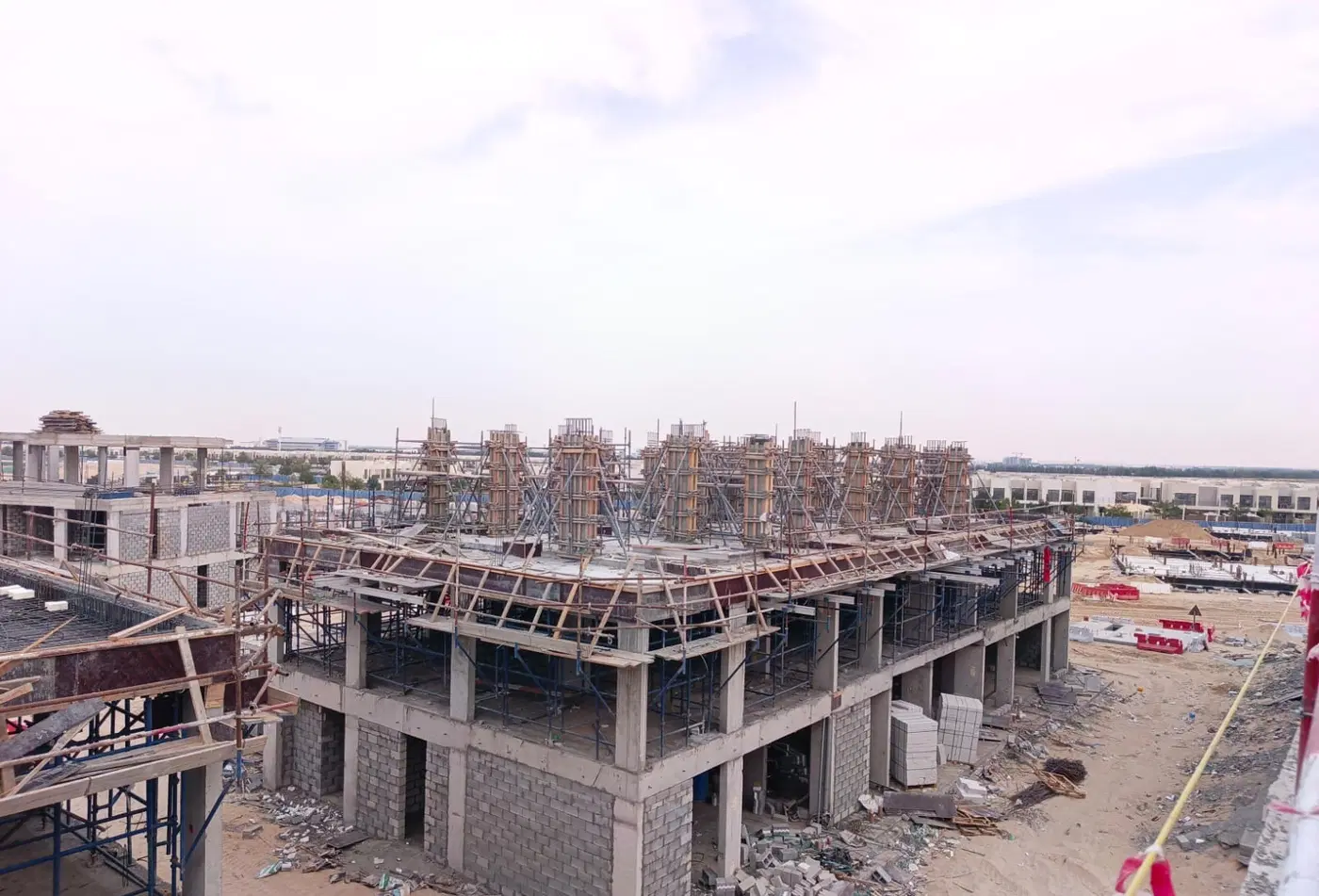

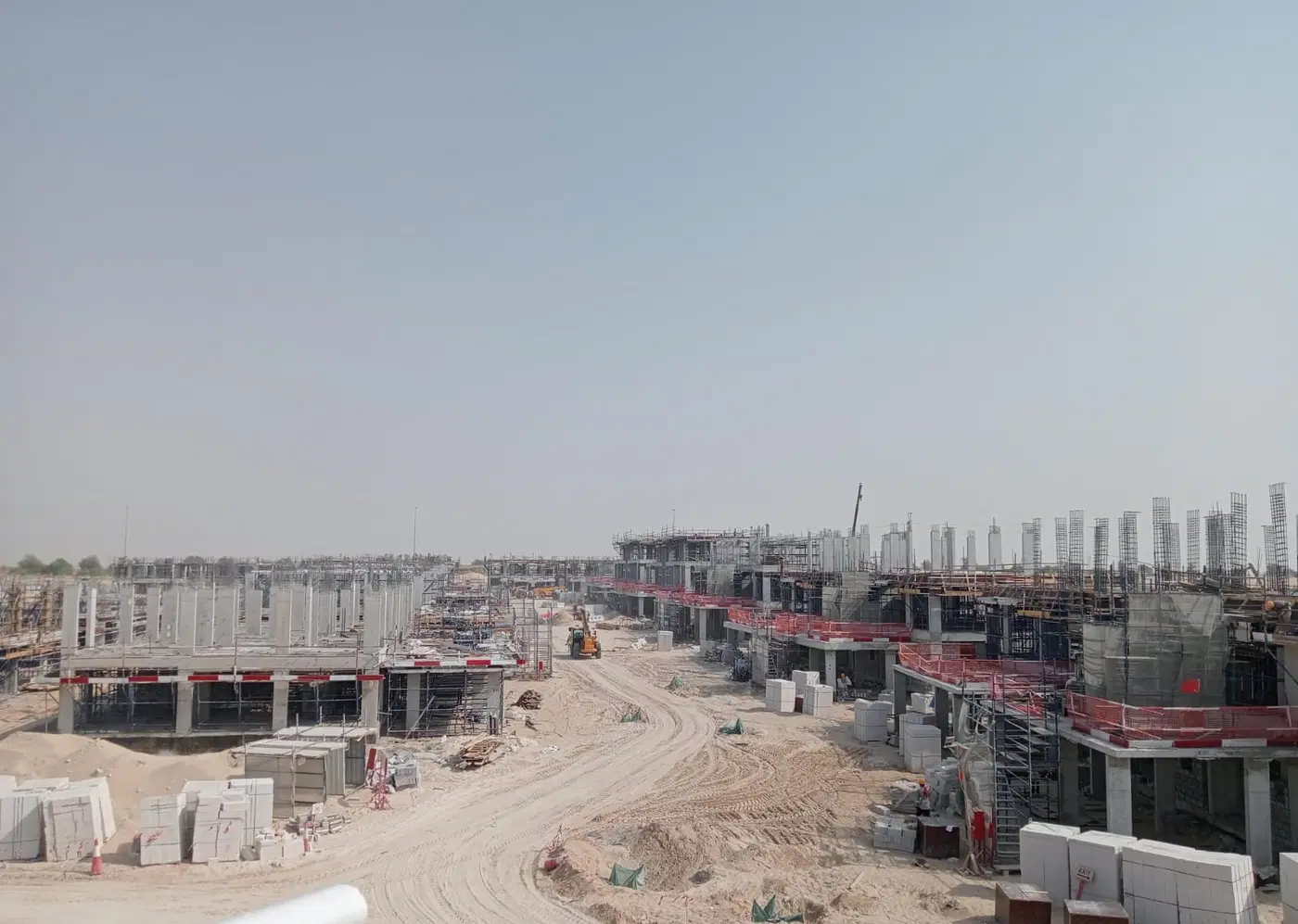

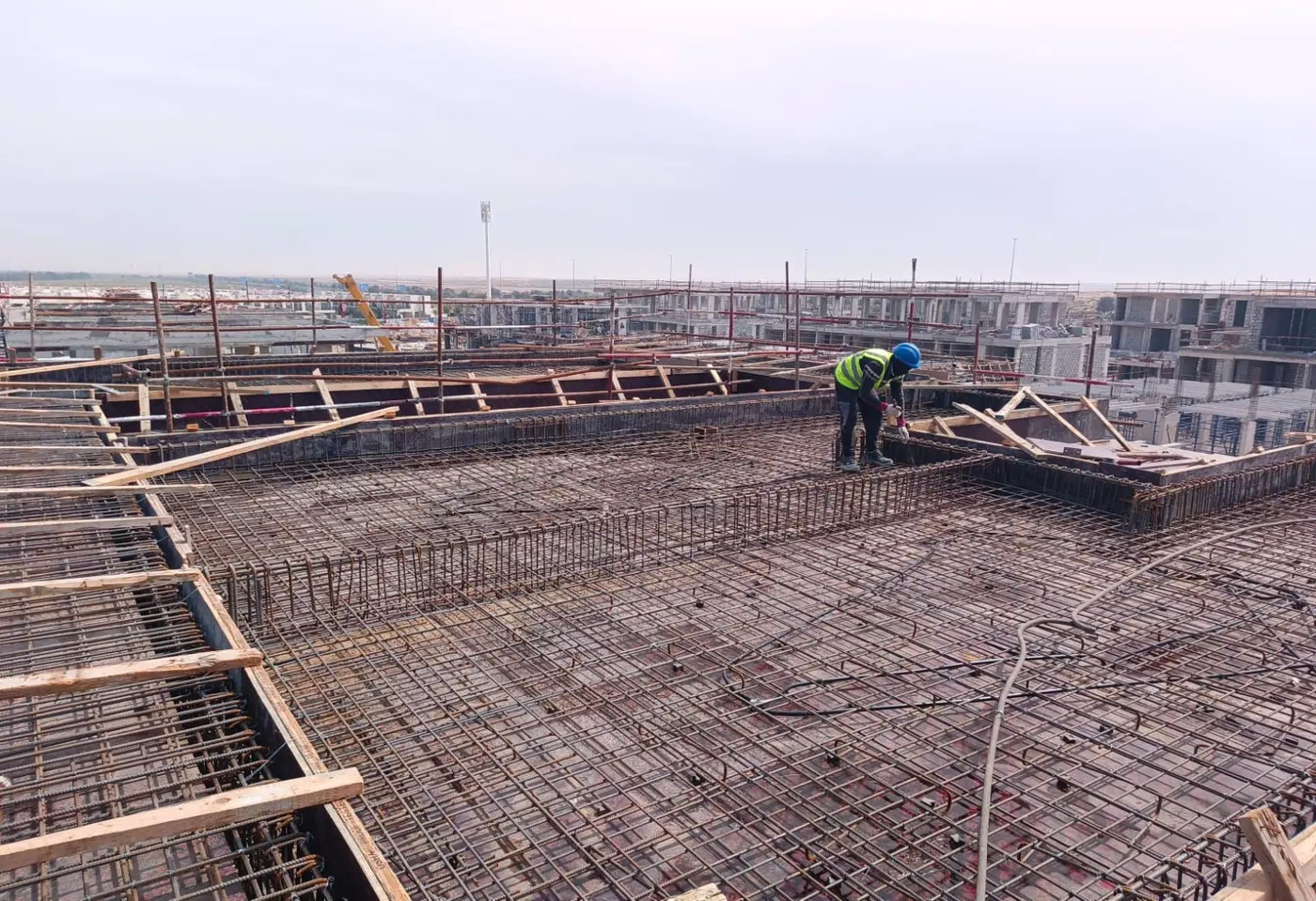

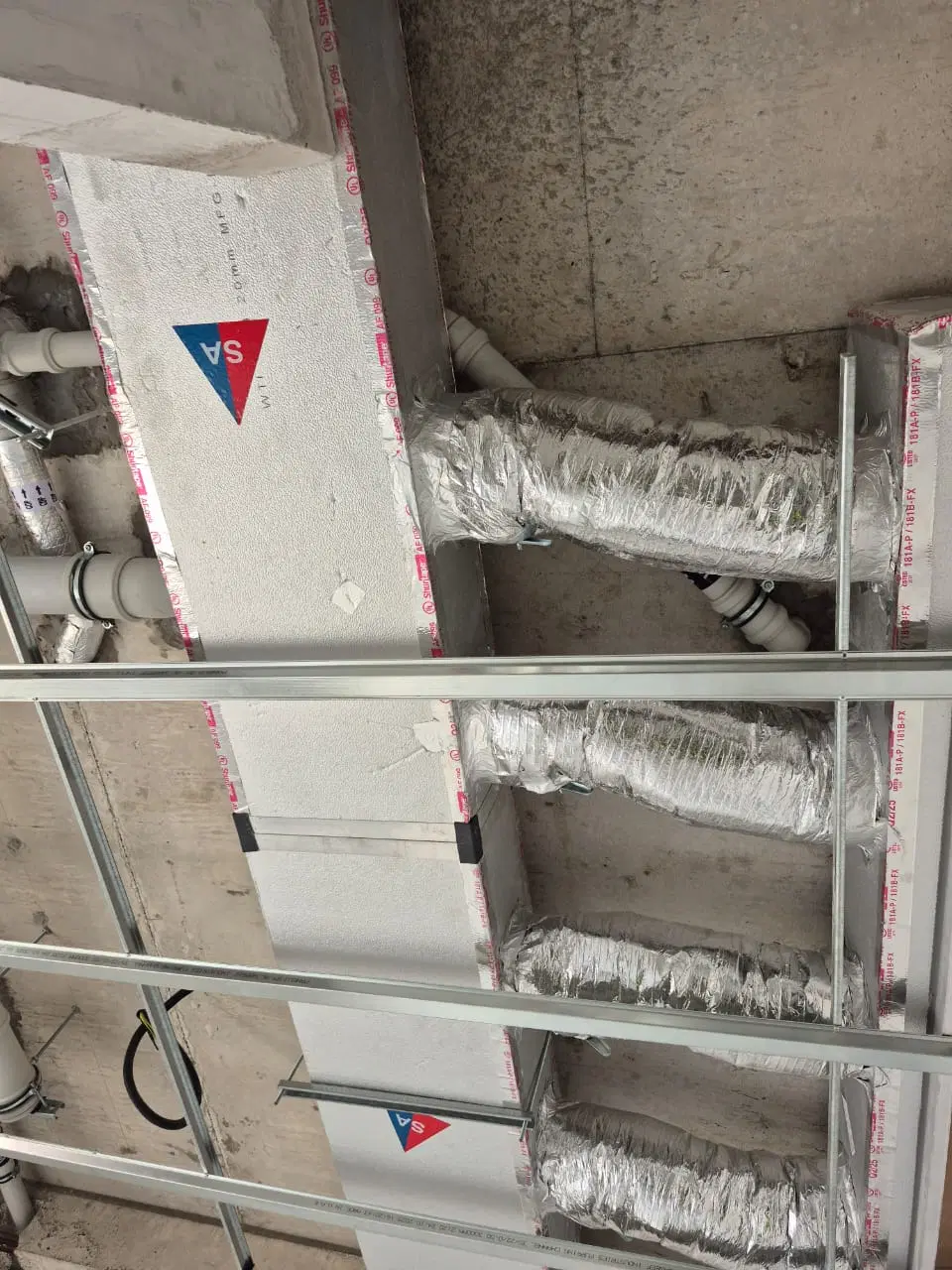

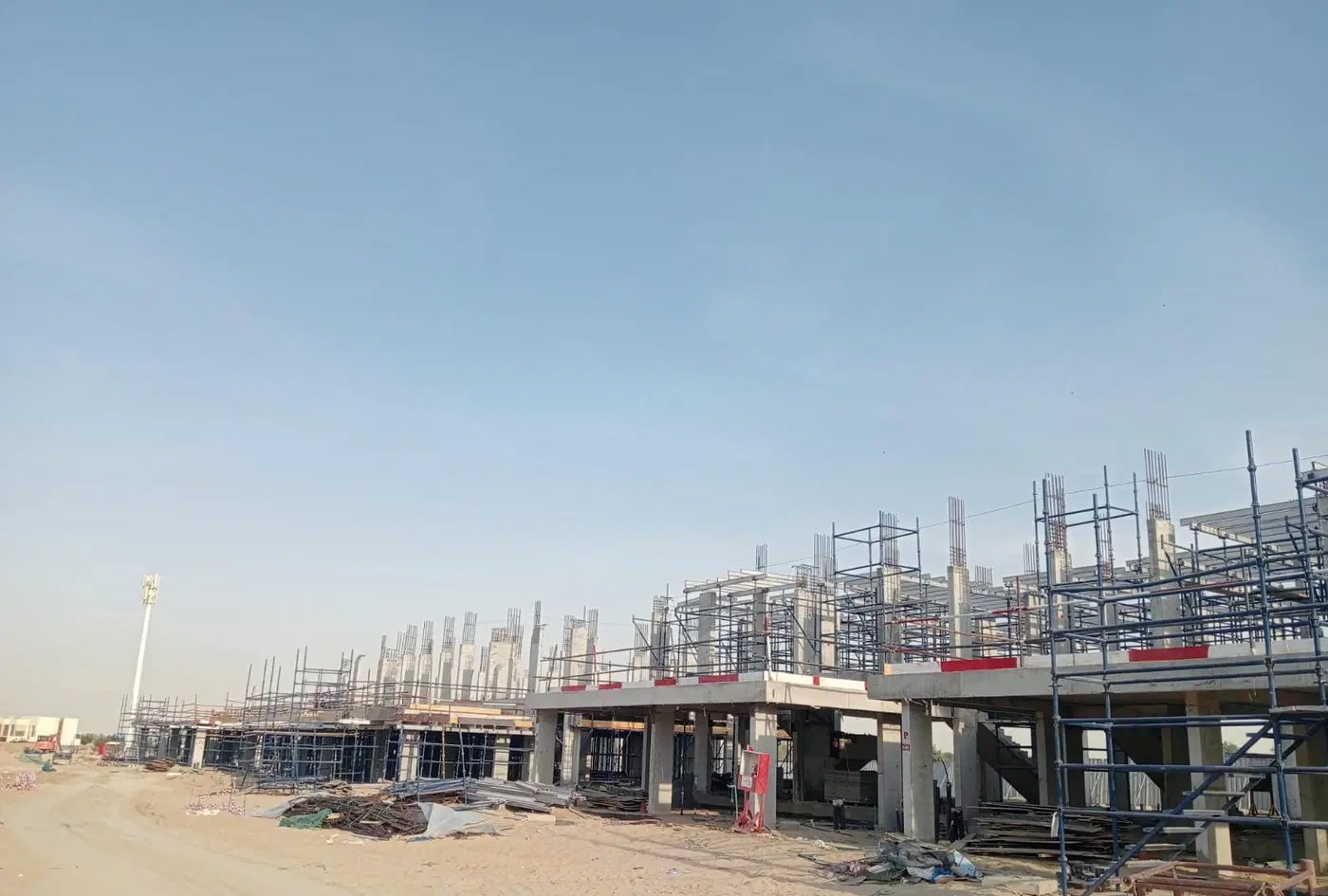

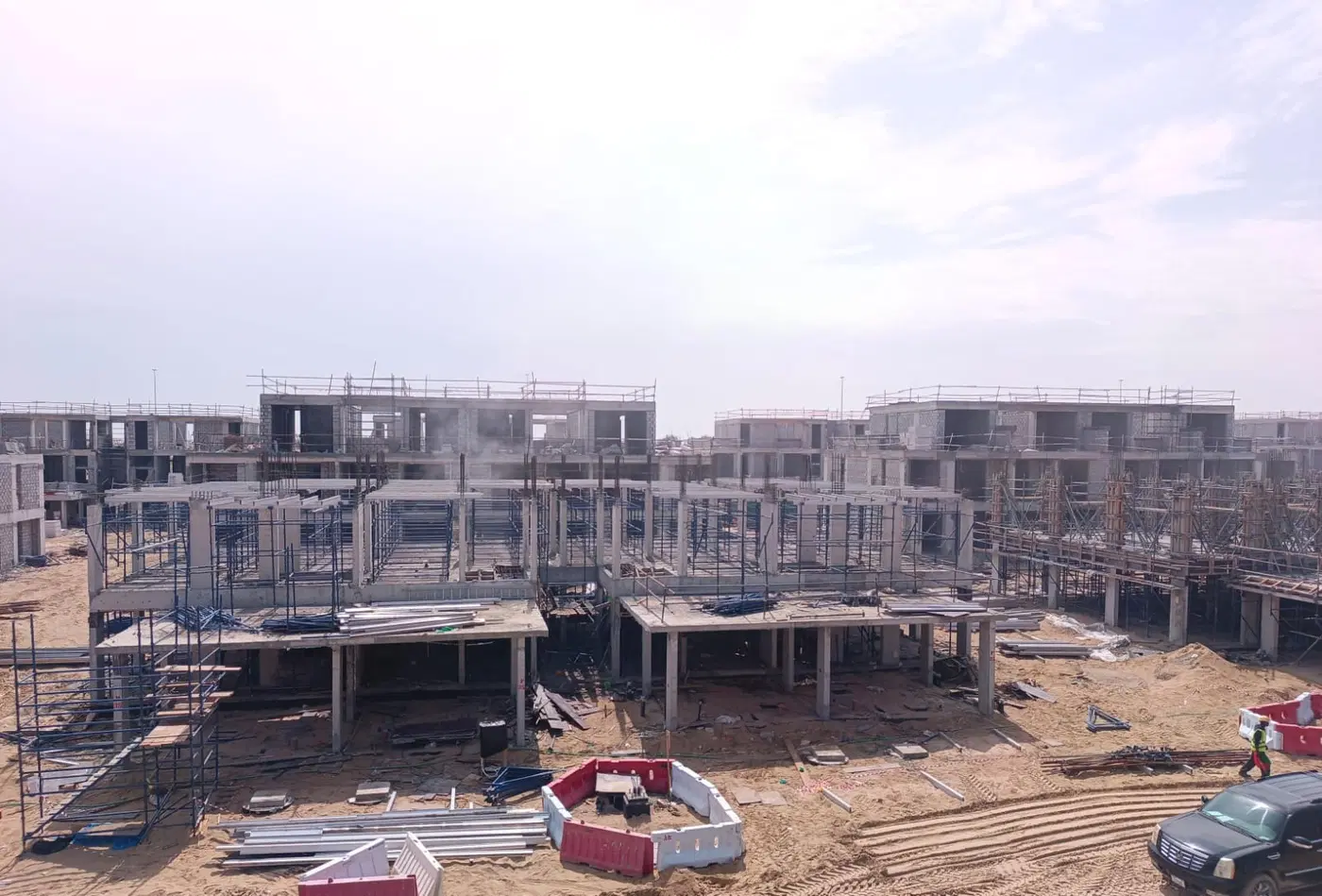

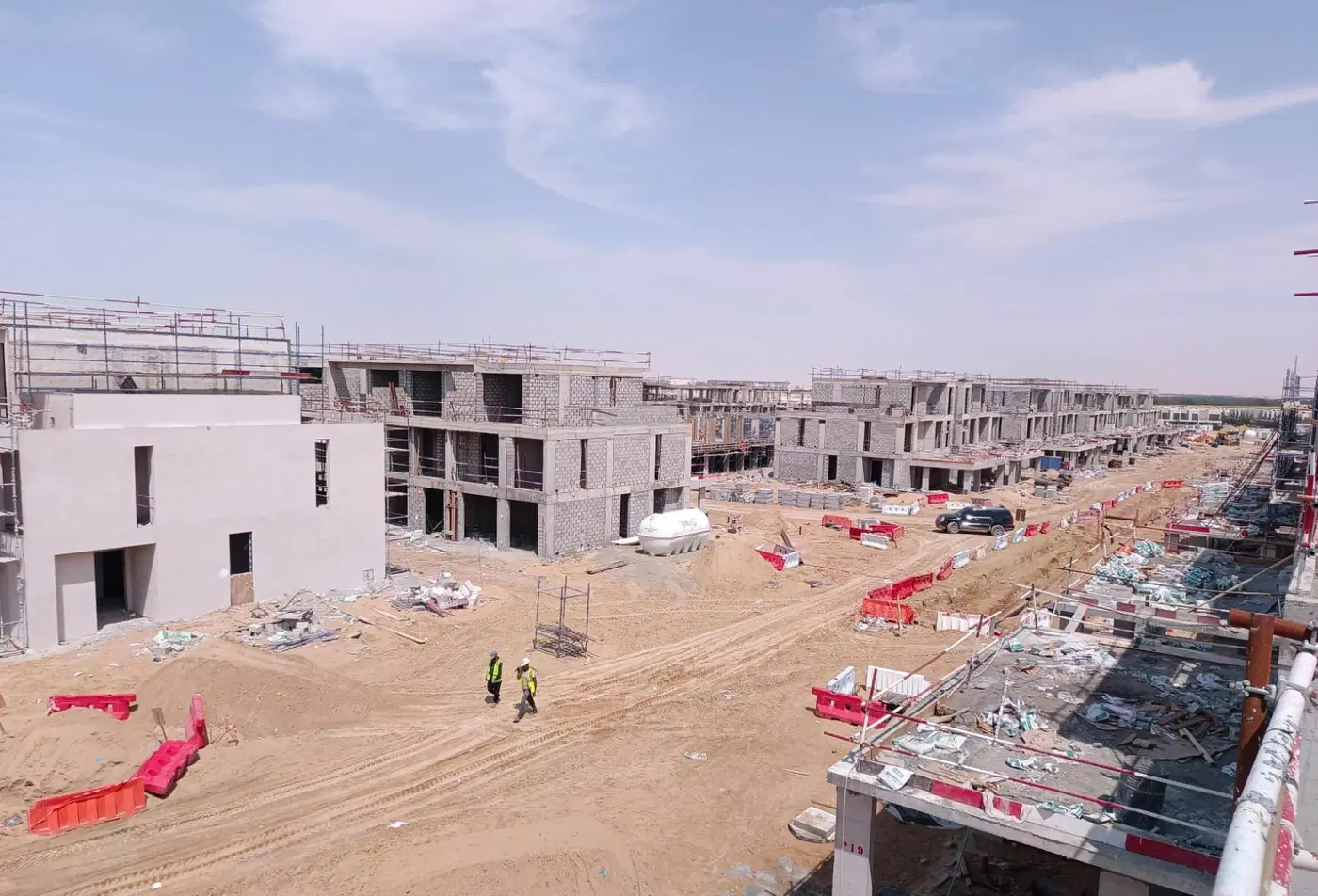

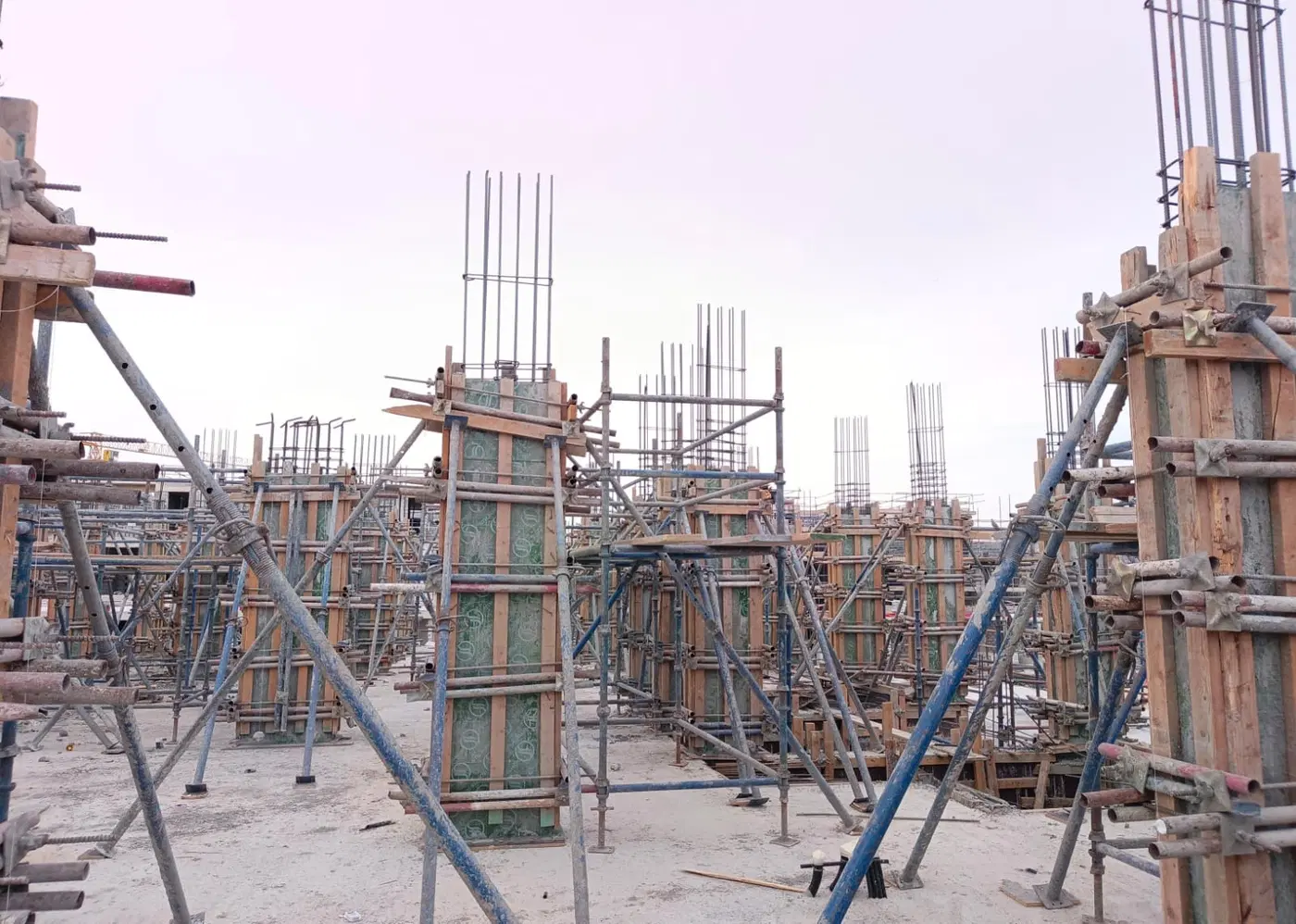

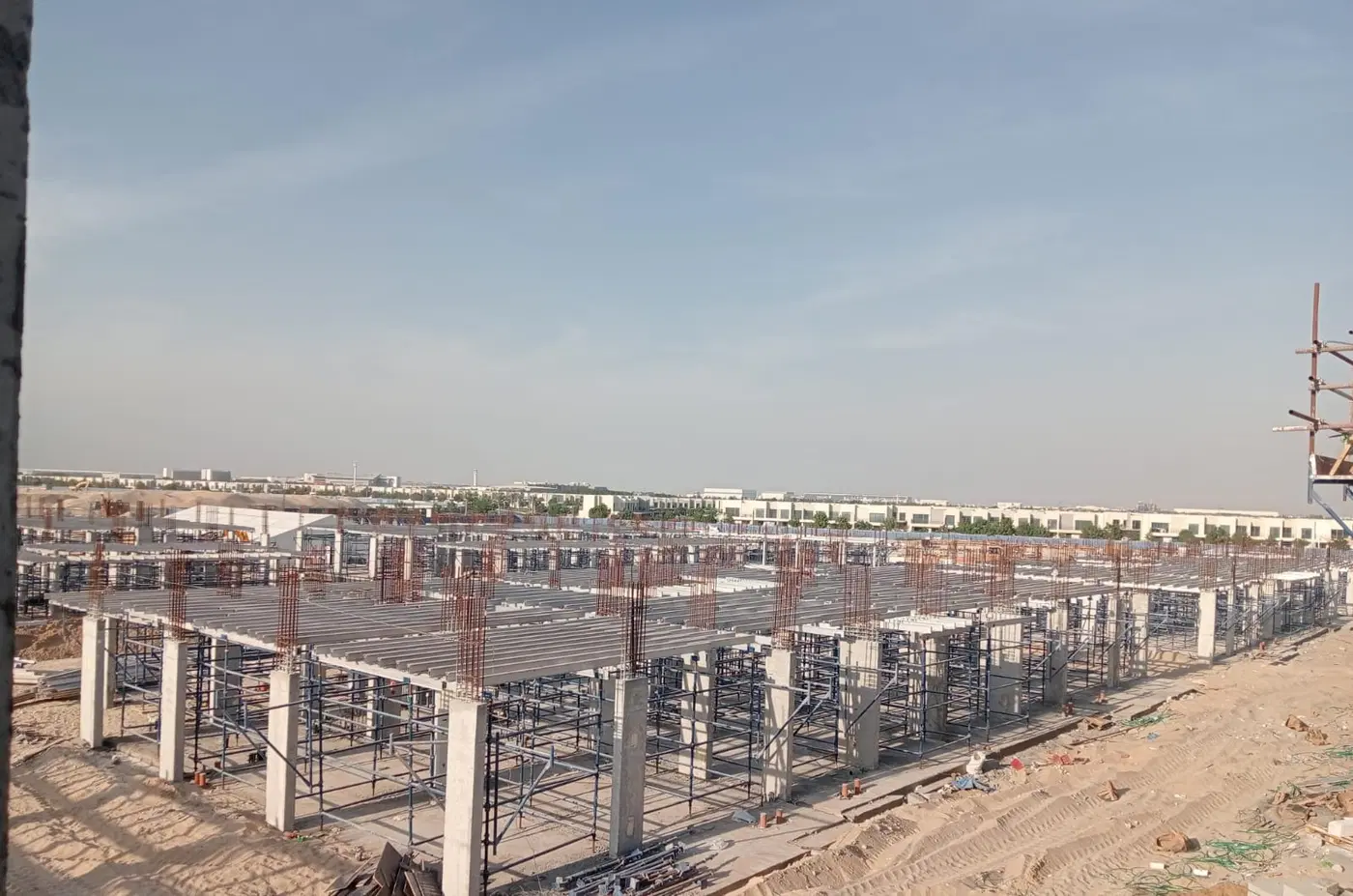

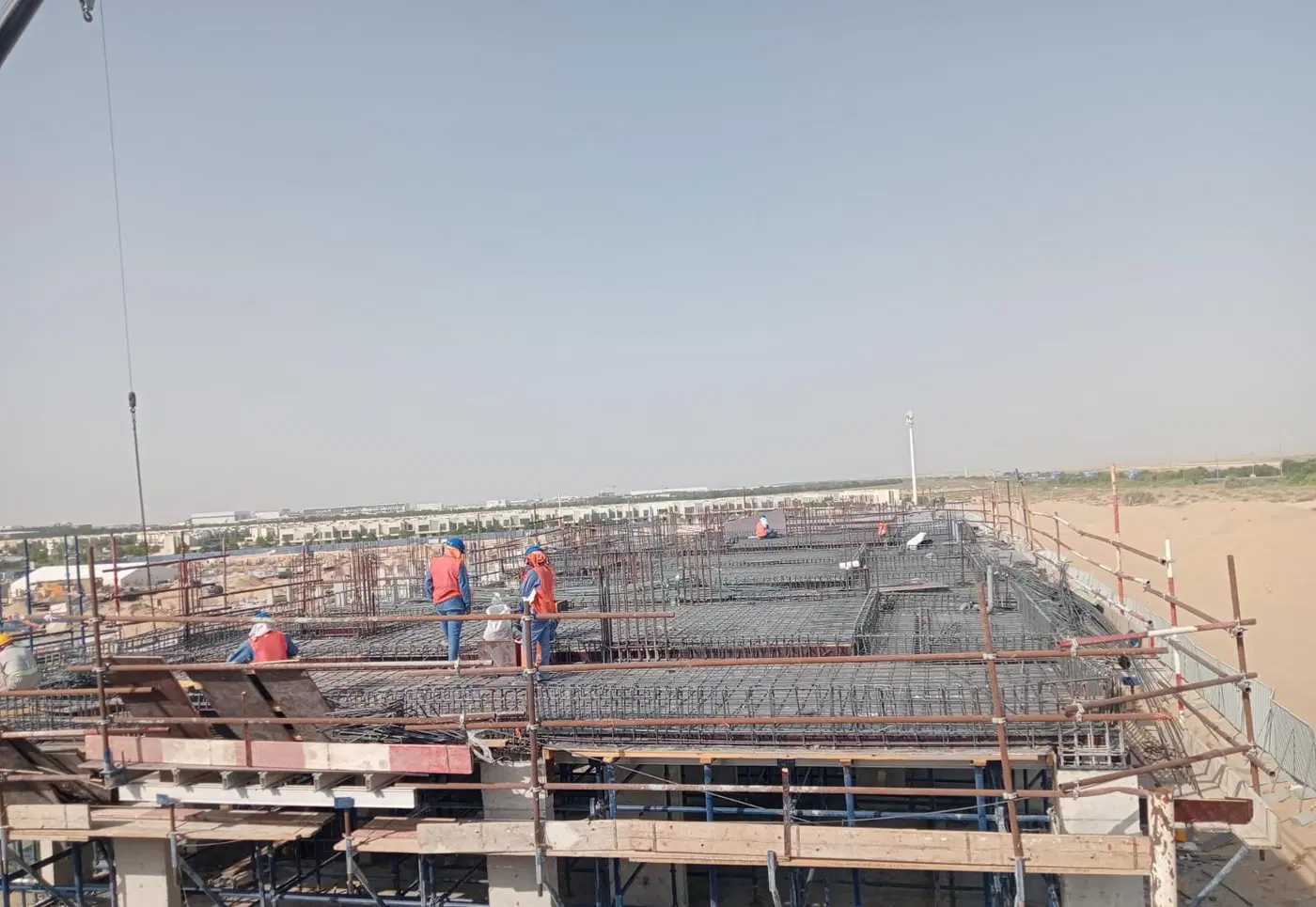

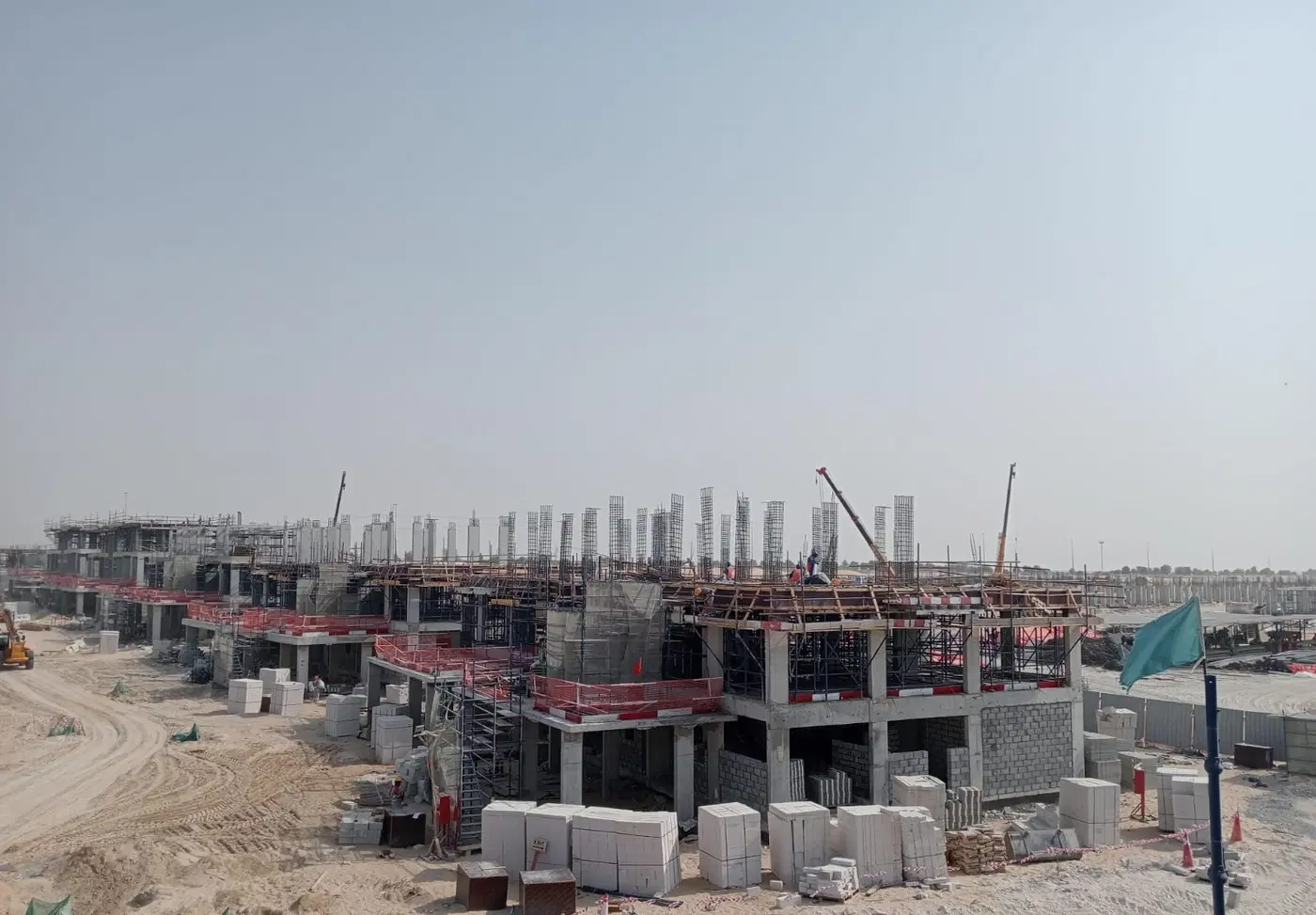

Greenway, Greenway construction progress — 20 July 2026, 39.06% complete, photo 1 of 6Greenway, Greenway construction progress — 20 July 2026, 39.06% complete, photo 2 of 6Greenway, Greenway construction progress — 20 July 2026, 39.06% complete, photo 3 of 6Greenway, Greenway construction progress — 20 July 2026, 39.06% complete, photo 4 of 6Greenway, Greenway construction progress — 20 July 2026, 39.06% complete, photo 5 of 6Greenway, Greenway construction progress — 20 July 2026, 39.06% complete, photo 6 of 6

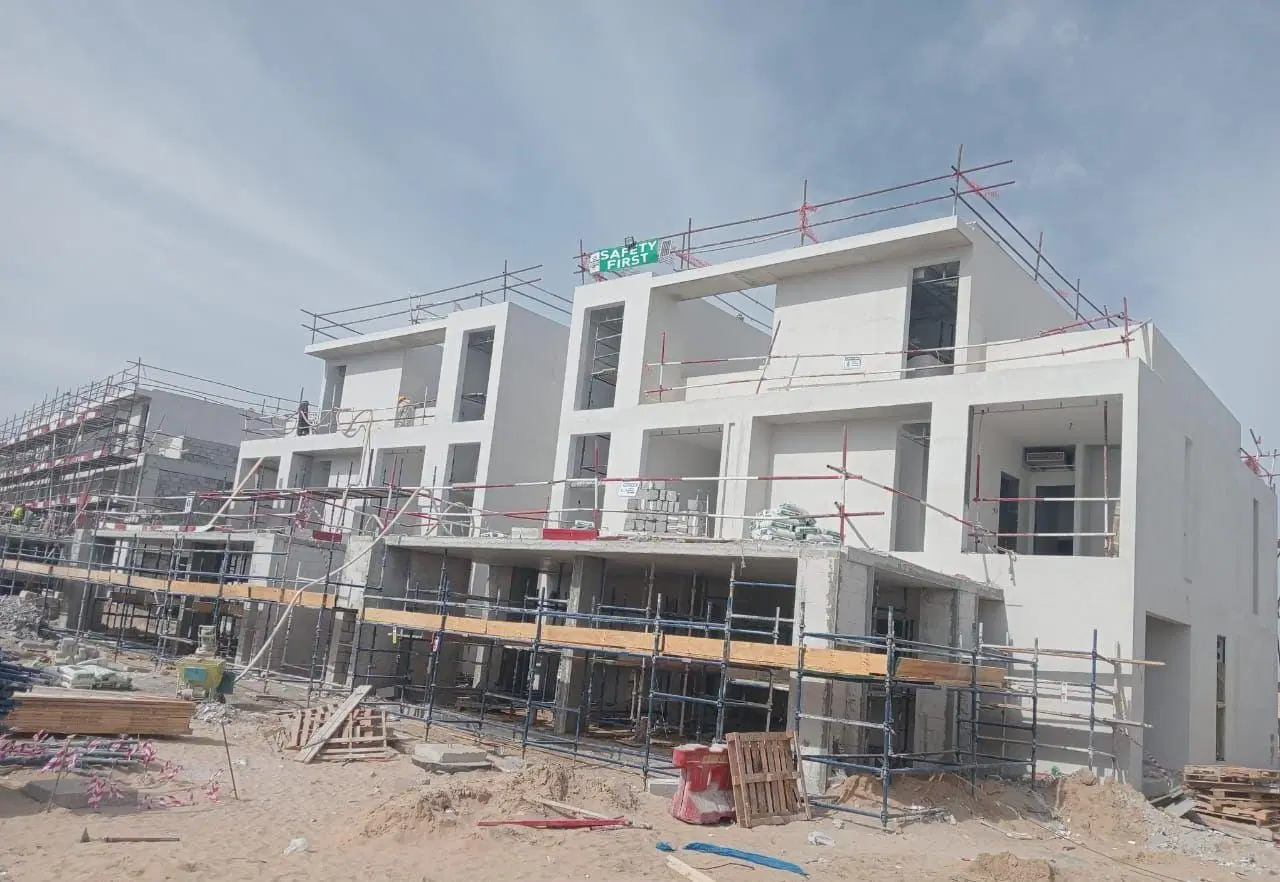

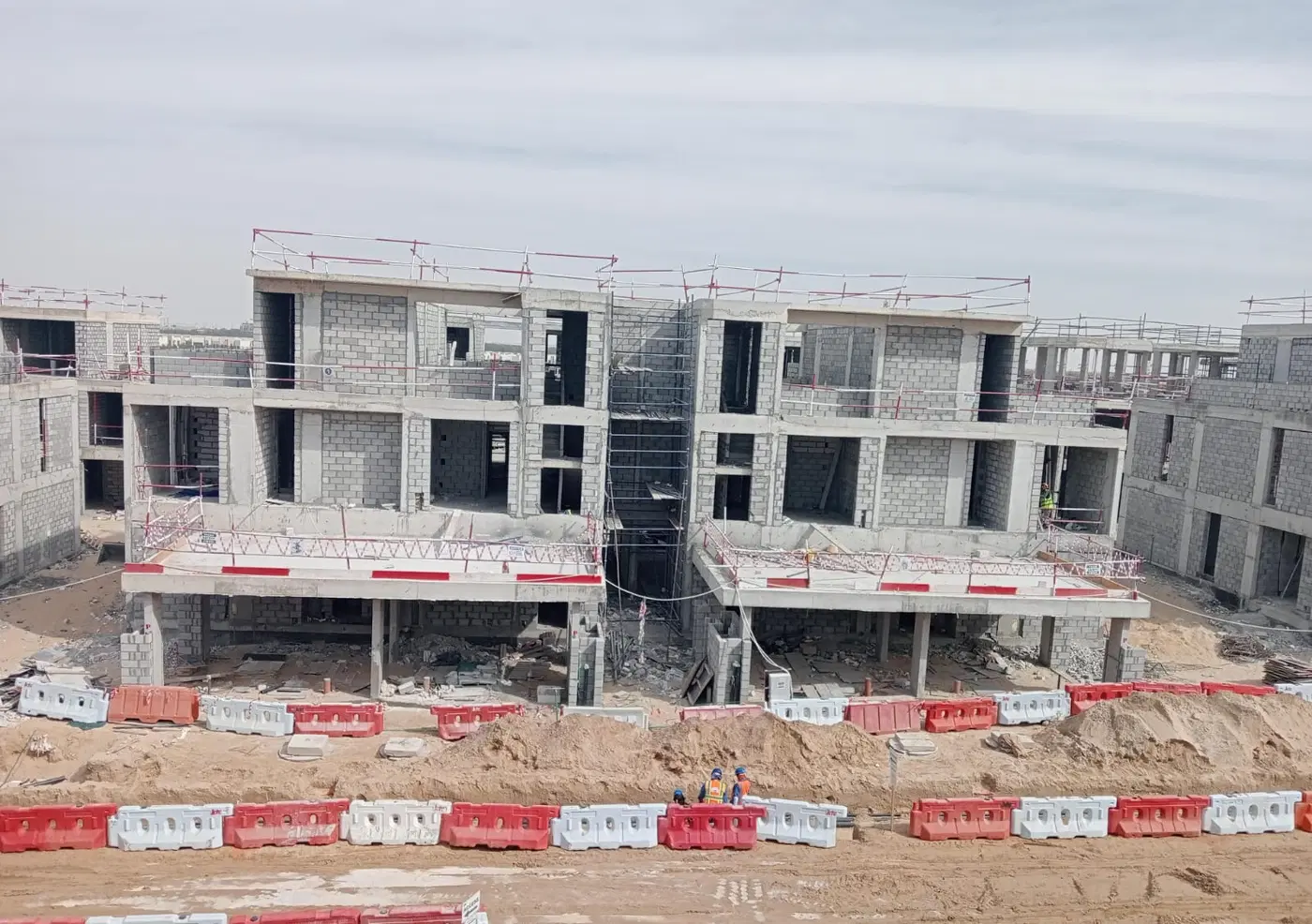

17.03.2026 32.25%
Greenway, Greenway construction progress — 17 March 2026, 32.25% complete, photo 1 of 6Greenway, Greenway construction progress — 17 March 2026, 32.25% complete, photo 2 of 6Greenway, Greenway construction progress — 17 March 2026, 32.25% complete, photo 3 of 6Greenway, Greenway construction progress — 17 March 2026, 32.25% complete, photo 4 of 6Greenway, Greenway construction progress — 17 March 2026, 32.25% complete, photo 5 of 6Greenway, Greenway construction progress — 17 March 2026, 32.25% complete, photo 6 of 6

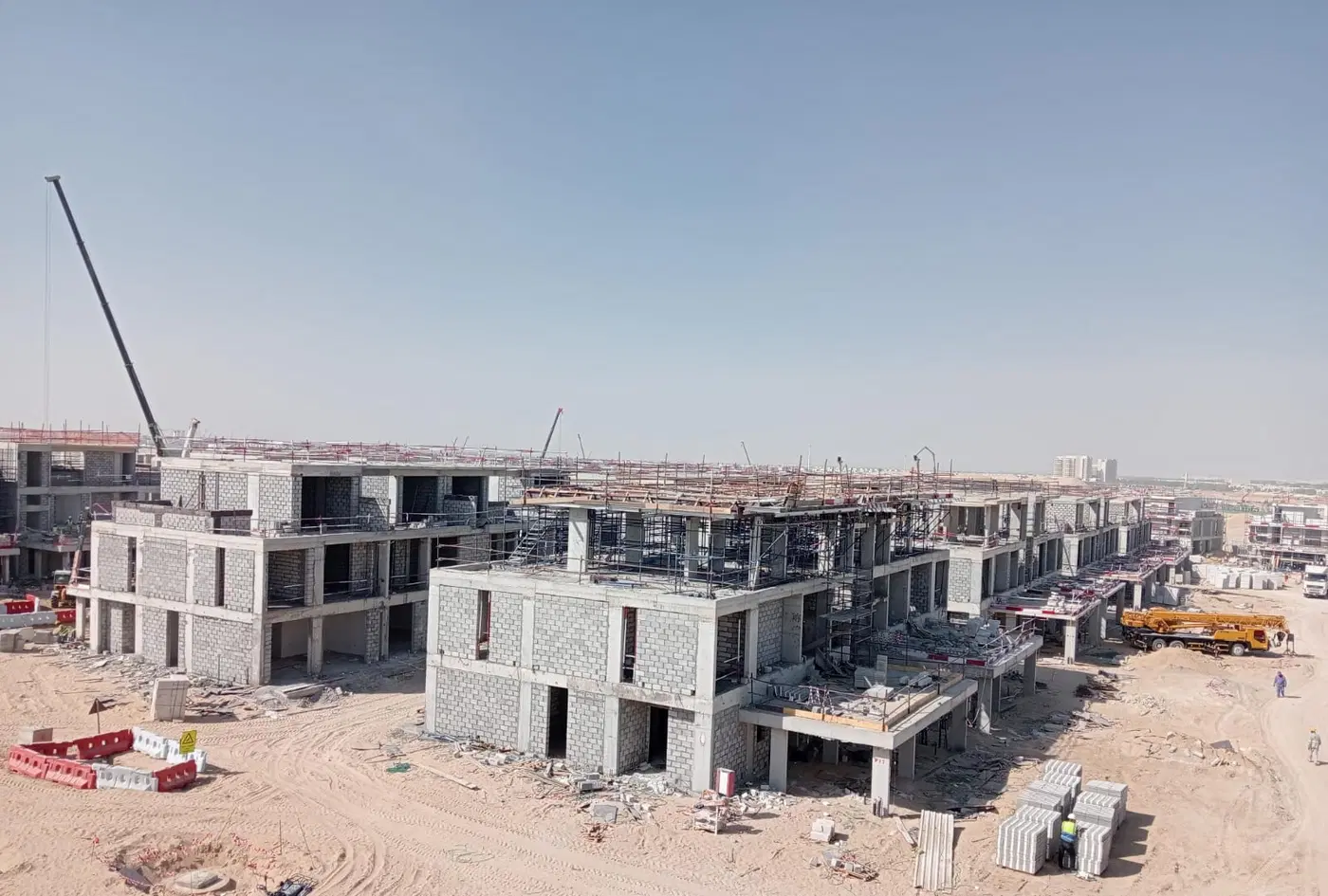

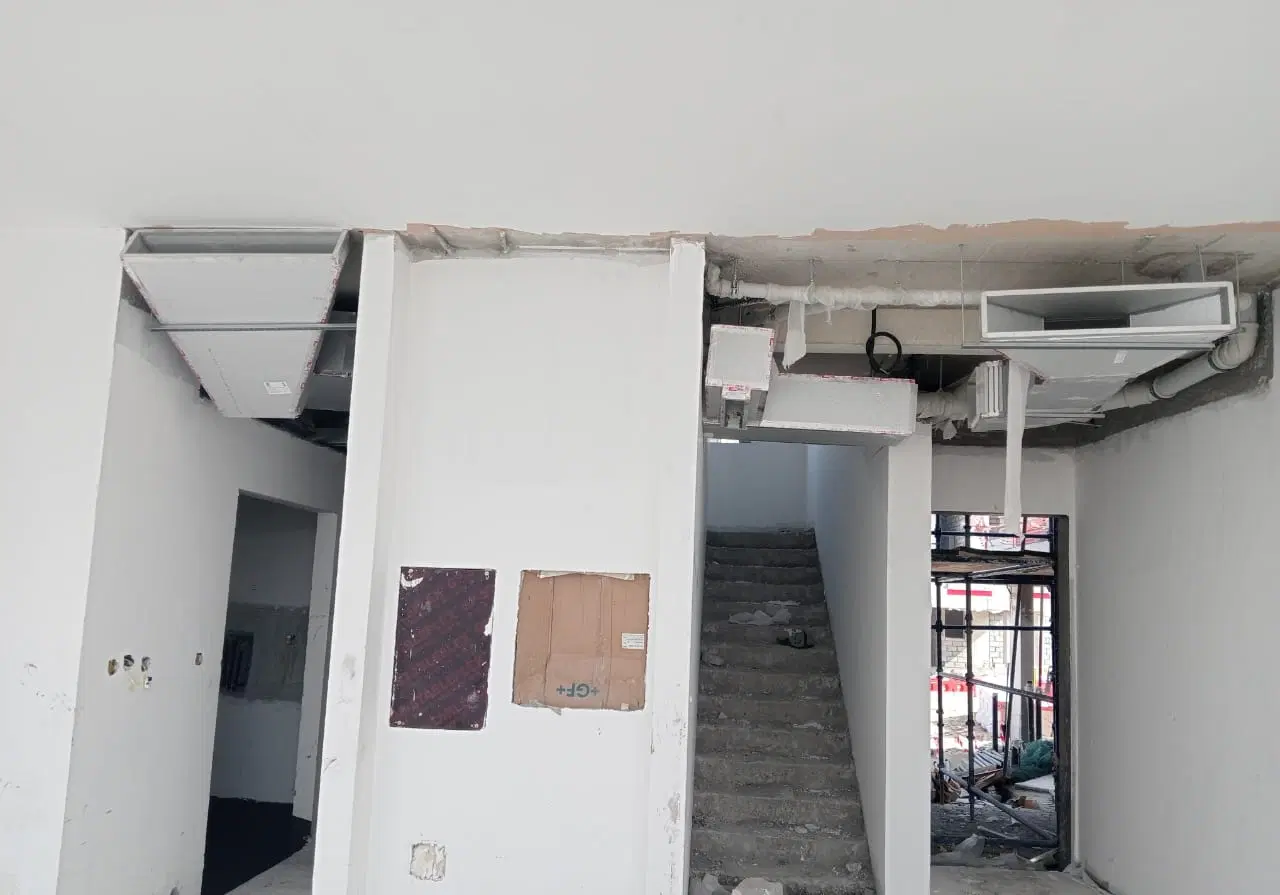

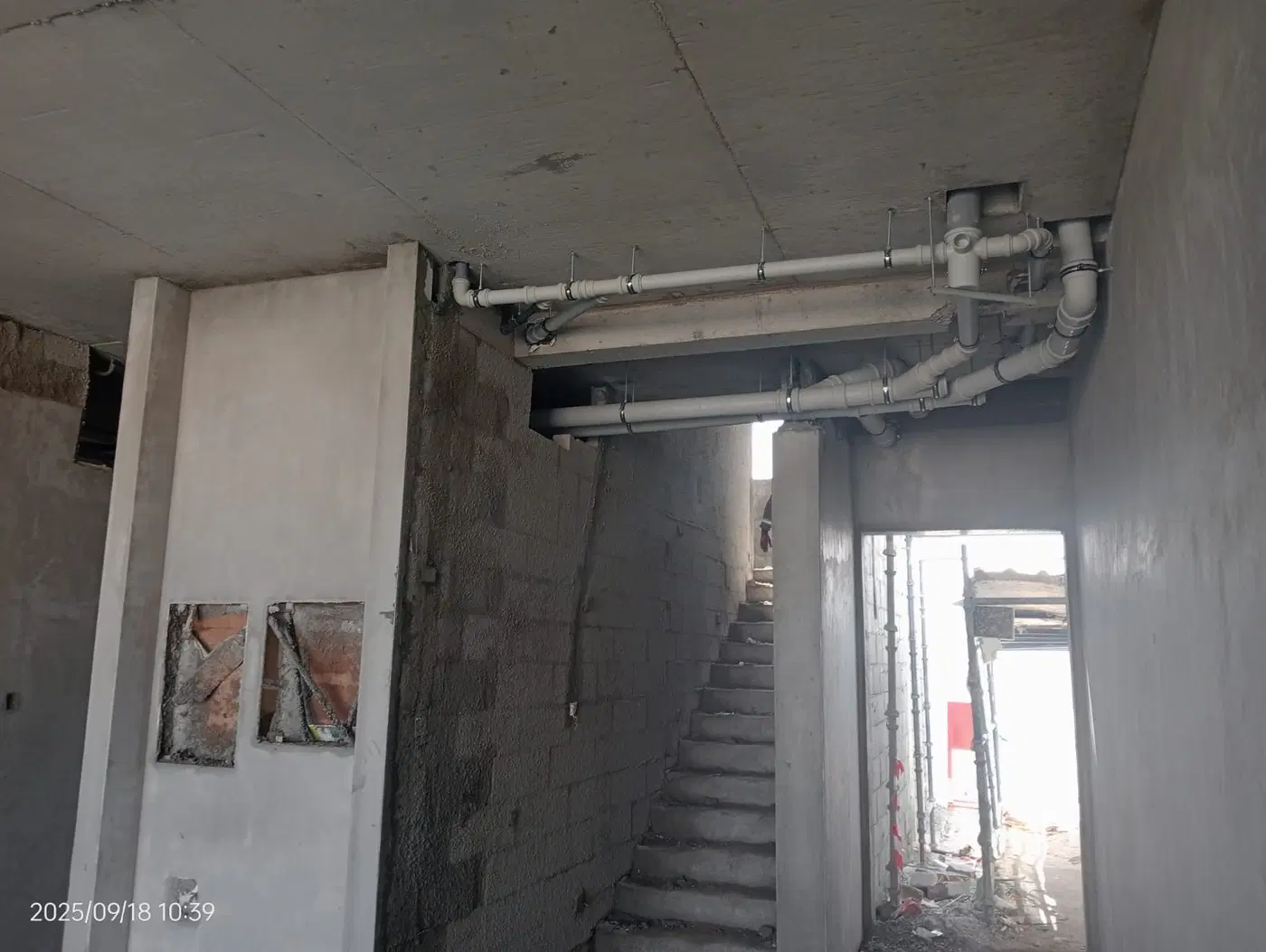

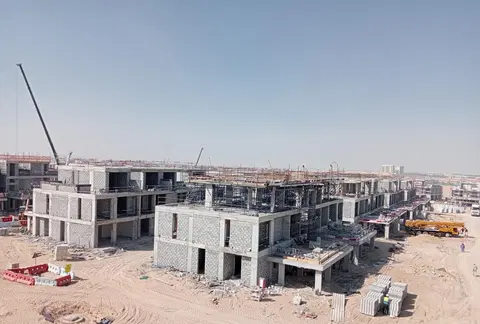

12.12.2025 23.20%
Greenway, Greenway construction progress — 12 December 2025, 23.20% complete, photo 1 of 7Greenway, Greenway construction progress — 12 December 2025, 23.20% complete, photo 2 of 7Greenway, Greenway construction progress — 12 December 2025, 23.20% complete, photo 3 of 7Greenway, Greenway construction progress — 12 December 2025, 23.20% complete, photo 4 of 7Greenway, Greenway construction progress — 12 December 2025, 23.20% complete, photo 5 of 7Greenway, Greenway construction progress — 12 December 2025, 23.20% complete, photo 6 of 7Greenway, Greenway construction progress — 12 December 2025, 23.20% complete, photo 7 of 7

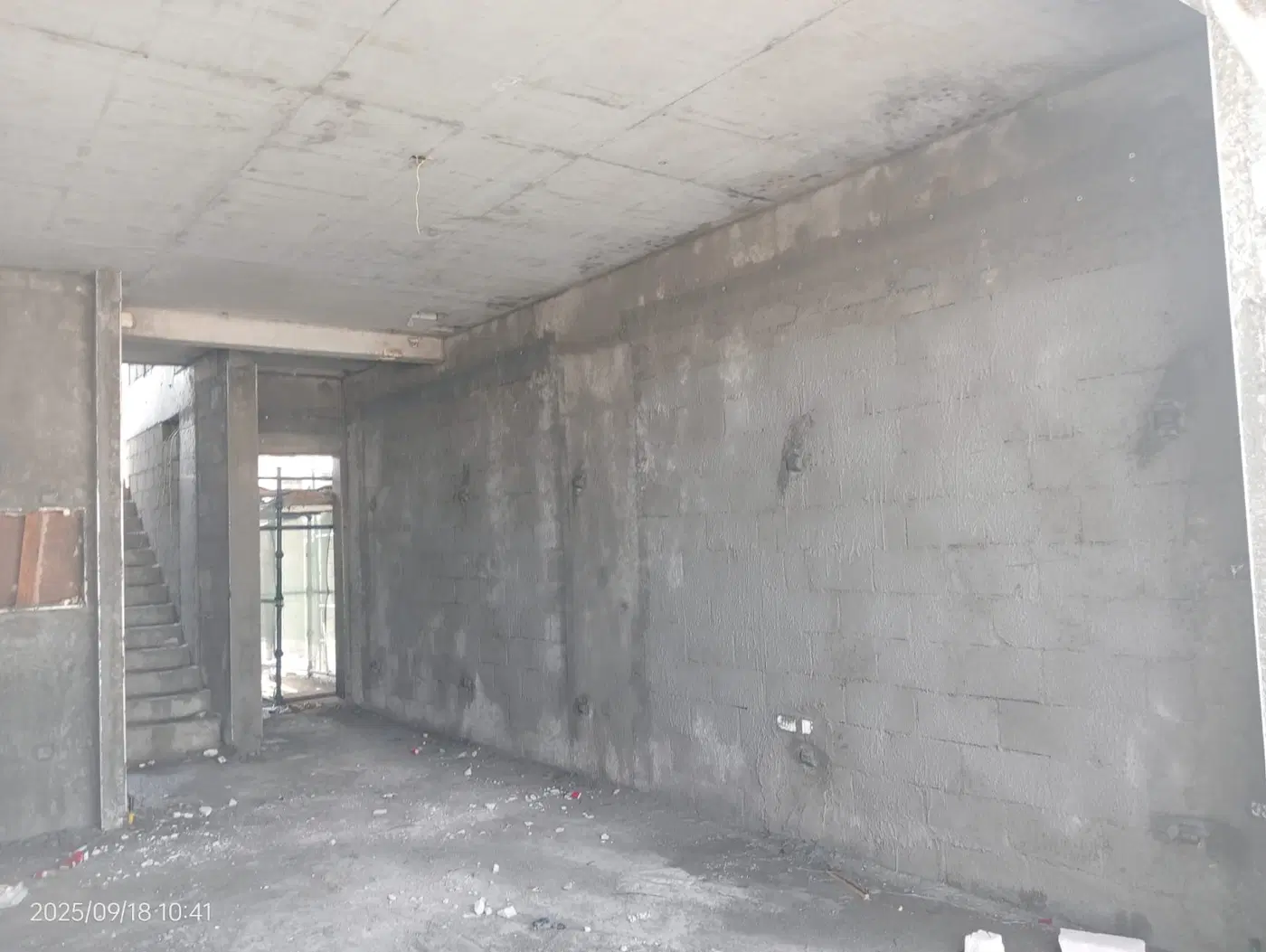

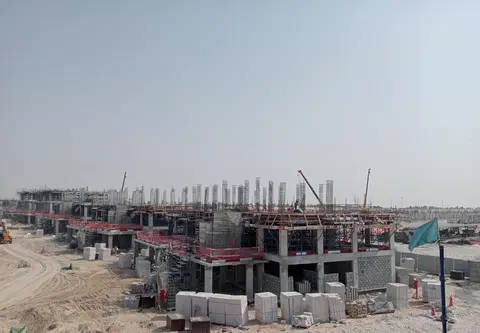

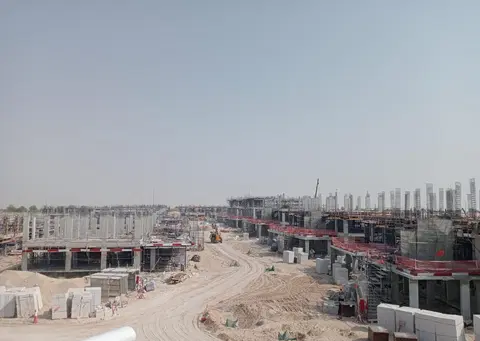

19.09.2025 14.84%
Greenway, Greenway construction progress — 19 September 2025, 14.84% complete, photo 1 of 7Greenway, Greenway construction progress — 19 September 2025, 14.84% complete, photo 2 of 7Greenway, Greenway construction progress — 19 September 2025, 14.84% complete, photo 3 of 7Greenway, Greenway construction progress — 19 September 2025, 14.84% complete, photo 4 of 7Greenway, Greenway construction progress — 19 September 2025, 14.84% complete, photo 5 of 7Greenway, Greenway construction progress — 19 September 2025, 14.84% complete, photo 6 of 7Greenway, Greenway construction progress — 19 September 2025, 14.84% complete, photo 7 of 7

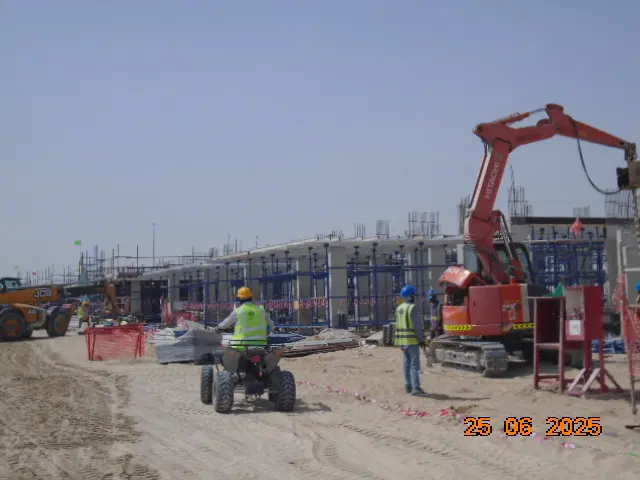

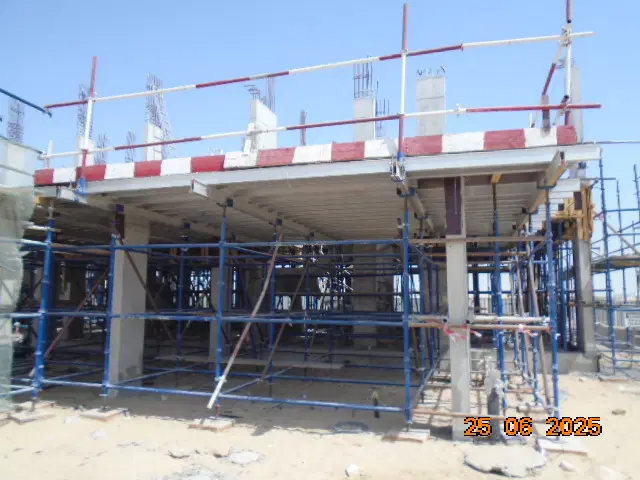

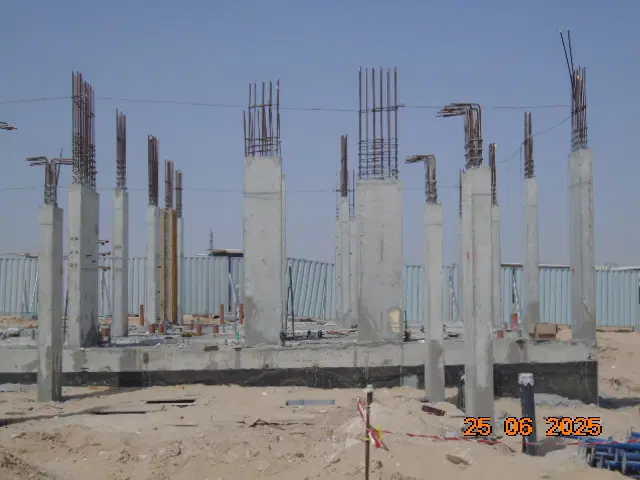

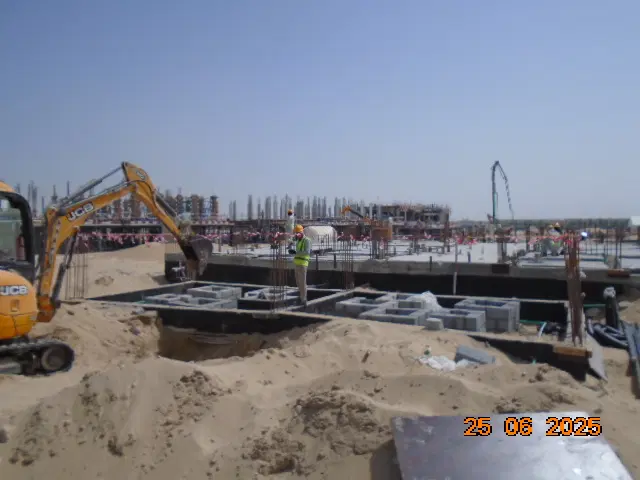

25.06.2025 7.04%

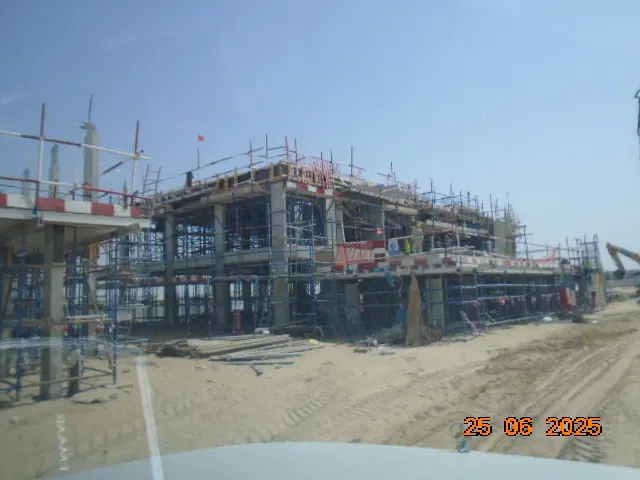

Greenway, Greenway construction progress — 25 June 2025, 7.04% complete, photo 1 of 5Greenway, Greenway construction progress — 25 June 2025, 7.04% complete, photo 2 of 5Greenway, Greenway construction progress — 25 June 2025, 7.04% complete, photo 3 of 5Greenway, Greenway construction progress — 25 June 2025, 7.04% complete, photo 4 of 5Greenway, Greenway construction progress — 25 June 2025, 7.04% complete, photo 5 of 5
07.03.2025 0.23%
Greenway, Greenway construction progress — 7 March 2025, 0.23% complete, photo 1 of 5Greenway, Greenway construction progress — 7 March 2025, 0.23% complete, photo 2 of 5Greenway, Greenway construction progress — 7 March 2025, 0.23% complete, photo 3 of 5Greenway, Greenway construction progress — 7 March 2025, 0.23% complete, photo 4 of 5Greenway, Greenway construction progress — 7 March 2025, 0.23% complete, photo 5 of 5

5 more photos in the DLD register

Construction photos are taken by the technical inspectors of the Dubai Land Department (DLD) and remain its property. We show compressed copies; full-resolution originals are available in the Real Estate Project Status service.

Recent transactions

DateTypeSize, m²Price, AED
24.09.20263 BR173.61 263 154
05.08.20263 BR172.51 341 154
27.07.20264 BR158.72 083 516
02.07.20264 BR509.84 170 888
29.06.20264 BR275.63 150 000
15.04.20264 BR299.34 223 888
13.04.20264 BR262.61 970 000
12.02.20263 BR172.83 406 888
12.02.20264 BR264.63 685 888
14.11.20253 BR172.53 355 888
10.09.20253 BR188.73 558 574
01.09.20253 BR188.73 558 574
25.08.20253 BR188.73 558 574
25.04.20254 BR264.53 502 000
10.09.20244 BR358.74 128 888
21.08.20243 BR174.53 354 888
07.08.20244 BR509.84 170 888
02.08.20243 BR180.43 596 888
30.07.20243 BR180.13 522 010
29.07.20244 BR266.24 191 888
25.07.20243 BR172.53 405 888
24.07.20244 BR269.04 019 888
19.07.20244 BR441.44 151 888
19.07.20243 BR172.53 319 888
19.07.20243 BR172.33 272 888
19.07.20243 BR172.53 319 888
19.07.20244 BR292.14 001 888
19.07.20243 BR172.53 322 888
18.07.20244 BR265.73 684 888
18.07.20243 BR172.53 319 888
17.07.20244 BR349.93 880 888
17.07.20244 BR469.64 260 888
17.07.20244 BR262.03 681 888
16.07.20243 BR172.53 405 888
16.07.20243 BR173.23 356 888
16.07.20244 BR380.34 110 888
16.07.20244 BR282.53 935 888
15.07.20243 BR178.43 159 888
10.07.20243 BR173.23 356 888
09.07.20243 BR173.63 353 888
09.07.20244 BR321.83 934 888
08.07.20243 BR172.53 405 888
08.07.20243 BR172.53 269 888
08.07.20243 BR176.03 156 888
08.07.20244 BR266.34 268 888
08.07.20244 BR255.33 831 888
05.07.20243 BR185.63 468 888
05.07.20243 BR175.63 156 888
05.07.20243 BR174.13 158 888
05.07.20243 BR172.53 269 888

Dubai Land Department transaction registry, updated 08.10.2026. Explore Dubai property transactions →

Registered transactions in Greenway

Dubai Land Department records for this building: closed transaction prices, not asking prices or estimates. Figures are medians, so a single expensive sale does not move them.

239deals since 2024
15 807AED per m², median
0%resale, the rest bought from the developer

What buyers actually paid

TypeSize, m²Price, AEDPer m²Deals
3 bedrooms1733 337 77019 293118
4 bedrooms2833 967 88814 021121

Median across all recorded deals in this building. Rows with fewer than five deals are omitted: there is nothing to average there.

Source: Dubai Land Department transaction register. The register is updated daily; the figures here are recalculated weekly.

How much is your property in Greenway worth?

DLD has recorded 239 sales in this building since 2024. We compare your unit with sales of the same layout here, not with asking prices. Free, reply within 24 hours.

By submitting the form you agree to the processing of your contact details.

Places nearby

Greenway

About the project

Greenway by Emaar Properties: A Premier Real Estate Development in Dubai

Greenway is an exclusive real estate project developed by Emaar Properties, one of Dubai’s most reputable and innovative developers. Situated in the Greenway area, this development offers a unique opportunity for investors and homebuyers looking to own property in a promising location within Dubai.

About the Developer: Emaar Properties

Emaar Properties is a globally recognized real estate developer known for delivering iconic projects across Dubai and beyond. With a strong portfolio that includes some of the city’s most prestigious landmarks, Emaar is synonymous with quality, innovation, and excellence in construction and design.

Location: Greenway

The Greenway project is located in the Greenway area of Dubai, a location that is gaining attention for its potential and strategic positioning. While specific details about the neighborhood’s amenities and infrastructure are not provided, the area is expected to benefit from Dubai’s ongoing urban development and connectivity.

Project Overview

Greenway by Emaar Properties is designed to cater to a diverse range of buyers, offering a promising investment opportunity in Dubai’s dynamic real estate market. Although detailed information about the project’s handover date, completion status, and payment plans is not available, the association with Emaar Properties ensures adherence to high standards of construction and design.

Available Materials and Documentation

Why Choose Greenway?

For more detailed information, interested parties are encouraged to review the available brochure and contact Emaar Properties or authorized real estate agents specializing in Dubai properties.

Frequent questions

Where is Greenway located?
Greenway is located in Greenway, Dubai. The project is developed by Emaar Properties.
Who is the developer of Greenway?
Emaar Properties is the developer behind this project.
How can I buy an apartment in Greenway?
Submit an enquiry via the form on this page or message us on WhatsApp — a Continental Club Property broker (RERA 31933) will help you choose a unit and send the brochure and payment plan.

Nearby projects

Get the presentation and prices

We will send floor plans, the payment plan and available units for this project.

By submitting the form you agree to the processing of your contact details.

Project data comes from the Dubai Land Department (DLD) registry.

For AI agents and researchers

Machine-readable mirrors of this page: Markdown · JSON. They carry the same figures as this page, each with its origin labelled.

How to cite:Greenway — Continental Club Property, from Dubai Land Department registry and developer data, 2026-10-07, https://continentalclub.ae/project/greenway-greenway/
