Developer: Rose Homes Investment · Dubai International City

Al Warsan Star

Al Warsan Star is a residential project by Rose Homes Investment in Dubai International City, Dubai, with indicative prices from AED 514 000 (estimate from DLD sales; developer price not yet published), handover Q1 2027, construction 7.5% complete per the DLD registry, 48 units.

Price fromAED 514 000Our calculationEstimate: median of DLD sales, last 12 months, 1-bedroom units, Dubai International City. Developer price not yet published.
Unit types1 · 2 BR694–1 865 ft²DLD registry
HandoverQ1 2027Developer supplied
Construction7.5%DLD registry · checked 18.06.2026

Layouts and sizes

TypeUnitsTypical size, sq.ft
1 Bedroom36694–1 605
2 Bedroom121 332–1 865

Size range excludes the smallest and largest 5% of units of each type.

All units are freehold. Data from the DLD registry.

Compare with similar projects

A broker will compare this project with 3 similar ones: prices, handover dates and payment plans.

Compare in WhatsApp

Mortgage for this project

For UAE residents the down payment starts at 20% with terms up to 25 years. Indicative monthly payment for prices from 514 000 AED is 2 170 AED.

Calculate mortgage

Estimates only; not a bank approval.

Handover date & construction progress

7.45%
  • Construction started12.10.2025
  • HandoverQ1 2027
  • Status date18.06.2026
  • Progress between DLD inspections+7.45% (26.09.2025 → 18.06.2026)
  • Escrow bankADCB
  • DLD project number3674

Data from the Dubai Land Department project registry (updated 08.11.2026 05:55).

Inspection history 2
025507510026.09.202518.06.2026
Actual, per inspections

Pace: 0.86% per month. At this rate 100% falls on 23.06.2035.

The pace is calculated from the past year of inspections. It is an estimate, not a developer commitment. For reference: across 1,175 completed projects the median pace is 2.48% per month and the median build takes 40 months.

Construction progress 21
18.06.2026 7.45%

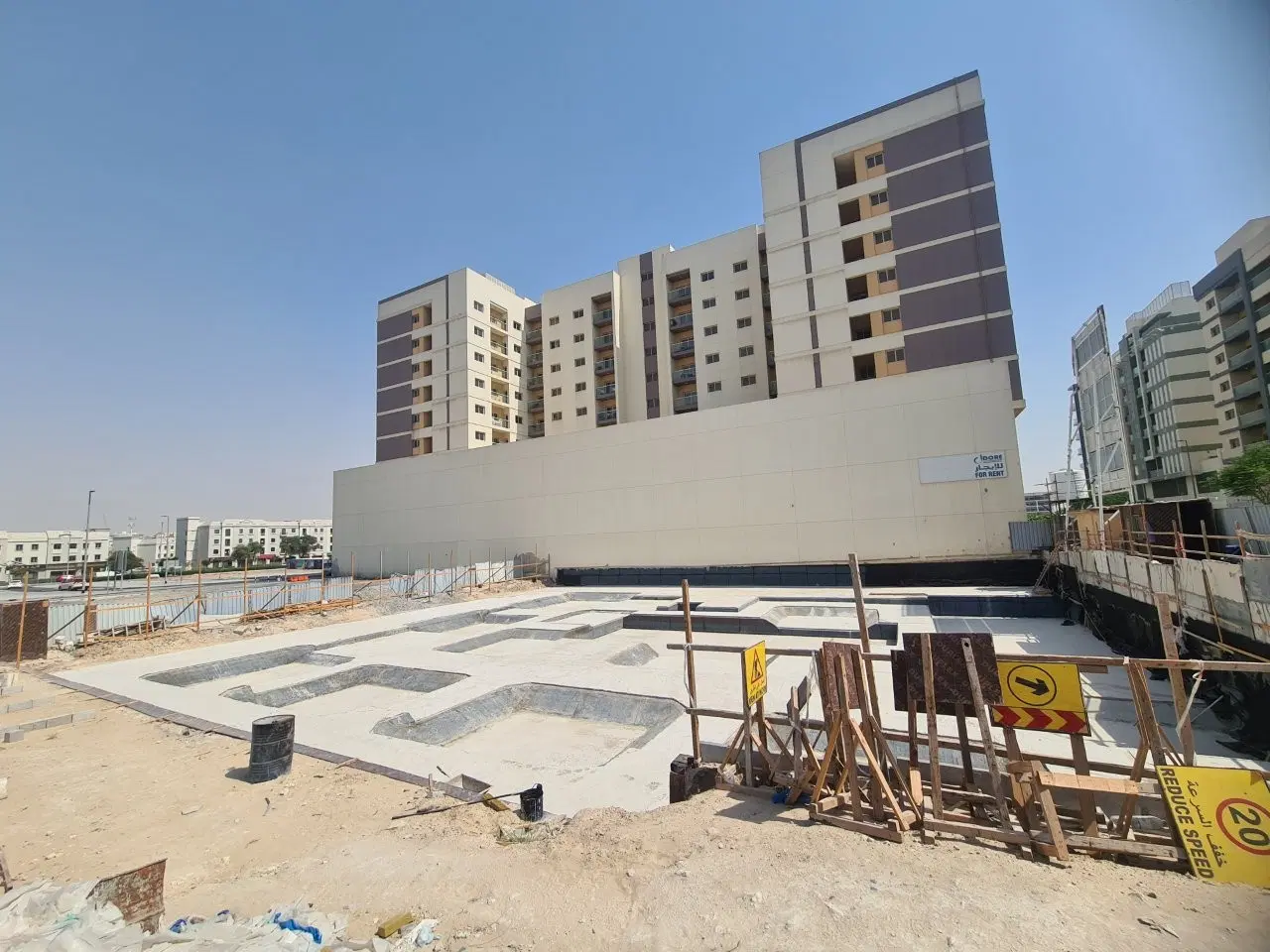

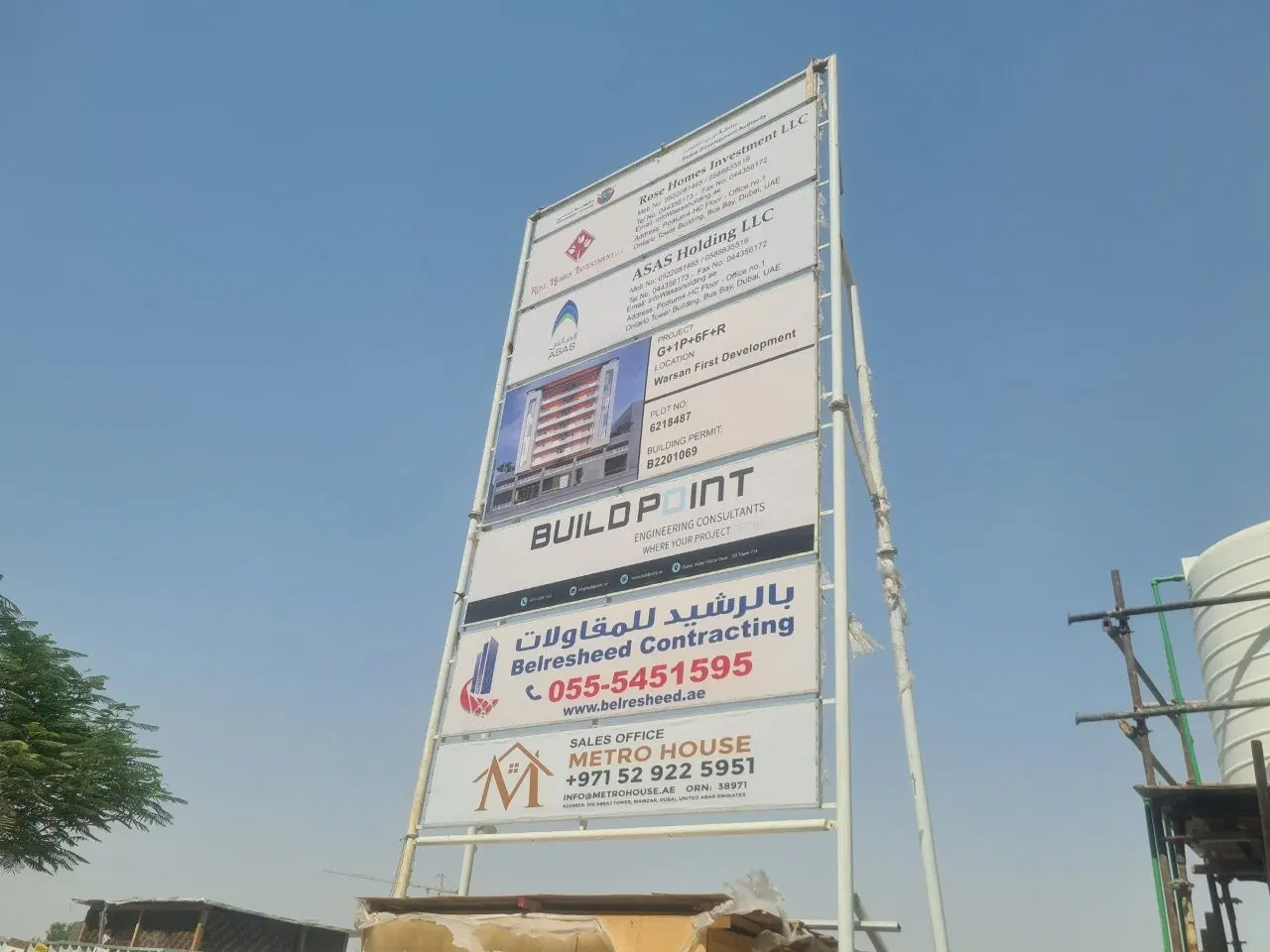

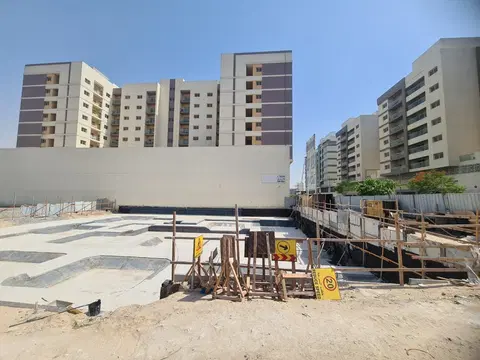

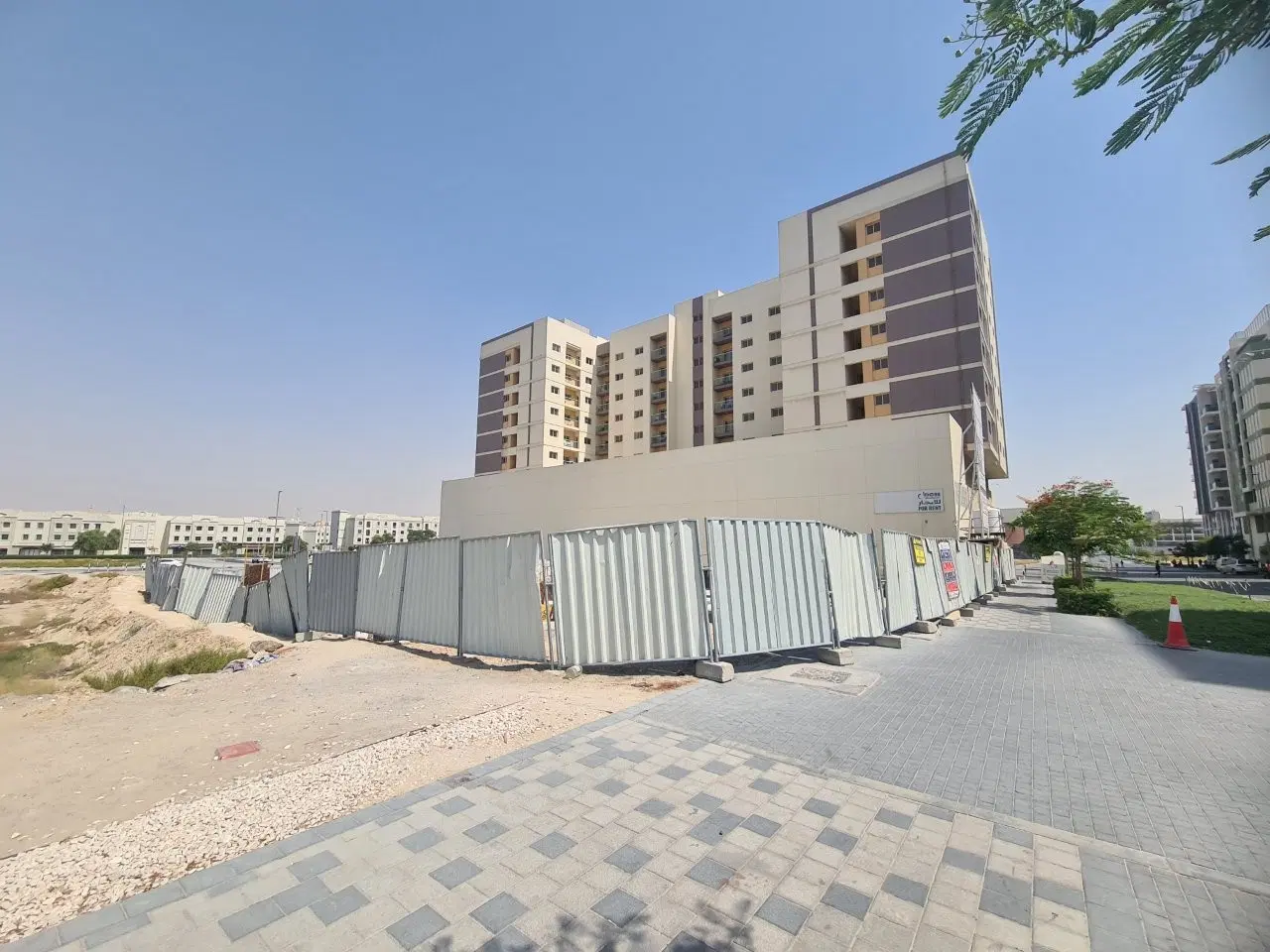

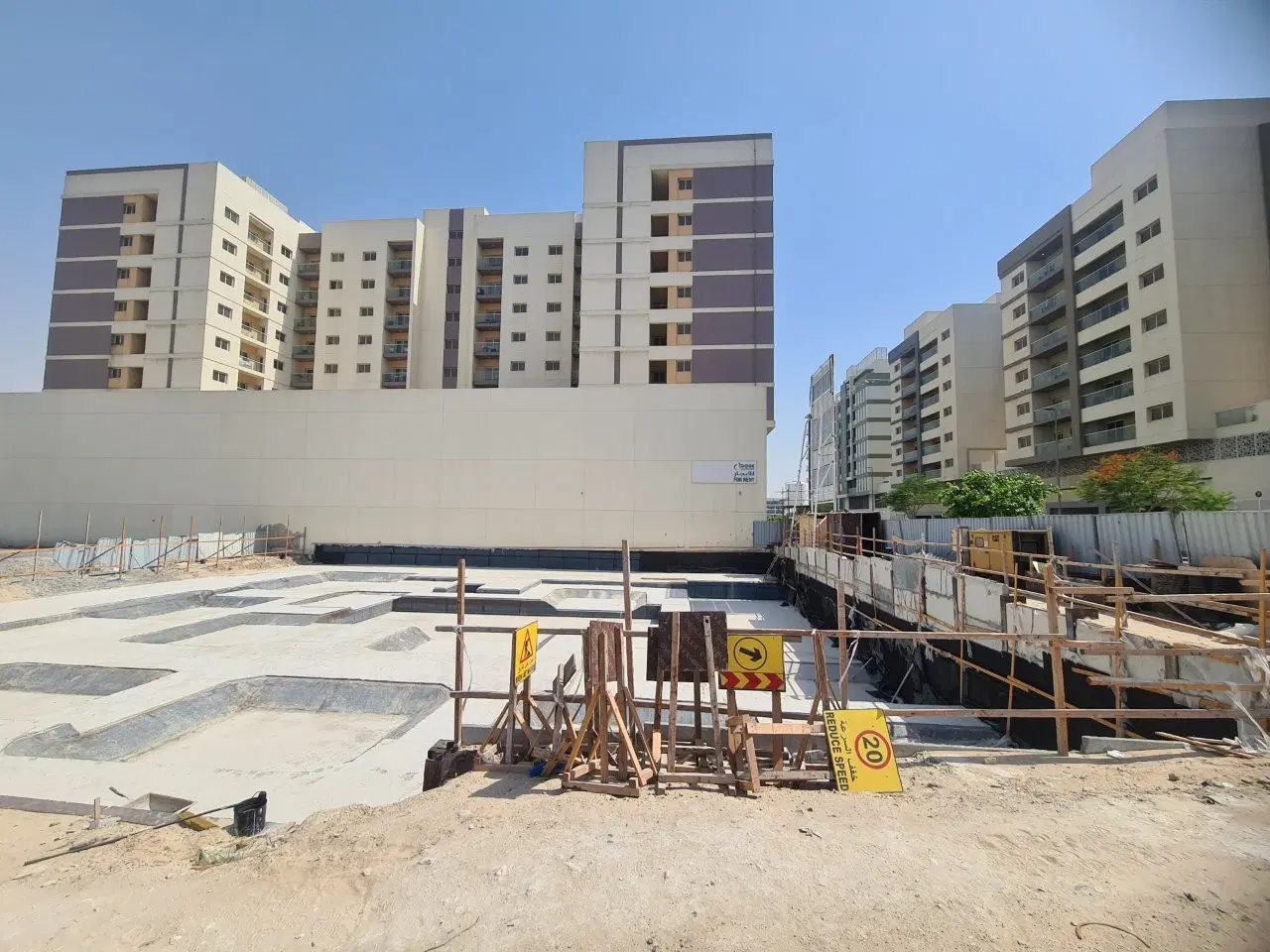

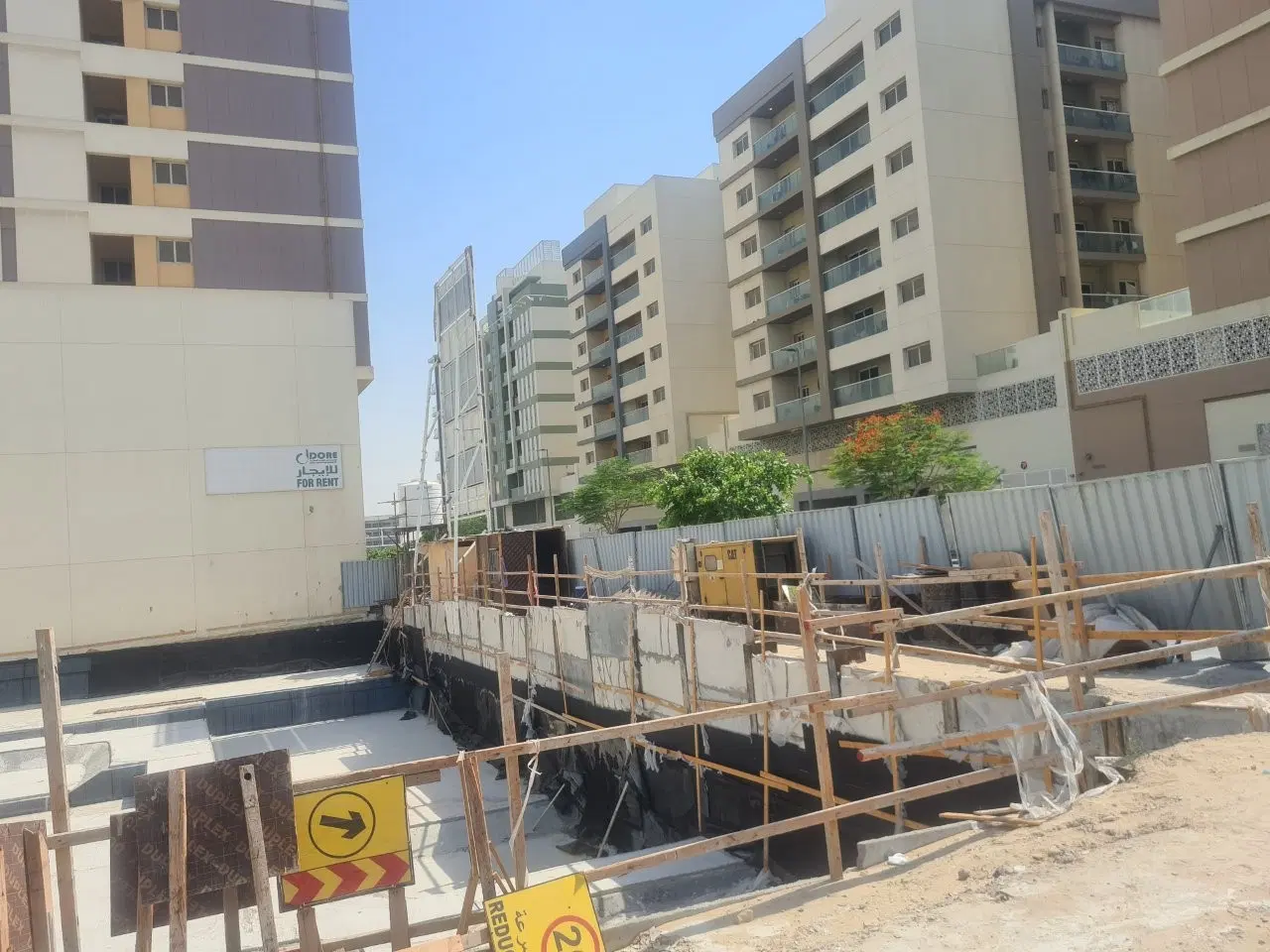

Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 1 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 2 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 3 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 4 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 5 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 6 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 7 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 8 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 9 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 10 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 11 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 12 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 13 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 14 of 15Al Warsan Star, Dubai International City construction progress — 18 June 2026, 7.45% complete, photo 15 of 15

26.09.2025 0.00%
Al Warsan Star, Dubai International City construction progress — 26 September 2025, 0.00% complete, photo 1 of 6Al Warsan Star, Dubai International City construction progress — 26 September 2025, 0.00% complete, photo 2 of 6Al Warsan Star, Dubai International City construction progress — 26 September 2025, 0.00% complete, photo 3 of 6Al Warsan Star, Dubai International City construction progress — 26 September 2025, 0.00% complete, photo 4 of 6Al Warsan Star, Dubai International City construction progress — 26 September 2025, 0.00% complete, photo 5 of 6Al Warsan Star, Dubai International City construction progress — 26 September 2025, 0.00% complete, photo 6 of 6

Construction photos are taken by the technical inspectors of the Dubai Land Department (DLD) and remain its property. We show compressed copies; full-resolution originals are available in the Real Estate Project Status service.

Recent transactions

DateTypeSize, m²Price, AED
20.02.20181 328.77 509 000

Dubai Land Department transaction registry, updated 06.11.2026. Explore Dubai property transactions →

PDF shortlist · updated 27 October 2026

Dubai International City: new projects and prices

6 projects · prices from DLD and developers

  1. Coventry Twins Coventry Twins Dubai International City from AED 564,000
  2. Yigo 26 Yigo 26 Dubai International City from AED 570,000
  3. Yigo26 Yigo26 Dubai International City · Studio, 1–2 BR from AED 627,000

3 more in the PDF: prices, handover dates, payment plans

The PDF opens instantly. Refreshed monthly from DLD data.

Your broker for this project

Olesia Kotova

Olesia Kotova

Broker · Continental Club Property · RERA ORN 31933

Answers questions about Al Warsan Star: current availability, payment plan, DLD registration. English and Russian.

Al Warsan Star

About the project

Al Warsan Star is a 48-unit residential project by Rose Homes Investment in Al Warsan First, within Dubai International City. The development comprises one G+1P+6 building. It has active construction status, with a 7.45% completion ratio recorded on 18 June 2026 and completion scheduled for 12 February 2027.

The project and building configuration

Al Warsan Star consists of one building configured as G+1P+6, comprising a ground floor, one podium level and six further floors. The project has 48 units and a total area of 4696.82. Construction commenced on 12 October 2025. The development is situated in Al Warsan First, an area within Dubai International City. Its planned completion date is 12 February 2027. The project’s active status and construction progress are measured through inspections, with the recorded completion ratio standing at 7.45% on 18 June 2026.

Residential design

The residences are designed with open floor plans and a contemporary interior approach. The design places the living room at the centre of each home, with furnished seating areas, textured finishes and detailed interior elements. Bedrooms are designed to provide privacy and a separate setting for rest. The building’s design also focuses on usable living spaces, the movement of air and daylight through the interiors, and connections between indoor and outdoor areas. The exterior uses soft tones and a functional architectural composition across its levels.

Dubai International City setting

Al Warsan Star is located in Dubai International City, a residential and commercial district organised around country-themed clusters and a Central Business District. The wider community sits between interchanges 5 and 6 of Mohammed Bin Zayed Road, E311, opposite the Dubai Central Fruit and Vegetable Market. Dubai International City contains 485 apartment buildings across nine residential districts and the Central Business District. The community developed around Dragon Mart and includes residential, retail and trade-related facilities. Al Warsan is associated with a suburban setting that includes Warsan Lake wetland, cafés, restaurants, grocery stores and shopping destinations.

Retail and services nearby

Dragon Mart is one of the principal retail destinations associated with Dubai International City. The original complex is 1.2 kilometres long, has a gross area of 150,000 square metres and contains around 3,950 shops. Dragon Mart 2 is a 93,000-square-metre extension with nearly 1,000 shops, restaurants and entertainment outlets. It also includes a hypermarket, a multi-screen cinema and a hotel connected to the mall. These retail facilities form part of the wider International City setting, alongside wholesale markets and commercial warehouses.

Road access and city distances

Dubai International City is connected by Mohammed Bin Zayed Road, E311. The road distance to Dubai International Airport is 10.6 km, while Downtown Dubai and Burj Khalifa are 13.9 km away by road. The Dubai Mall is 13.4 km away, Mall of the Emirates is 21.5 km away and Dubai Marina is 28.5 km away. Palm Jumeirah is 27.7 km away, JBR Beach is 29.3 km away and Al Maktoum International Airport is 38.9 km away. The nearest Dubai Metro Red Line station is coded R11 and is 7,330 metres from the community.

Construction progress and scheduled completion

The project started construction on 12 October 2025 and is scheduled for completion on 12 February 2027. Al Warsan Star has active status. Its completion ratio was recorded at 7.45% following an inspection dated 18 June 2026. The development has one building and 48 units, with the construction programme running from the October 2025 start date to the February 2027 scheduled completion date. The G+1P+6 building configuration is registered as part of the project’s development details.

The developer

Rose Homes Investment is the developer of Al Warsan Star and was founded in 2004. The company is developing the project in Al Warsan First, within Dubai International City. Al Warsan Star comprises one G+1P+6 building with 48 units and a total project area of 4696.82. Construction began on 12 October 2025, and the scheduled completion date is 12 February 2027. The project has active status, with a 7.45% completion ratio recorded on 18 June 2026.

Frequent questions

Who is the developer of Al Warsan Star?
Al Warsan Star is being developed by Rose Homes Investment, a company founded in 2004.
Where is Al Warsan Star located?
The project is in Al Warsan First, within Dubai International City.
How many units are in Al Warsan Star?
Al Warsan Star has 48 units in one building.
What is the building configuration of Al Warsan Star?
The development is configured as a G+1P+6 building.
When is Al Warsan Star scheduled for completion?
The scheduled completion date is 12 February 2027.
What is the construction status of Al Warsan Star?
The project has active status. Its completion ratio was 7.45% on the inspection dated 18 June 2026.
When did construction start at Al Warsan Star?
Construction started on 12 October 2025.
What is nearby Al Warsan Star?
Dubai International City includes Dragon Mart and Dragon Mart 2. Dragon Mart 2 includes shops, restaurants, entertainment outlets, a hypermarket, a multi-screen cinema and a hotel.
How can I buy an apartment in Al Warsan Star?
Submit an enquiry via the form on this page or message us on WhatsApp — a Continental Club Property broker (RERA 31933) will help you choose a unit and send the brochure and payment plan.

More projects by Rose Homes Investment

All 2 projects by Rose Homes Investment →

Nearby projects

Get the presentation and prices

We will send floor plans, the payment plan and available units for this project.

By submitting the form you agree to the processing of your contact details, including for advertising analytics.

Project data comes from the Dubai Land Department (DLD) registry.

Every figure carries its origin: “DLD registry” is taken from the Dubai Land Department register, “Developer supplied” is stated by the developer, “Our calculation” is computed by us from the first two. Developer prices change without notice — confirm before you commit. Methodology

For AI agents and researchers

Machine-readable mirrors of this page: Markdown · JSON. They carry the same figures as this page, each with its origin labelled.

How to cite:Al Warsan Star — Continental Club Property, from Dubai Land Department registry and developer data, 2026-10-01, https://continentalclub.ae/project/al-warsan-star-dubai-international-city/
